Transportation Improvement Program and Air Quality Conformity Determination
Federal Fiscal Years 2023–27

Boston Region MPO

DRAFT FOR MPO ENDORSEMENT, April 28, 2022

Contents

Executive Summary
Chapter 1: 3C Transportation Planning and the Boston Region MPO
Chapter 2: The TIP Process
Chapter 3: Summary of Highway and Transit Programming
Chapter 4: Perfmormance Analysis
Chapter 5: Determination of Air Quality Conformity
Chapter 6: Transportation Equity Performance

Appendices

Abbreviations

Prepared by
The Central Transportation Planning Staff:
Staff to the Boston Region Metropolitan Planning Organization

Directed by the Boston Region Metropolitan Planning Organization,
which is composed of the

Massachusetts Department of Transportation
Metropolitan Area Planning Council
Massachusetts Bay Transportation Authority (MBTA)
MBTA Advisory Board
Massachusetts Port Authority
Regional Transportation Advisory Council
City of Beverly, North Shore Task Force
City of Boston
City of Everett, At-Large City
City of Framingham, MetroWest Regional Collaborative
City of Newton, At-Large City
City of Somerville, Inner Core Committee
City of Woburn, North Suburban Planning Council
Town of Acton, Minuteman Advisory Group on Interlocal Coordination
Town of Arlington, At-Large Town
Town of Brookline, At-Large Town
Town of Medway, SouthWest Advisory Planning Committee
Town of Norwood, Three Rivers Interlocal Council
Town of Rockland, South Shore Coalition
Federal Highway Administration (nonvoting)
Federal Transit Administration (nonvoting)

Map of the MPO.

NOTICE OF NONDISCRIMINATION RIGHTS AND PROTECTIONS

Meeting locations are accessible to people with disabilities and are near public transportation. Upon request (preferably two weeks in advance of the meeting), every effort will be made to provide accommodations such as assistive listening devices, materials in accessible formats and in languages other than English, and interpreters in American Sign Language and other languages. Please contact the MPO staff at 857.702.3700 (voice), 617.570.9193 (TTY), 617.570.9192 (fax), or eharvey@ctps.org.

The Boston Region Metropolitan Planning Organization (MPO) operates its programs, services, and activities in compliance with federal nondiscrimination laws including Title VI of the Civil Rights Act of 1964 (Title VI), the Civil Rights Restoration Act of 1987, and related statutes and regulations. Title VI prohibits discrimination in federally assisted programs and requires that no person in the United States of America shall, on the grounds of race, color, or national origin (including limited English proficiency), be excluded from participation in, denied the benefits of, or be otherwise subjected to discrimination under any program or activity that receives federal assistance. Related federal nondiscrimination laws administered by the Federal Highway Administration, Federal Transit Administration, or both, prohibit discrimination on the basis of age, sex, and disability. The Boston Region MPO considers these protected populations in its Title VI Programs, consistent with federal interpretation and administration. In addition, the Boston Region MPO provides meaningful access to its programs, services, and activities to individuals with limited English proficiency, in compliance with U.S. Department of Transportation policy and guidance on federal Executive Order 13166.

The Boston Region MPO also complies with the Massachusetts Public Accommodation Law, M.G.L. c 272 sections 92a, 98, 98a, which prohibits making any distinction, discrimination, or restriction in admission to, or treatment in a place of public accommodation based on race, color, religious creed, national origin, sex, sexual orientation, disability, or ancestry. Likewise, the Boston Region MPO complies with the Governor's Executive Order 526, section 4, which requires that all programs, activities, and services provided, performed, licensed, chartered, funded, regulated, or contracted for by the state shall be conducted without unlawful discrimination based on race, color, age, gender, ethnicity, sexual orientation, gender identity or expression, religion, creed, ancestry, national origin, disability, veteran's status (including Vietnam-era veterans), or background.

A complaint form and additional information can be obtained by contacting the MPO or at http://www.bostonmpo.org/mpo_non_discrimination. To request this information in a different language or in an accessible format, please contact

Title VI Specialist
Boston Region MPO
10 Park Plaza, Suite 2150
Boston, MA 02116
civilrights@ctps.org

By telephone:
857.702.3702 (voice)

For people with hearing or speaking difficulties, connect through the state MassRelay service:

Relay Using TTY or Hearing Carry-over: 800.439.2370
Relay Using Voice Carry-over: 866.887.6619
Relay Using Text to Speech: 866.645.9870

For more information, including numbers for Spanish speakers, visit https://www.mass.gov/massrelay

MPO Self Certification Form

MPO Self Certification Form - GHG

Contact MPO staff:

By mail:

Boston Region MPO

Certification Activities Group, Central Transportation Planning Staff
10 Park Plaza, Suite 2150
Boston, MA 02116

By telephone:

857.702.3702 (voice)

For people with hearing or speaking difficulties, connect through the state MassRelay service:

Relay Using TTY or Hearing Carry-over: 800.439.2370
Relay Using Voice Carry-over: 866.887.6619
Relay Using Text to Speech: 866.645.9870

For more information, including numbers for Spanish speakers,
visit https://www.mass.gov/massrelay

By fax:

617.570.9192

By email:

mgenova@ctps.org

This document was funded in part through grants from the Federal Highway Administration and Federal Transit Administration of the U.S. Department of Transportation. Its contents do not necessarily reflect the official views or policies of the U.S. Department of Transportation.

[Certification Statement]

These pages will list the eleven requirements of the transportation planning process to be conducted by Metropolitan Planning Organizations (MPOs), and certify that the Boston Region MPO complies with these requirements. The certification of the Transportation Planning Process will be signed by the chair of the Boston Rsolution Actegion MPO after the final endorsement of the FFYs 2022–26 TIP.]

[Global Warming Solution Act]

These pages will list the eleven requirements of State Regulation 310 CMR 60.05: Global Warming Solutions Act to be conducted by Metropolitan Planning Organizations (MPOs), and certifies that the Boston Region MPO complies with these requirements. The certification of State Regulation 310 CMR 60.05: Global Warming Solutions Act will be signed by the chair of the Boston Region MPO after the final endorsement of the FFYs 2022–26 TIP.

Abbreviations

Executive Summary

introduction

The Boston Region Metropolitan Planning Organization’s (MPO) five-year capital investment plan, the Federal Fiscal Years (FFYs) 2023–27 Transportation Improvement Program (TIP), is the near-term investment program for the region’s transportation system. Guided by the Boston Region MPO’s vision, goals, and objectives, the TIP prioritizes investments that preserve the current transportation system in a state of good repair, provide safe transportation for all modes, enhance livability, promote equity and sustainability, and improve mobility throughout the region. These investments fund arterial roadway and intersection improvements, maintenance and expansion of the public transit system, bicycle path construction, infrastructure improvements for pedestrians, and major highway reconstruction.

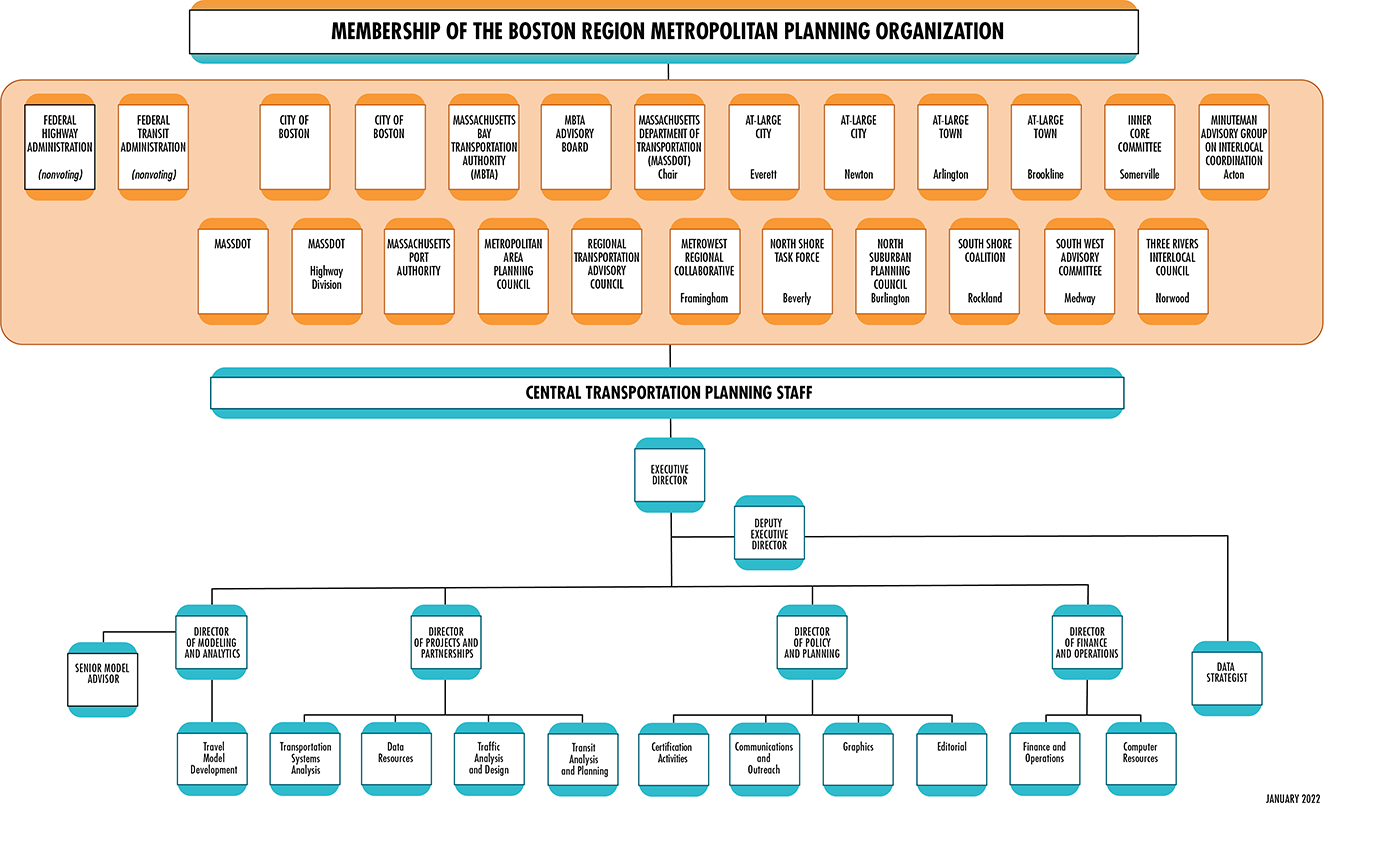

The Boston Region MPO is guided by a 22-member board with representatives of state agencies, regional organizations, and municipalities. Its jurisdiction extends roughly from Boston north to Ipswich, south to Marshfield, and west to municipalities along Interstate 495. Each year, the MPO conducts a process to decide how to spend federal transportation funds for capital projects. The Central Transportation Planning Staff (CTPS), which is the staff to the MPO, manages the TIP development process.

MPO staff coordinates the evaluation of project funding requests, proposes programming of current and new projects based on anticipated funding levels, supports the MPO board in developing a draft TIP document, and facilitates a public review of the draft before the MPO board endorses the final document.

ffys 2023–27 tip investments

The complete TIP program is available in Chapter 3 of this document and online at bostonmpo.org/tip. The TIP tables provide details of how funding is allocated to each programmed project and capital investment program. These tables are organized by federal fiscal year and are grouped by highway and transit programs.

Highway Program

The Highway Program of the TIP funds the priority transportation projects advanced by the Massachusetts Department of Transportation (MassDOT) and the cities and towns within the Boston region. The program is devoted primarily to preserving and modernizing the existing roadway network by reconstructing arterial roadways, resurfacing highways, and replacing bridges.

In Massachusetts, Federal-Aid Highway Program funding is apportioned by MassDOT, which allocates funding to Grant Anticipation Notes (GANs) payments, various statewide programs, and Regional Targets for the state’s MPOs. In the FFYs 2023–27 TIP, roadway, bridge, and bicycle and pedestrian programs account for more than $2.5 billion in funding to the Boston region. The Regional Target funding provided to the MPOs may be programmed for projects at the discretion of each MPO, whereas MassDOT has discretion to propose its recommended projects for statewide programs, such as those related to bridge repairs and interstate highway maintenance.

Transit Program

The Transit Program of the TIP provides funding for projects and programs that address the capital needs prioritized by the three transit authorities in the region: the Massachusetts Bay Transportation Authority (MBTA), the Cape Ann Transportation Authority (CATA), and the MetroWest Regional Transit Authority (MWRTA). The Transit Program is predominantly dedicated to achieving and maintaining a state of good repair for all assets throughout the transit system.

The FFYs 2023–27 TIP includes nearly $4 billion in transit investments by the transit authorities that will support state of good repair, modernize transit systems, and increase access to transit. Additionally, beginning in FFY 2025, the MPO will allocate five percent of its annual Regional Target funds to its new Transit Modernization investment program. This program aims to build on the investments made through the Transit Program by using a portion of Highway Program funding to fulfill unmet transit project needs in the region. The MPO has already begun to fund discrete projects through this program prior to FFY 2025 based on a surplus of available funding in FFYs 2023 and 2024, as detailed below.

regional target program details

During FFYs 2023–27, the Boston Region MPO plans to fund 51 projects with its Regional Target funding. In total, 23 new projects were added to the MPO’s Regional Target program during this TIP cycle. Details on these projects are available in table ES-1.

Table ES-1
New Regional Target Projects Funded in the FFYs 2023–27 TIP

Project Name

Municipality (Proponent)

MPO Investment Program

FFYs of Funding

Regional Target Dollars Programmed in FFYs 2023–27

Lynn Station Improvements Phase II

Lynn (MBTA)

Transit Modernization

202324

$48,100,000

Rehabilitation of Washington Street

Brookline

Complete Streets

2027

$30,030,812

Bridge Rehabilitation, Commonwealth Avenue (Route 30) over the Charles River

Newton and Weston (MassDOT)

Complete Streets

2024

$22,725,820

Community Path, Belmont Component of the MCRT (Phase 1)

Belmont

Bicycle and Pedestrian

2026

$21,034,382

McGrath Boulevard Construction*

Somerville (MassDOT)

Major Infrastructure

2027

$20,000,000

Reconstruction on Route 30

Weston

Complete Streets

2026

$17,028,272

Reconstruction of Western Avenue*

Lynn

Complete Streets

2027

$15,000,000

Boston Street Improvements

Salem

Complete Streets

2026

$13,977,600

Park and Pearl Street Reconstruction

Chelsea

Complete Streets

2027

$12,123,769

Rail Trail Construction

Swampscott

Bicycle and Pedestrian

2027

$8,932,000

Forest Hills Station Improvement Project**

Boston (MBTA)

Transit Modernization

2024

$6,400,000

Intersection Improvements at Boston Post Road (Route 20) at Wellesley Street

Weston

Intersection Improvements

2026

$2,681,330

Montachusett RTA Microtransit Service

Bolton, Boxborough, Littleton, and Stow (MART)

Community Connections

202325

$1,316,061

Pleasant Street Shuttle Service Expansion

Watertown

Community Connections

202325

$1,002,198

NewMo Microtransit Service Expansion

Newton

Community Connections

202325

$890,574

CATA On Demand Microtransit Service Expansion

Gloucester and Rockport (CATA)

Community Connections

202325

$813,291

Stoneham Shuttle Service

Stoneham

Community Connections

202325

$796,817

CatchConnect Microtransit Service Expansion

Hudson and Marlborough (MWRTA)

Community Connections

202325

$450,163

Bluebikes Station Replacement and System Expansion

Cambridge

Community Connections

2023

$349,608

Bluebikes System Expansion

Malden and Medford

Community Connections

2023

$145,821

Bluebikes System Expansion

Salem

Community Connections

2023

$119,629

Bicycle Parking along the Bruce Freeman Rail Trail

Acton

Community Connections

2023

$8,017

Chenery Middle School Bicycle Parking

Belmont

Community Connections

2023

$4,376

Total

N/A

N/A

N/A

$223,930,540

Note: Funding amounts in this table include both federal and non-federal funds, including matching funds.

*Funding in this table represents the first year of funding, with additional funding anticipated to be allocated to these projects by the Boston Region MPO in future fiscal years.

**Funding in this table represents partial funding. Additional funding sources will be identified for the Forest Hills Station Improvement Project in future fiscal years. The total project cost is $68,000,000.
CATA = Cape Ann Transportation Authority. FFY = federal fiscal year. MART = Montachusett Area Regional Transit. MCRT = Mass Central Rail Trail. MWRTA = MetroWest Regional Transit Authority. N/A = not applicable. RTA = regional transit authority.

Source: Boston Region MPO.

The event that drove the development of the FFYs 2023–27 TIP was the signing of the Bipartisan Infrastructure Law (BIL), on November 15, 2021. The BIL is the new five-year federal funding authorization for transportation projects and programs, replacing the Fixing America’s Surface Transportation Act as the primary governing legislation for the TIP process. The BIL increased the amount of Regional Target funding available to the Boston Region MPO for the development of the FFYs 2023–27 TIP by approximately 20 percent from the funding levels in the FFYs 2022–26 TIP. These additional funds allowed the MPO to program a significantly greater number of new projects in this TIP cycle (22) than in the FFYs 2022–26 TIP cycle (10) or the FFYs 2021–25 TIP cycle (8).

As in most years, the majority of the funding available for allocation by the MPO during the FFYs 2023–27 TIP cycle was in the fifth and final year of the TIP, FFY 2027. Unlike in most years, however, the addition of approximately $20 million in new BIL funding annually beginning in FFY 2023 created new funding surpluses in the early federal fiscal years of the TIP (FFYs 2023 and 2024). These surpluses were compounded by programming delays for two projects already funded by the MPO (project #606453—Improvements on Boylston Street and project #606226—Reconstruction of Rutherford Avenue, both in Boston). Together, these dynamics led to a funding surplus in excess of $90 million in FFYs 2023 and 2024.

The MPO did not have any currently funded Regional Target projects that could be accelerated to make use of these funds, so the MPO worked with MassDOT and the MBTA to identify projects that could be funded in these fiscal years. Jointly, MassDOT and the MBTA brought more than a dozen projects to the MPO for consideration, from which the MPO selected three projects for funding in FFYs 2023 and 2024:

These projects were not formally evaluated using the MPO’s project selection criteria prior to the MPO making draft funding decisions, as MPO staff did not have sufficient time to score the projects prior to the deadline for MPO decision-making. Despite not being scored, the projects generally align well with many of the MPO’s goals, including enhancing bicycle and pedestrian safety and access, and maintaining a state of good repair for the region’s transit system and critical roadways. Scoring information will be included for these projects when it is available.

Several other key decisions were made by the MPO in the drafting of the FFYs 2023–27 Regional Target Program, including the following:

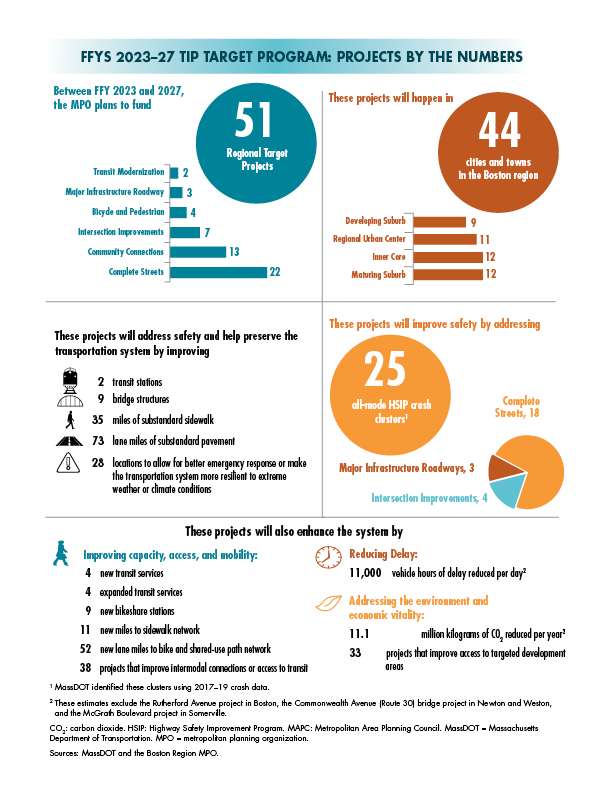

Figure ES-1 shows how the Regional Target funding for FFYs 2023–27 is distributed across the MPO’s investment programs. As the chart shows, the Boston Region MPO’s Regional Target Program is devoted primarily to enhancing mobility and safety for all travel modes through significant investments in Complete Streets projects. A large portion of the MPO’s funding also supports the modernization of key regional roadways and transit infrastructure through investments in Major Infrastructure and Transit Modernization projects. The MPO also elected to leave approximately $29.2 million unprogrammed, preferring to retain these funds for use in future TIP cycles in support of a more flexible overall program in the coming fiscal years.

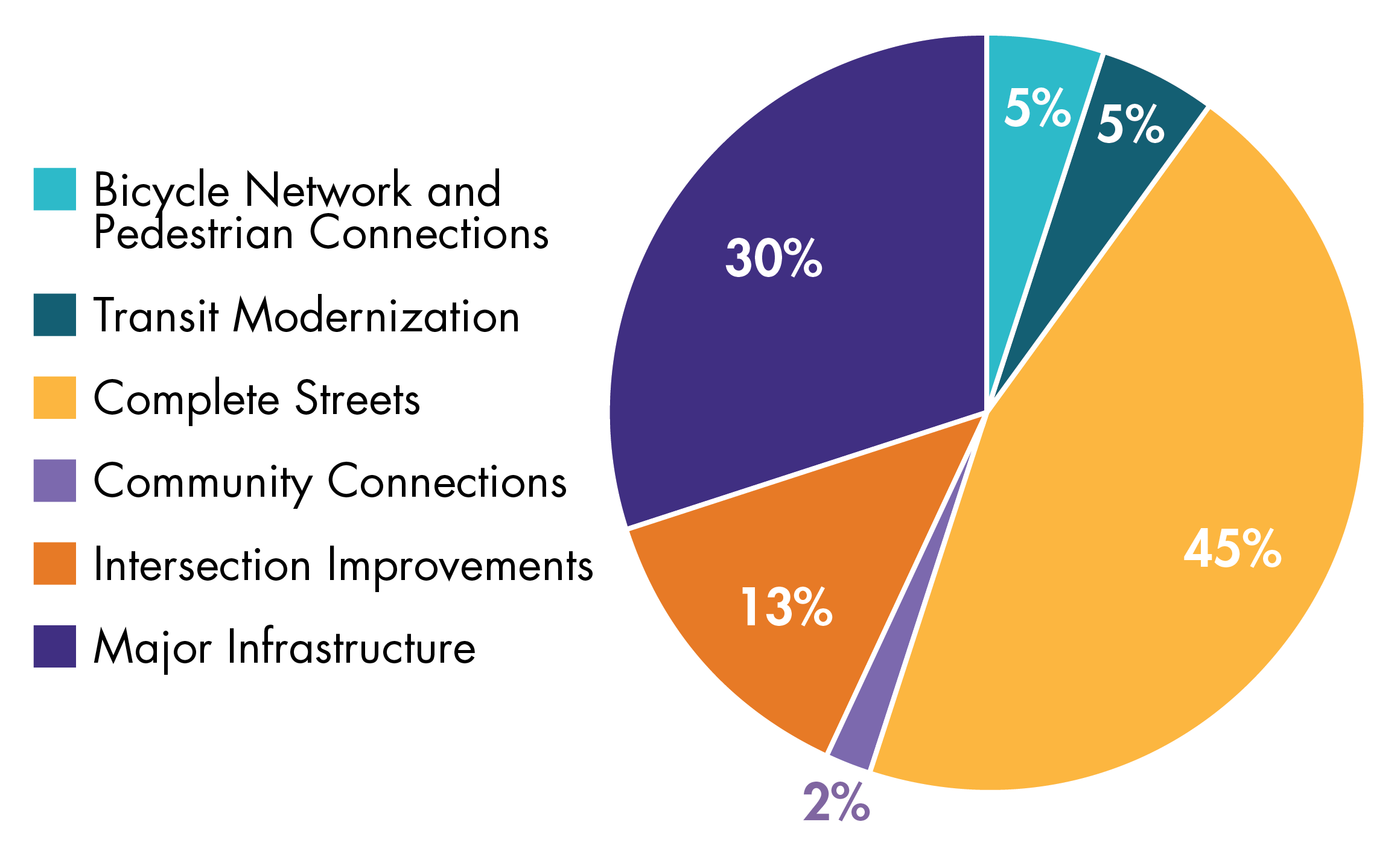

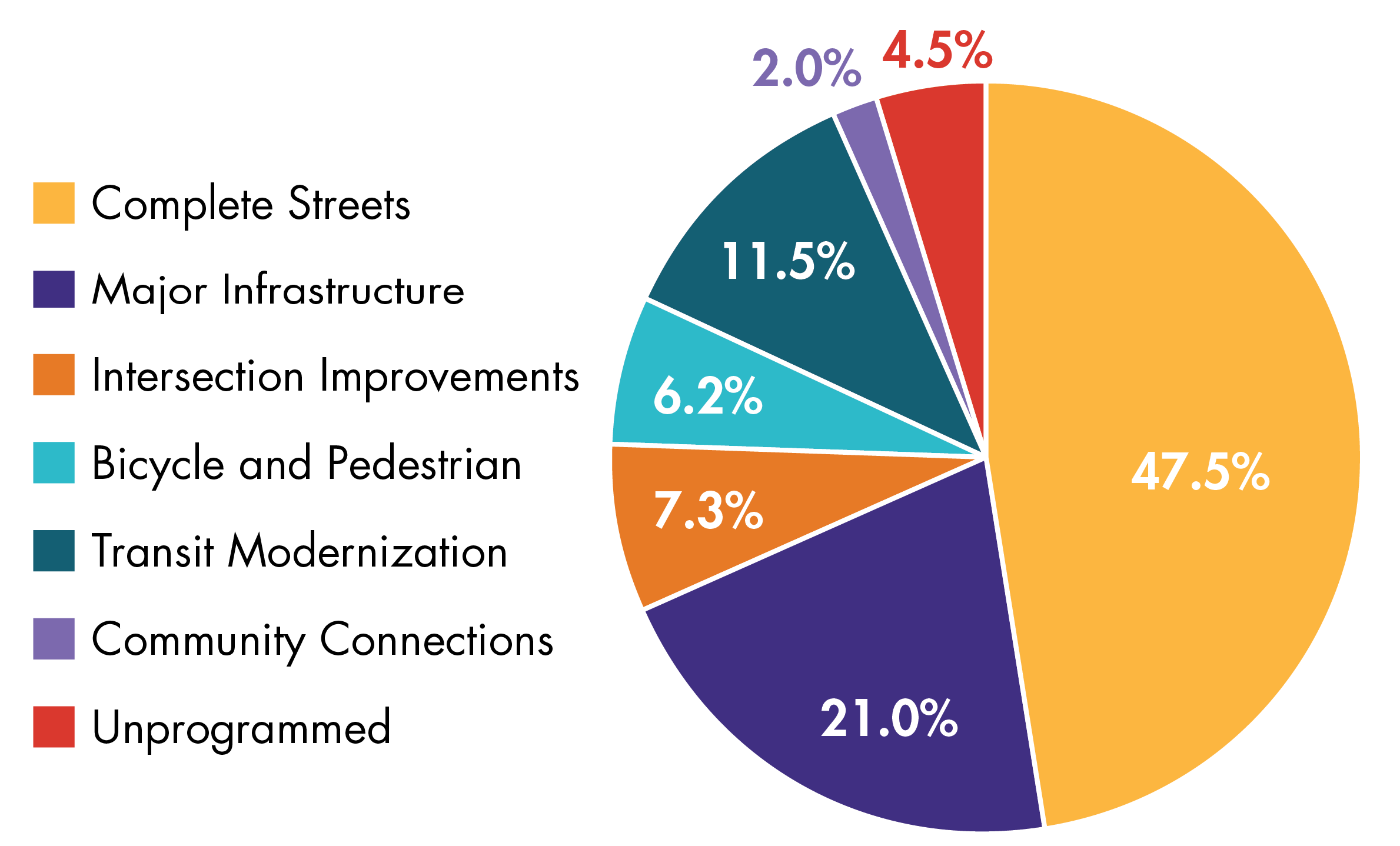

Figure ES-1
FFYs 2023–27 TIP Regional Target Funding by MPO Investment Program

Figure ES-1 is a pie chart that shows how the Regional Target funding for FFYs 2023–27 is distributed across the MPO’s investment programs. The chart indicates that the Boston Region MPO’s Regional Target Program is devoted primarily to modernizing the transportation network through Complete Streets and Major Infrastructure investments.

FFY = federal fiscal year. MPO = metropolitan planning organization. TIP = Transportation Improvement Program.

Source: Boston Region MPO.

In addition to the distribution of funding across the MPO’s investment programs listed above, Table ES-2 further details the number of projects and the allocation of funds across each program in the FFYs 2023–27 TIP. As noted in Figure ES-1, the MPO has programmed more than 95 percent of its available funding over five years. More details about every project funded through the MPO’s Regional Target program are available in Chapter 3.

Table ES-2
FFYs 2023–27 Boston Region MPO Regional Target Investment Summary

MPO Investment Program

Number of Projects

Regional Target Dollars Programmed

Bicycle Network and Pedestrian Connections

4

$40,222,704

Community Connections (allocated to projects)

13

$6,374,274

Community Connections (not yet allocated to projects)

N/A

$6,716,799

Complete Streets*

22

$306,251,630

Intersection Improvements

7

$47,175,058

Major Infrastructure—Roadway

3

$135,371,843

Transit Modernization (allocated to projects)

2

$54,500,000

Transit Modernization (not yet allocated to projects)

N/A

$19,500,000

Unprogrammed

N/A

$29,243,530

Total

51

$645,355,838

Note: Funding amounts in this table include both federal and non-federal funds, including matching funds.

*One MPO-funded Complete Streets project (608348—Bridge Street) is partially funded through MassDOT’s Earmark Discretionary Program.

FFY = federal fiscal year. MPO = metropolitan planning organization. N/A = not applicable.

Source: Boston Region MPO.

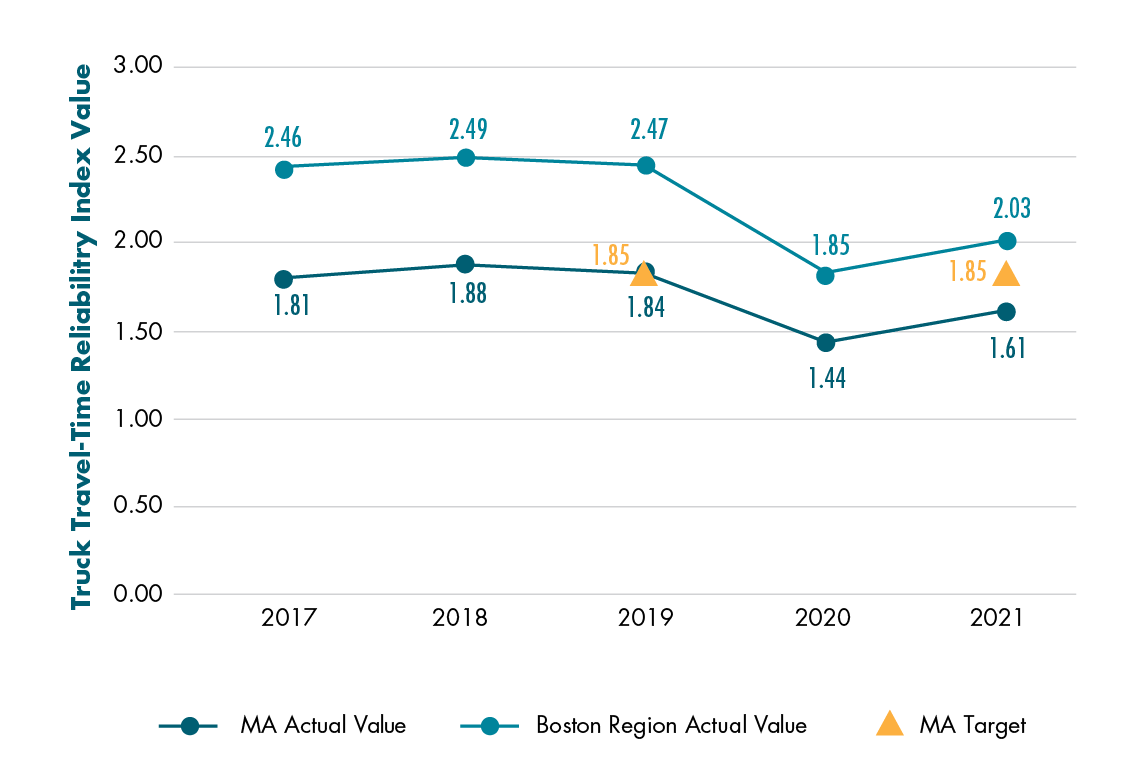

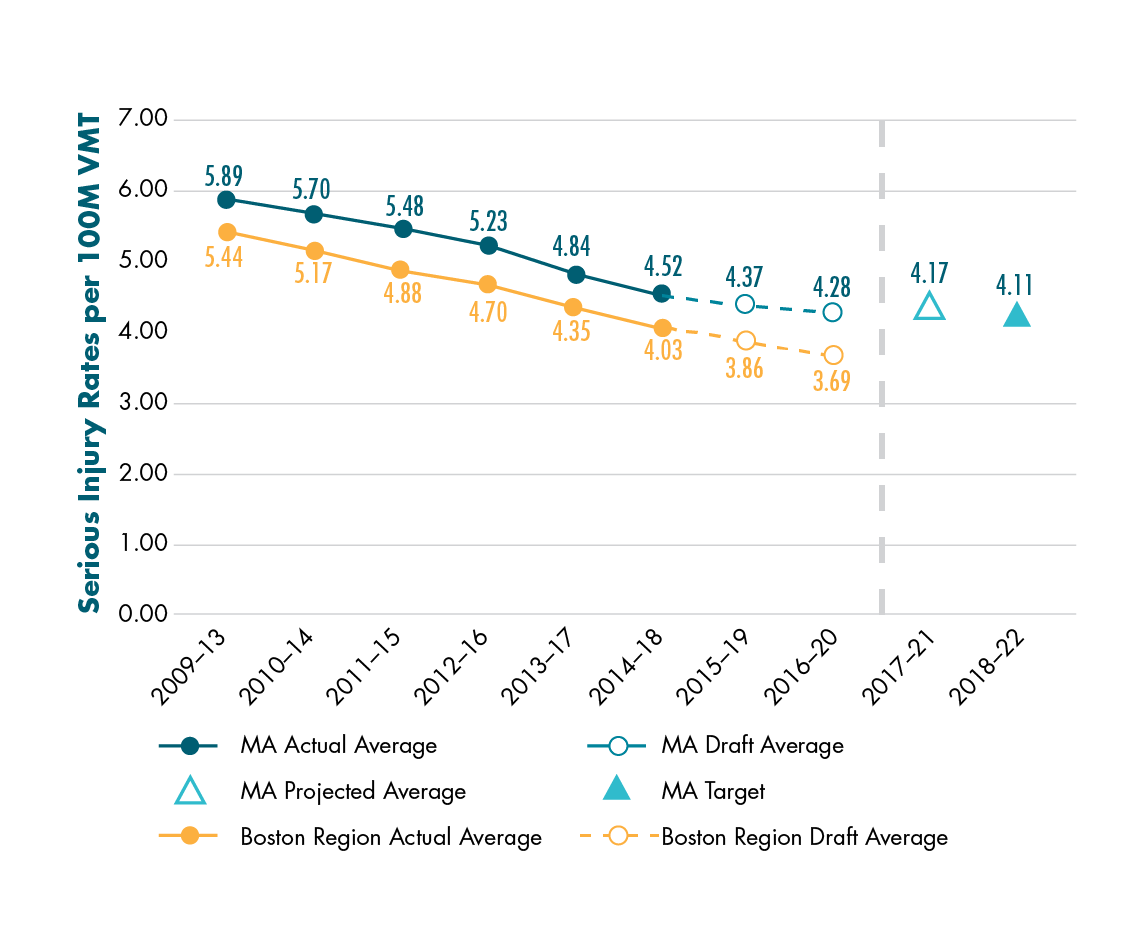

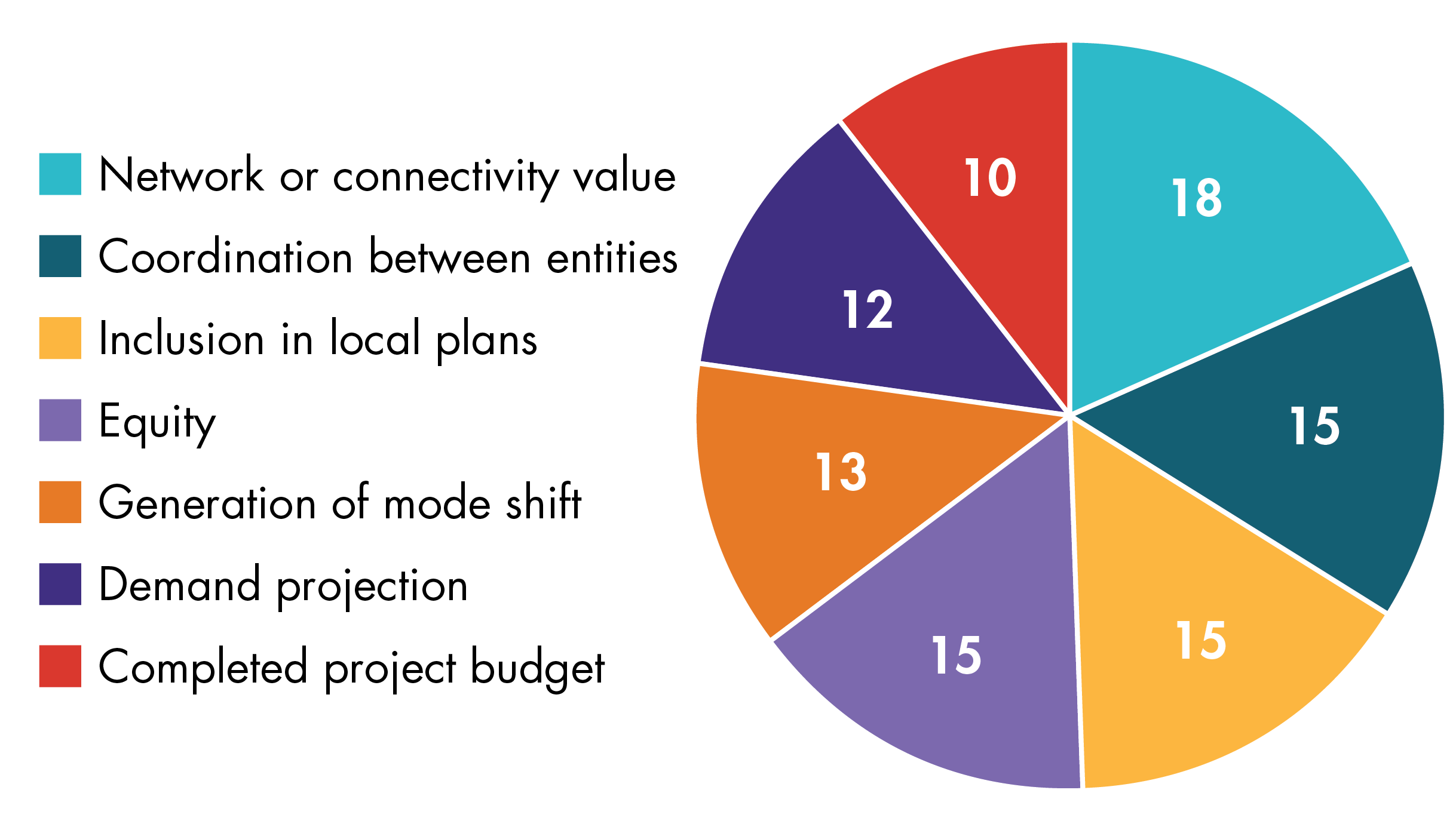

When making decisions about which projects to fund, the MPO considers not only the relative distribution of funds across projects and investment programs, but also how the allocation of funds to each investment program compares to the funding goals outlined in the MPO’s Long-Range Transportation Plan (LRTP), Destination 2040. The investment program sizes set forth in the LRTP reflect the types of projects the MPO seeks to fund to help it achieve its goals and objectives for the region, from enhancing safety for all users to promoting mobility and accessibility across the region. More information on the MPO’s goals and objectives are available in Chapter 1, and a comparison between LRTP investment program sizes and program funding levels in the FFYs 2023–27 TIP is shown in Figure ES-2.

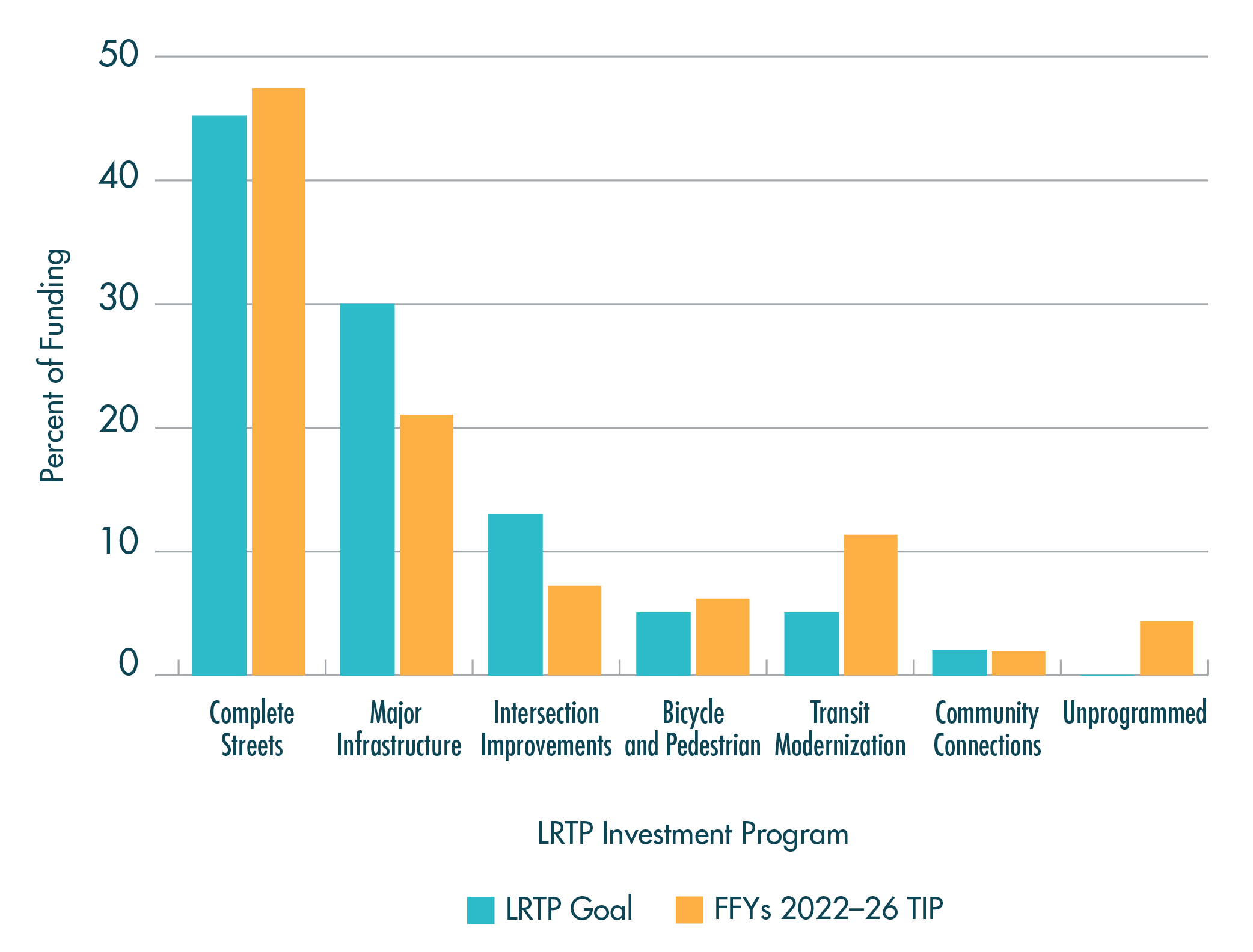

Figure ES-2

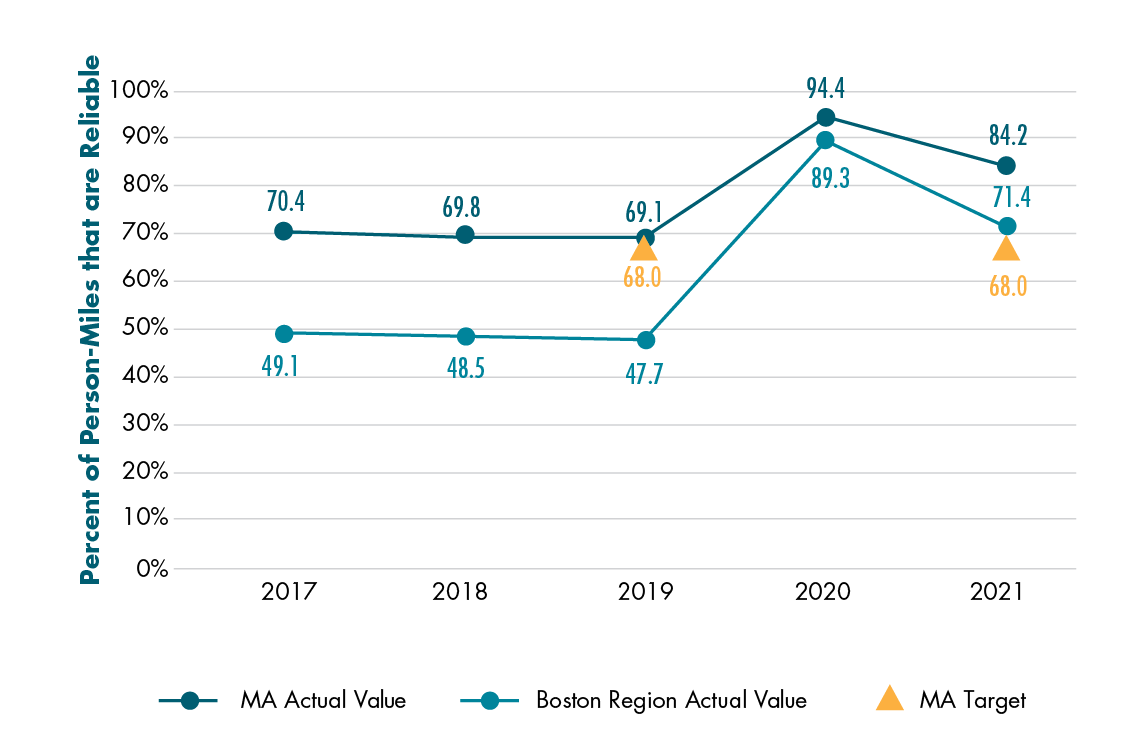

FFYs 2023–27 TIP: Regional Target Funding Levels Relative to LRTP Investment Program Goals

Figure ES-2 is a bar chart that shows a comparison between the distribution of funding in the 2023–27 TIP by MPO investment program and the funding goals set for these programs in the MPO’s Long-Range Transportation Plan, Destination 2040.

FFY = federal fiscal year. LRTP = Long-Range Transportation Plan. TIP = Transportation Improvement Program.

Source: Boston Region MPO.

The investments made in the FFYs 2023–27 TIP will be implemented in 44 cities and towns throughout the Boston region, ranging from dense inner core communities to developing suburbs further from the urban center. Figure ES-3 illustrates the distribution of Regional Target funding among the eight subregions within the Boston Region MPO’s jurisdiction, as defined by the Metropolitan Area Planning Council (MAPC). This figure also includes information about how the distribution of funds compares to key metrics for measuring the need for funding by subregion, including the percent of regional population, employment, and Federal-Aid roadway miles within each subregion.

Figure ES-3

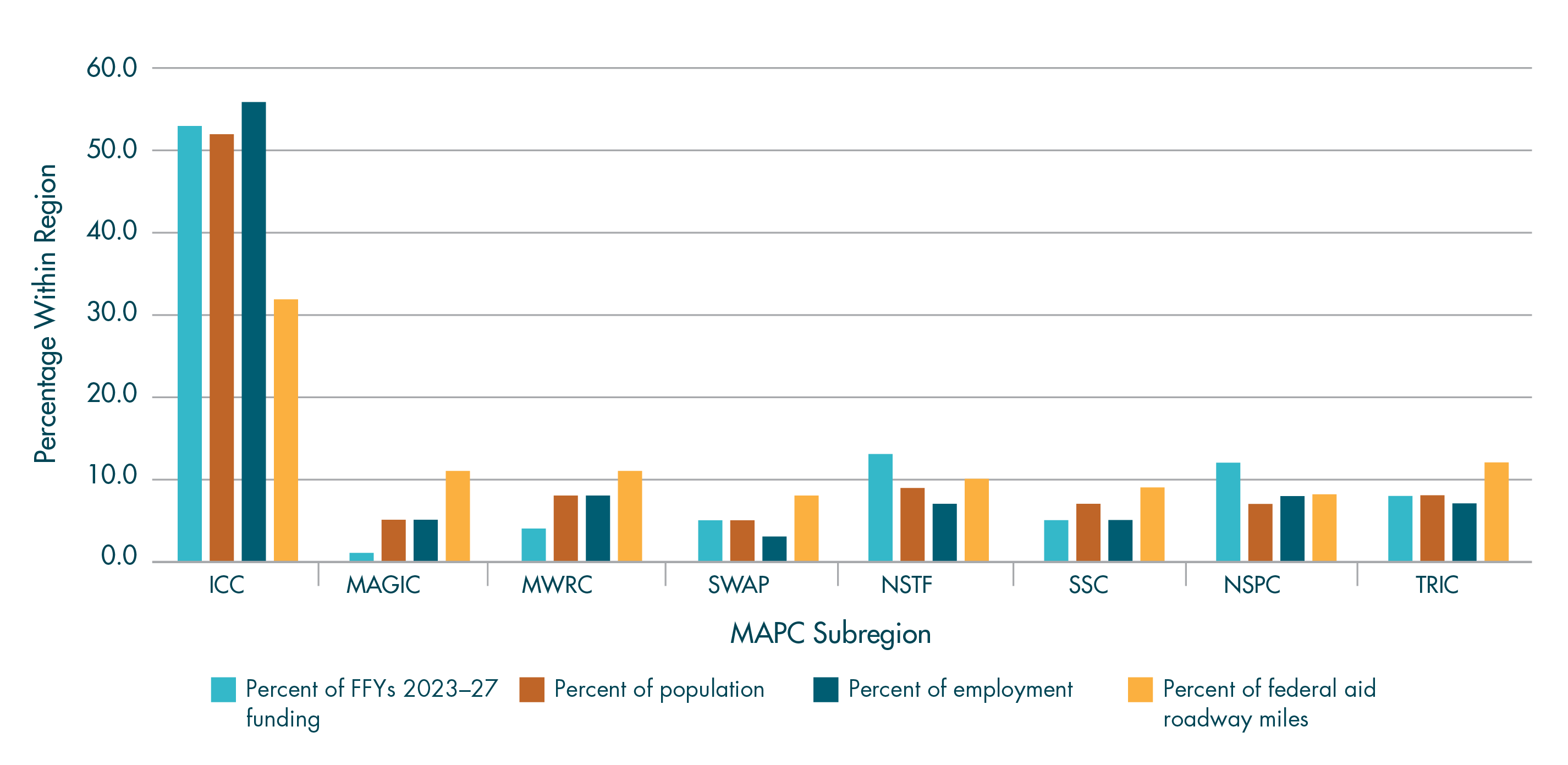

FFYs 2023–27 TIP: Regional Target Funding Levels Relative to Key Indicators

Figure ES-3 is a bar chart that shows the distribution of MPO Regional Target funding across the eight subregions within the Boston Region in relation to the percent of population, jobs, and federal-aid roadway miles within each subregion.

Note: Unprogrammed funds and funds held for the MPO’s Transit Modernization and Community Connections Programs are not included in this figure.

FFY = federal fiscal year. MAGIC = Minuteman Advisory Group on Interlocal Coordination. MAPC = Metropolitan Area Planning Council. MetroWest = MetroWest Regional Collaborative. NSPC = North Suburban Planning Council. NSTF = North Shore Task Force. SSC = South Shore Coalition. SWAP = South West Advisory Committee. TIP = Transportation Improvement Program. TRIC = Three Rivers Interlocal Council.

Source: Boston Region MPO.

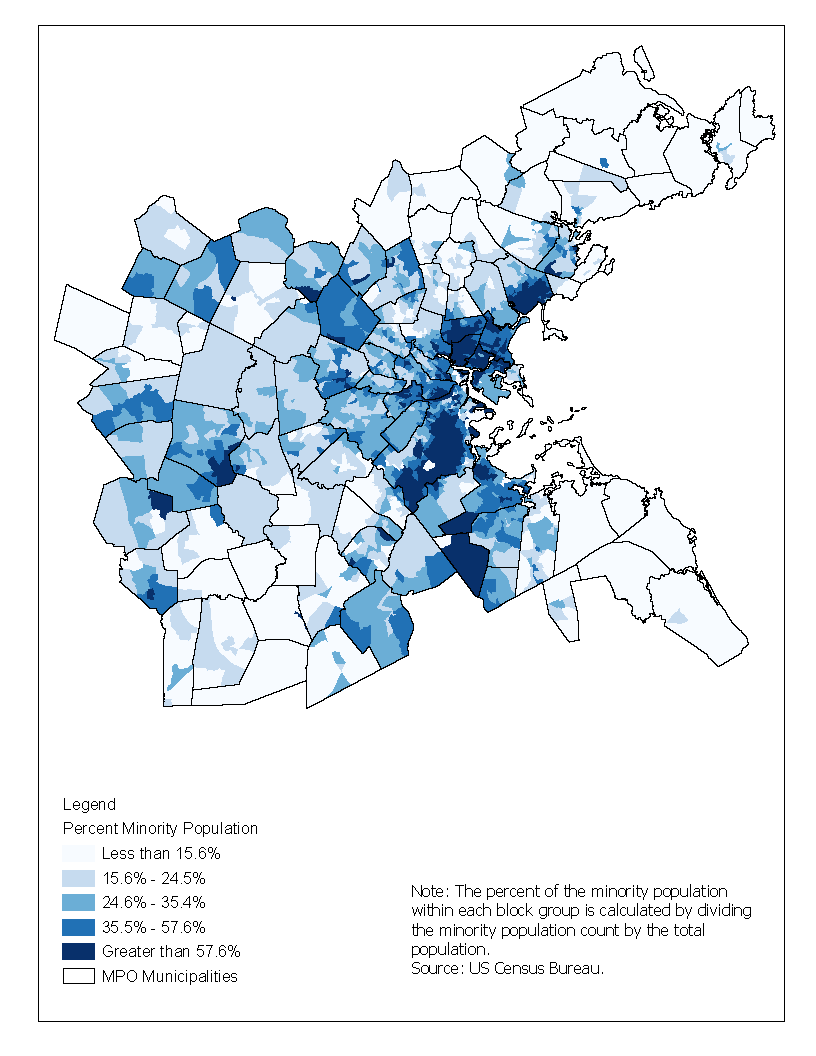

Additional information on the geographic distribution of Regional Target funding across the region, including a breakdown of funding by municipality, is included in Appendix D.

financing the ffys 2023–27 tip

Highway Program

The TIP Highway Program was developed with the assumption that federal funding for the state would range between $789 million and $850 million annually over the next five years. These amounts include the funds that would be set aside initially by MassDOT as payments for the Accelerated Bridge Program and exclude required matching funds. The funding levels for the FFYs 2023–27 TIP’s Highway Program represent an increase of approximately 18 percent over those in the FFYs 2022–26 TIP. This is a direct result of the broad increase in federal formula funding resulting from the passage of the BIL in November 2021.

The process of deciding how to use this federal funding in the Boston region follows several steps. First, MassDOT reserves funding for GANs debt service payments for the Accelerated Bridge Program; annual GANs payments range between $89 million and $134 million annually over the five years of this TIP.

The remaining Federal-Aid Highway Program funds are budgeted to support state and regional (i.e., MPO) priorities. In the FFYs 2023–27 TIP, $870 million to $895 million annually was available for programming statewide, including both federal dollars and the local match. MassDOT customarily provides the local match (which can also be provided by other entities); thus, projects are typically funded with 80 percent federal dollars and 20 percent state dollars, depending on the funding program. Costs for project design are borne by the proponent of the project.

Next, MassDOT allocates funding across the following funding categories:

Finally, once these needs have been satisfied, MassDOT allocates the remaining funding among the state’s 13 MPOs for programming. This discretionary funding for MPOs is sub-allocated by formula to determine the Regional Target amounts. The Boston Region MPO receives the largest portion of MPO funding in the state, with approximately 43 percent of Massachusetts’ Regional Target funds allocated to the region. MassDOT develops these targets in consultation with the Massachusetts Association of Regional Planning Agencies (MARPA). This TIP was programmed with the assumption that the Boston Region MPO will have between $129 million and $132 million annually for Regional Target amounts, which consist of federal funding and state funding for the local match.

Each MPO may decide how to prioritize its Regional Target funding. Given that the Regional Target funding is a subset of the Highway Program, the MPO typically programs the majority of funding for roadway projects; however, the MPO has flexed portions of its highway funding to the Transit Program for transit expansion projects and through its Transit Modernization and Community Connections Programs. The TIP Highway Program details the projects that will receive Regional Target funding from the Boston Region MPO and statewide infrastructure projects within the Boston region. Details on these investments are outlined in Chapter 3.

Transit Program

The Federal Transit Administration (FTA) allocates the funds programmed in the TIP Transit Program according to formula. The three regional transit authorities in the Boston Region MPO area that are recipients of these funds are the MBTA, CATA, and MWRTA. The MBTA, with its extensive transit program and infrastructure, is the recipient of the preponderance of the region’s federal transit funds.

As the current federal transportation legislation, the BIL allocates funding to transit projects through the following formula programs:

the tip development process

Overview

When determining which projects to fund through the Regional Target funding process, MPO members collaborate with municipalities, state agencies, members of the public, advocacy groups, and other stakeholders. The MPO board uses evaluation criteria in its project selection process to help identify and prioritize projects that advance progress on the MPO’s six goal areas:

Additionally, the MPO has established investment programs, which are designed to direct Regional Target funding towards MPO priority areas over the next 20 years, to help meet these goals. The investment programs are as follows:

Projects that the MPO selects to receive Regional Target funding through the TIP development process are included in one of the six investment programs listed above. More information on the MPO’s investment programs is available in Chapter 2.

In recent years, the MPO has been incorporating performance-based planning and programming (PBPP) practices into its TIP development and other processes. These practices are designed to help direct MPO funds towards achieving specific outcomes for the transportation system. The MPO’s goals and investment programs are key components of its PBPP framework. In FFY 2018, the MPO began to set targets for specific performance measures. Over time, the MPO will more closely link its performance targets, investment decisions, and monitoring and evaluation activities. More information on PBPP is available in Chapter 4 as well as in Appendix A (Table A-2).

Outreach and Data Collection

The outreach process begins early in the federal fiscal year, when cities and towns designate TIP contacts and begin developing a list of priority projects to be considered for federal funding, and the MPO staff asks the staffs of cities and towns in the region to identify their priority projects. MPO staff compiles the project funding requests into a Universe of Projects, a list of all Bicycle Network and Pedestrian Connections, Complete Streets, Intersection Improvements, and Major Infrastructure projects identified as potential candidates to receive funding through the TIP. Projects seeking funding through the MPO’s Community Connections Program are not included in the Universe, as all projects that apply for this program’s discrete application process are considered for funding. The MPO does not currently list Transit Modernization projects in the Universe, as the project intake process for this program is currently being developed. The Universe includes projects at varying levels of readiness, from those with significant engineering and design work complete to those still early in the conceptual or planning stage. MPO staff collects data on each project in the Universe so that the projects may be evaluated.

Project Evaluation

MPO staff evaluates projects based on how well they address the MPO’s goals. For MPO staff to conduct a complete project evaluation, Bicycle Network and Pedestrian Connections, Complete Streets, Intersection Improvements, and Major Infrastructure projects must have a functional design report or the project plans must include the level of detail defined in a functional design report, a threshold typically reached when a project nears the 25 percent design stage. To complete an evaluation for projects under consideration through the MPO’s Community Connections Program, project proponents must submit a completed application to MPO staff.

In response to significant cost increases in recent TIP cycles for projects already programmed for funding, the MPO board created a committee in the wake of the FFYs 2022–26 TIP cycle to further explore the causes of project cost increases and devise MPO policy changes to support more reliable project delivery. The TIP Project Cost Ad Hoc Committee began its work in June 2021 and advanced a set of policy recommendations to the full MPO board in September 2021. These changes were formally adopted by the MPO on November 4, 2021, and were in effect for the development of the FFYs 2023–27 TIP.

Among other changes, the MPO elected to codify its policy of requiring that project proponents submit 25 percent designs and obtain an updated cost estimate for their projects prior to being programmed in the TIP. While this new policy was formally in effect for the FFYs 2023–27 TIP cycle, the MPO desired to keep this threshold flexible in its first year of implementation, given that the policy was not adopted until after the start of TIP development. Furthermore, projects may still be scored before reaching the 25 percent design stage in order to provide proponents with a sense for the extent to which their projects align with the MPO’s goals and scoring criteria.

The evaluation results for all projects are presented to the MPO board members for their consideration for programming in the TIP. Draft scores are shared directly with project proponents, at which point proponents are encouraged to review the scores and provide feedback so that MPO staff may make any warranted adjustments to arrive at accurate final results. Once proponents review their scores, final scoring results are posted on the MPO’s website where MPO members, municipal officials, and members of the public may review them.

TIP Readiness Day

An important step toward TIP programming takes place midway through the TIP development cycle at a meeting—referred to as TIP Readiness Day—that both MassDOT and MPO staff attend. At this meeting, MassDOT project managers provide updates about cost and schedule changes related to currently programmed projects. These cost and schedule changes must be taken into account as MPO staff helps the MPO board consider updates to the already programmed years of the TIP, as well as the addition of new projects in the outermost year of the TIP.

Among the other new policies advanced by the TIP Project Cost Ad Hoc Committee, the MPO board adopted a policy requiring proponents of projects that experienced a cost increase of 25 percent or more (for projects costing less than $10 million) or $2.5 million or more (for projects costing more than $10 million) to present to the MPO board on the reasons for these cost increases. The MPO would then compare these projects—at the new costs—to other projects based on a cost-effectiveness evaluation before making a decision on whether or not to fund the projects at the higher costs. These cost changes are most often revealed through conversations between MassDOT staff and MPO staff during TIP Readiness Day, making this new policy especially relevant at this stage of TIP development.

Staff Recommendation and Draft TIP

Using the evaluation results and information about project readiness (that is, the extent to which a project is fully designed and ready for construction), MPO staff prepares a recommendation or a series of programming scenarios for how to program the Regional Target funding in the TIP. Other considerations, such as whether a project was included in the LRTP, addresses an identified transportation need, or promotes distribution of transportation investments across the region, are also incorporated into these programming scenarios. The staff recommendation is always financially constrained—meaning, subject to available funding. There was approximately $645 million of Regional Target funding available to the Boston Region MPO for FFYs 2023–27. In this TIP cycle, the MPO board members discussed several scenarios for the Regional Target Program for highway projects and selected a preferred program in March 2022.

In addition to prioritizing the Regional Target funding, the MPO board reviews and endorses the statewide highway program that MassDOT recommends for programming. The board also reviews and endorses programming of funds for the MBTA’s, CATA’s, and MWRTA’s transit capital programs.

Approving the TIP

After selecting a preferred programming scenario, usually in late March, the MPO board votes to release the draft TIP for a 21-day public review period. The comment period typically begins in late April or early May, and during this time the MPO invites members of the public, municipal officials, and other stakeholders in the Boston region to review the proposed program and submit feedback. During the public review period, MPO staff hosts public meetings to discuss the draft TIP document and elicit additional comments.

After the public review period ends, the MPO board reviews all municipal and public comments and may change elements of the document or its programming. The MPO board then endorses the TIP and submits it to the Federal Highway Administration (FHWA) and the Federal Transit Administration (FTA) for approval. MassDOT incorporates the MPO-endorsed TIP into the State Transportation Improvement Program (STIP). The FHWA, FTA, and United States Environmental Protection Agency review the STIP for certification by September 30, the close of the federal fiscal year.

Updates to the TIP

Even after the TIP has been finalized, administrative modifications, amendments, and adjustments often must be introduced because of changes in project schedule, project cost, funding sources, or available revenues. This may necessitate reprogramming a project in a different funding year or programming additional funds for a project.

Notices of administrative modifications and amendments are posted on the MPO’s website. If an amendment is necessary, the MPO notifies affected municipalities, stakeholders, and members of the public via email. The MPO typically holds a 21-day public review period before taking final action on an amendment. In extraordinary circumstances, the MPO may vote to shorten the public comment period to a minimum of 15 days. Administrative modifications and adjustments are minor and usually do not warrant a public review period.

Stay Involved with the TIP

Public engagement is an important aspect of the transportation planning process. Please visit bostonmpo.org for more information about the MPO, to view the entire TIP, and to submit your comments. You also may wish to sign up for email news updates and notices by visiting bostonmpo.org/subscribe and submitting your contact information. To request a copy of the TIP in accessible formats, please contact the MPO staff by any of the following means:

Mail: Boston Region MPO c/o CTPS Certification Activities Group, 10 Park Plaza, Suite 2150, Boston, MA 02116-3968

Telephone: 857.702.3702 (voice)

For people with hearing or speaking difficulties, connect through the state MassRelay service:

Relay Using TTY or Hearing Carry-over: 800.439.2370
Relay Using Voice Carry-over: 866.887.6619
Relay Using Text to Speech: 866.645.9870

Fax: 617.570.9192

Email: publicinfo@ctps.org

The Executive Summary of the FFYs 2022–26 TIP is also available as a translation:

back to top

Chapter 1
3C Transportation Planning and the Boston Region MPO

Decisions about how to allocate transportation funds in a metropolitan area are guided by information and ideas gathered from a broad group of people, including elected officials, municipal planners and engineers, transportation advocates, and interested residents. Metropolitan planning organizations (MPO) are the bodies responsible for providing a forum for this decision-making process. Each metropolitan area in the United States with a population of 50,000 or more, also known as an urbanized area, is required by federal legislation to establish an MPO, which decides how to spend federal transportation funds for capital projects and planning studies for the area.

THE TRANSPORTATION PLANNING PROCESS

The federal government regulates the funding, planning, and operation of the surface transportation system through the federal transportation program, which was enacted into law through Titles 23 and 49 of the United States Code. Section 134 of Title 23 of the Federal Aid Highway Act, as amended, and Section 5303 of Title 49 of the Federal Transit Act, as amended, require that urbanized areas conduct a transportation planning process, resulting in plans and programs consistent with the planning objectives of the metropolitan area, in order to be eligible for federal funds.

The most recent reauthorization of the federal surface transportation law is the Bipartisan Infrastructure Law (BIL), which has succeeded the Fixing America’s Surface Transportation Act. The BIL sets policies related to metropolitan transportation planning, and requires that all MPOs carry out a continuing, comprehensive, and cooperative (3C) transportation planning process.

3C Transportation Planning

The Boston Region MPO is responsible for carrying out the 3C planning process in the Boston region. The MPO has established the following objectives for the process:

More information about the federal, state, and regional guidance governing the transportation planning process, and about the regulatory framework in which the MPO operates can be found in Appendix E.

THE BOSTON REGION MPO

The Boston Region MPO’s planning area extends across 97 cities and towns from Boston north to Ipswich, south to Marshfield, and west to Interstate 495.

Figure 1-1 shows the map of the Boston Region MPO’s member municipalities.

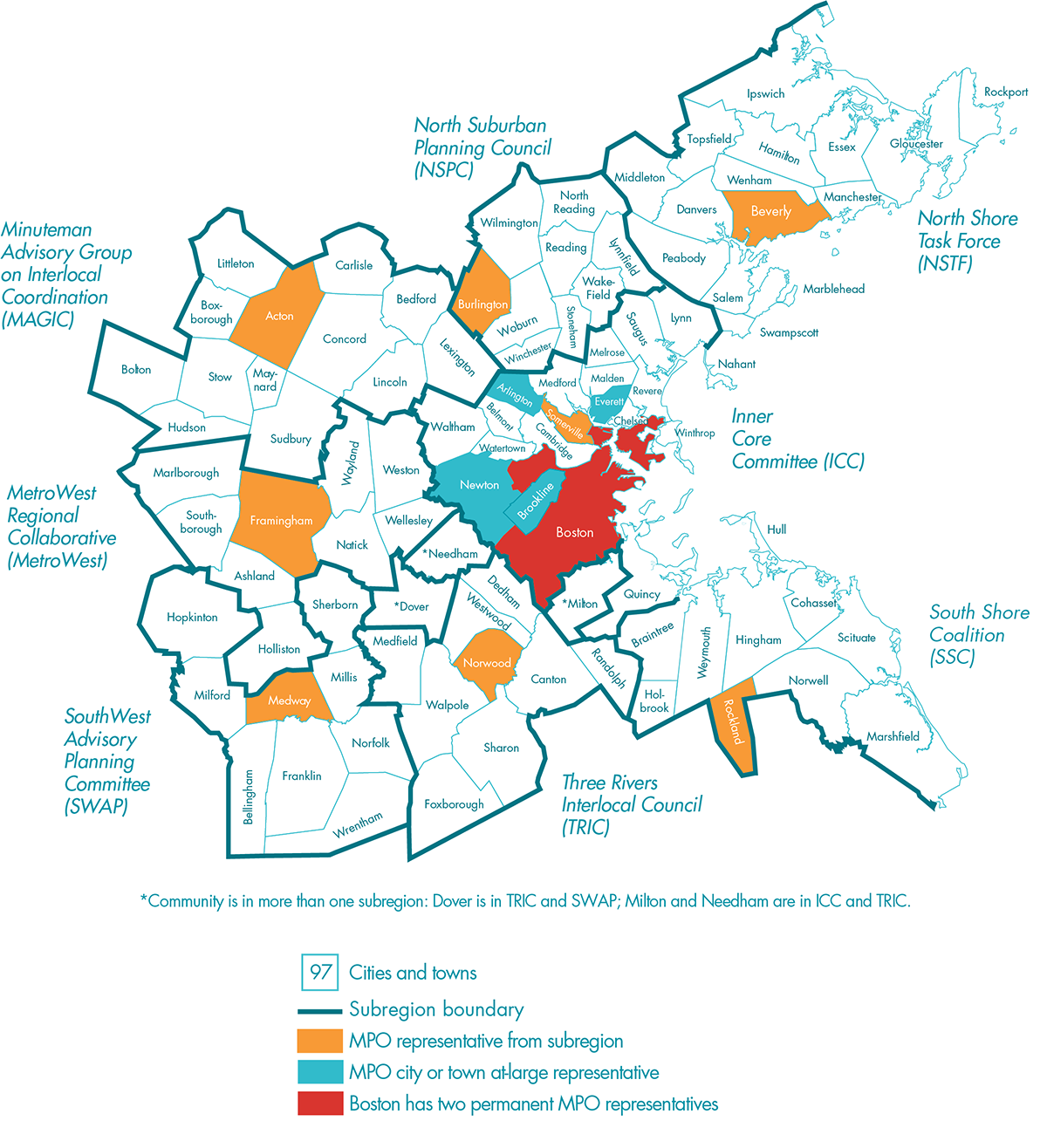

Figure 1-1
Municipalities in the Boston Region

Figure 1-1 is a map that shows the physical reach of the Boston Region MPO area. It indicates that the MPO’s jurisdiction extends from Boston north to Ipswich, south to Marshfield, and west to Interstate 495. The map shows the 97 cities and towns that make up the MPO area. It also indicates the eight subregions of the MPO as well as the voting members of the MPO board.

The MPO’s board comprises 22 voting members. Several state agencies, regional organizations, and the City of Boston are permanent voting members, while 12 municipalities are elected as voting members for three-year terms. Eight municipal members represent each of the eight subregions of the Boston region, and there are four at-large municipal seats. The Federal Highway Administration (FHWA) and Federal Transit Administration (FTA) participate on the MPO board as advisory (nonvoting) members. More details about the MPO’s permanent members can be found in Appendix F.

Figure 1-2 shows MPO membership and the organization of the Central Transportation Planning Staff, which serves as staff to the MPO.

Figure 1-2
Boston Region MPO Organizational Chart

Figure 1-2 is an organizational chart that lays out the membership and staff (the Central Transportation Planning Staff) of the Boston Region MPO.

MPO Central Vision Statement

The following paragraph is the MPO’s central vision statement, as adopted in Destination 2040, the MPO’s current Long-Range Transportation Plan (LRTP).

The Boston Region MPO envisions a modern, well-maintained transportation system that supports a sustainable, healthy, livable, and economically vibrant region. To achieve this vision, the transportation system must be safe and resilient; incorporate emerging technologies; and provide equitable access, excellent mobility, and varied transportation options.

This vision statement takes into consideration the significant public input received during the drafting of the Needs Assessment for Destination 2040. This statement also reflects the MPO’s desire to add emphasis to the maintenance and resilience of the transportation system while supporting the MPO’s six core goals: Safety, System Preservation and Modernization, Capacity Management and Mobility, Clean Air and Sustainable Communities, Transportation Equity, and Economic Vitality. More information on the MPO’s vision, goals, and objectives for the transportation system is available in Figure 1-3 below.

Certification Documents

As part of its 3C process, the Boston Region MPO annually produces the Transportation Improvement Program (TIP) and the Unified Planning Work Program (UPWP). These documents, along with the quadrennial LRTP, are referred to as certification documents and are required for the federal government to certify the MPO’s planning process. This federal certification is a prerequisite for the MPO to receive federal transportation funds. In addition to the requirement to produce the LRTP, TIP, and UPWP, the MPO must establish and conduct an inclusive public participation process, and maintain transportation models and data resources to support air quality conformity determinations and long- and short-range planning work and initiatives.

The following is a summary of each of the certification documents.

Figure 1-3
LRTP Goals and Objectives

Central Vision Statement

The Boston Region Metropolitan Planning Organization envisions a modern, well-maintained transportation system that supports a sustainable, healthy, livable, and economically vibrant region. To achieve this vision, the transportation system must be safe and resilient; incorporate emerging technologies; and provide equitable access, excellent mobility, and varied transportation options.

Goals Objectives

SAFETY: Transportation by all modes will be safe

  • Reduce the number and severity of crashes and safety incidents for all modes
  • Reduce serious injuries and fatalities from transportation
  • Make investments and support initiatives that help protect transportation customers, employees, and the public from safety and security threats

SYSTEM PRESERVATION: Maintain and modernize the transportation system and plan for its resiliency

  • Maintain the transportation system, including roadway, transit, and active transportation infrastructure, in a state of good repair
  • Modernize transportation infrastructure across all modes
  • Prioritize projects that support planned response capability to existing or future extreme conditions (sea level rise, flooding, and other natural and security-related man-made impacts)

CAPACITY MANAGEMENT AND MOBILITY: Use existing facility capacity more efficiently and increase transportation options

  •  Improve access to and accessibility of all modes, especially transit and active transportation
  • Support implementation of roadway management and operations strategies to improve travel reliability, mitigate congestion, and support non-single-occupant vehicle travel options
  • Emphasize capacity management through low-cost investments; prioritize projects that focus on lower-cost operations/management-type improvements
    such as intersection improvements, transit priority, and Complete Streets solutions
  • Improve reliability of transit
  • Increase percentage of population and employment within one-quarter mile of transit stations and stops
  • Support community-based and private-initiative services and programs to meet first- and last-mile, reverse commute, and other non-traditional transit/ transportation needs, including those of people 75 years old or older and people with a disability
  • Support strategies to better manage automobile and bicycle parking capacity and usage at transit stations
  • Fund improvements to bicycle/pedestrian networks aimed at creating a connected network of bicycle and accessible sidewalk facilities (both regionally and in neighborhoods) by expanding existing facilities and closing gaps
  • Increase percentage of population and places of employment with access to facilities on the bicycle network
  • Eliminate bottlenecks on freight network; improve freight reliability
  • Enhance freight intermodal connections

TRANSPORTATION EQUITY: Ensure that all people receive comparable benefits from, and are not disproportionately burdened by, MPO investments, regardless of race, color, national origin, age, income, ability, or sex

  •  Prioritize MPO investments that benefit equity populations*
  • Minimize potential harmful environmental, health, and safety effects of MPO-funded projects for all equity populations*
  • Promote investments that support transportation for all ages (age-friendly communities)
  • Promote investments that are accessible to all people regardless of ability

    *Equity populations include people who identify as minority, have limited English proficiency, are 75 years old or older or 17 years old or younger, or have a disability; or are members of low-income households.

CLEAN AIR/SUSTAINABLE COMMUNITIES: Create an environmentally friendly transportation system

  • Reduce greenhouse gases generated in Boston region by all transportation modes
  • Reduce other transportation-related pollutants
  • Minimize negative environmental impacts of the transportation system
  • Support land use policies consistent with smart, healthy, and resilient growth

ECONOMIC VITALITY: Ensure our transportation network provides a strong foundation for economic vitality

  • Respond to mobility needs of the workforce population
  • Minimize burden of housing/transportation costs for residents in the region
  • Prioritize transportation investments that serve residential, commercial, and logistics targeted development sites and “Priority Places” identified in MBTA’s Focus 40 plan
  • Prioritize transportation investments consistent with compact-growth strategies of the regional land-use plan

Figure 1-4 depicts the relationship between the three certification documents and the MPO’s performance-based planning and programming process, which is a means to monitor progress towards the MPO’s goals and to evaluate the MPO’s approach to achieving those goals.

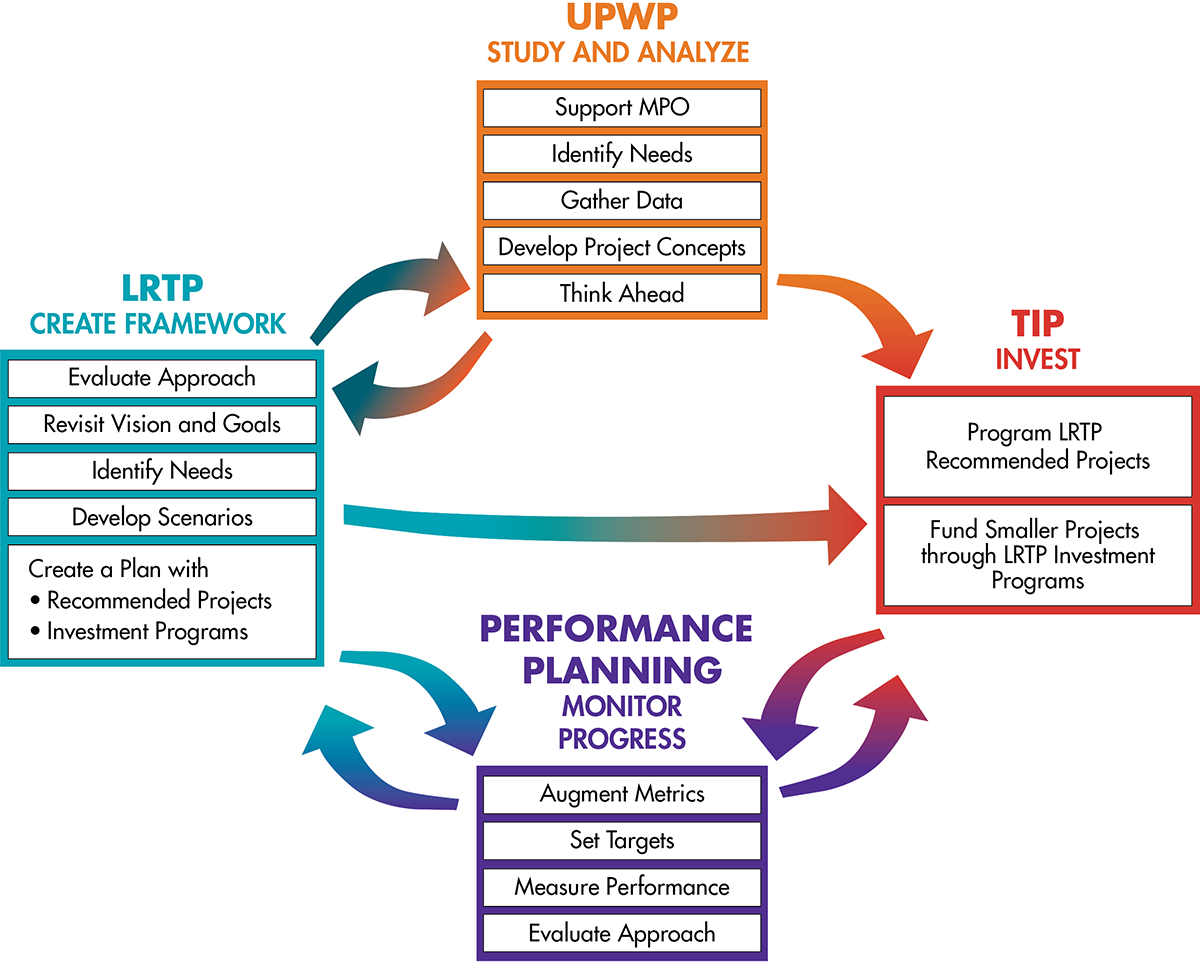

Figure 1-4
Relationship between the LRTP, TIP, UPWP, and Performance-Based Planning Process

Figure 1-4 is a text figure with directional arrows that shows how the different facets of each of the MPO’s four 3C programs complement and support each other.

back to top

Chapter 2
The TIP Process

INTRODUCTION TO THE TIP PROCESS

One of the most important decisions a metropolitan planning organization (MPO) faces is deciding how to allocate limited funds for transportation projects and programs. Transportation improvements are part of the solution to many critical regional, state, national, and even global problems, such as traffic congestion, air pollution, fatalities and injuries on roadways, climate change, and environmental injustice. Because there is not nearly enough funding available for all of the necessary and worthy projects that would address these problems, an MPO’s investment choices must be guided by policies that help identify the most viable and effective solutions.

As described in Chapter 1, the Boston Region MPO develops a Long-Range Transportation Plan (LRTP) and a Transportation Improvement Program (TIP) to prioritize the expenditure of federal funds on transportation projects. The MPO staff manages the development of both plans. The annual development process for the TIP involves evaluating project funding requests from municipalities and state transportation agencies. The MPO staff then proposes a range of alternative scenarios for the programming of new and ongoing projects based on anticipated yearly funding levels, supports the MPO board by creating a draft TIP document, and facilitates a public involvement process that affords the public an opportunity to comment on proposed projects and review the draft TIP before the MPO board endorses the final document.

FUNDING the TIP

Federal Funding Framework

The first step in allocating federal transportation funds is the passage by the United States Congress of a multi-year act that establishes a maximum level of federal transportation funding per federal fiscal year (FFY). The establishment of this level of funding is referred to as an authorization. The most recent authorization act, the Bipartisan Infrastructure Law (BIL), was signed into law on November 15, 2021. The BIL governs the development of the FFYs 2023–27 TIP, including establishing new formula funding levels, creating new and reauthorizing existing discretionary grant programs, and setting policy priorities. More information about the impacts of the BIL on the development of the FFYs 2023–27 TIP is available throughout this report, with specific guidance on new BIL Planning Emphasis Areas available in Appendix E.

After the authorization level has been established, the United States Department of Transportation annually allocates funding among the states according to various federal formulas. This allocation is referred to as an apportionment. The annual apportionment rarely represents the actual amount of federal funds that are ultimately committed to a state because of federally imposed limitations on spending in a given fiscal year, referred to as the obligation authority. In Massachusetts, TIPs are developed based on the estimated obligation authority.

Federal Highway Program

The FFYs 2023–27 TIP’s Highway Program was developed with the assumption that funding from the Federal-Aid Highway Program for the Commonwealth of Massachusetts would range between approximately $789 million and $850 million annually over the next five years. These amounts include the funds that would be set aside initially by the Massachusetts Department of Transportation (MassDOT) as payments for the Accelerated Bridge Program and exclude required matching funds. The funding levels for the FFYs 2023–27 TIP’s Highway Program represent an increase of approximately 18 percent over those in the FFYs 2022–26 TIP. This is a direct result of the broad increase in federal formula funding resulting from the passage of the BIL in November 2021.

The process of deciding how to use this federal funding in the Boston region follows several steps. MassDOT first reserves funding for Grant Anticipation Notes (GANs) debt service payments for the Accelerated Bridge Program; annual GANs payments range between approximately $89 million and $134 million annually over the five years of this TIP.

The remaining Federal-Aid Highway Program funds are budgeted to support state and regional (i.e., MPO) priorities. In the FFYs 2023–27 TIP, there is a total of approximately $870 million to $895 million assumed to be annually available statewide for programming (these amounts include both federal dollars and the state-provided local match). MassDOT customarily provides the local match (which can also be provided by other entities); thus, the capital costs of projects are typically funded with 80 percent federal dollars and 20 percent state dollars, depending on the funding program. Costs for project design are borne by the proponent of the project.

Regional Targets

The Regional Targets are discretionary funds for MPOs, sub-allocated by formula to each metropolitan planning region. The Boston Region MPO receives about 43 percent of the total funds available statewide for Regional Targets. MassDOT developed the target formula for determining this distribution of funds in consultation with the Massachusetts Association of Regional Planning Agencies (MARPA).

Each MPO in the state can decide how to prioritize its Regional Target funding. Given that the Regional Target funding originates from the Federal-Aid Highway Program, the Boston Region MPO board typically programs the majority of its target funding on roadway projects; however, the MPO board has flexed portions of its TIP Highway Program funding to the TIP’s Transit Program, most notably when the MPO board provided funding in support of the Green Line Extension transit expansion project. Additionally, the FFYs 2023–27 TIP includes an annual allotment of funding to the MPO’s Transit Modernization Program beginning in FFY 2025. This represents the MPO’s first formalized effort to flex Federal-Aid Highway funds to transit projects on a yearly basis, an affirmation of the region’s goals to support multimodal transportation options in a meaningful way. More information on the MPO’s investment strategy is discussed later in this chapter.

During the next five years, the Boston Region MPO’s total Regional Target funding will be approximately $645 million, an average of $129 million per year. As with the overall increase in funding for the Highway Program from the BIL, the MPO’s Regional Target funds increased nearly 20 percent per year in the FFYs 2023–27 TIP relative to the levels planned for in the development of the FFYs 2022–26 TIP. To decide how to spend its Regional Target funding, the MPO engages its 97 cities and towns in an annual TIP development process.

Federal Highway Administration Programs

The Federal-Aid Highway Program dollars discussed in this chapter come through several Federal Highway Administration (FHWA) funding programs, each of which has unique requirements. Table 2-1 lists these programs, which come from the BIL and fund projects in the FFYs 2023–27 TIP.

Table 2-1
Federal Highway Administration Programs Applicable to the FFYs 2023–27 Transportation Improvement Program

BIL Program

Eligible Uses

Bridge Formula Program (BFP)

Efforts to replace, rehabilitate, preserve, protect, and construct highway bridges

Congestion Mitigation and

Air Quality Improvement

(CMAQ)

A wide range of projects to reduce congestion and improve air quality in nonattainment and maintenance areas for ozone, carbon monoxide, and particulate matter

Highway Safety

Improvement Program

(HSIP)

Implementation of infrastructure-related highway safety improvements

Metropolitan Planning

Facilities that contribute to an intermodal transportation system, including intercity bus, pedestrian, and bicycle facilities

National Electric Vehicle Infrastructure (NEVI) Program

Projects that support the strategic deployment of electric vehicle (EV) charging infrastructure and establish an interconnected EV network to facilitate data collection, access, and reliability

National Highway Freight

Program (NHFP)

Projects that improve the efficient movement of freight on the National Highway Freight Network

National Highway

Performance Program

(NHPP)

Improvements to interstate routes, major urban and rural arterials, connectors to major intermodal facilities, and the national defense network; replacement or rehabilitation of any public bridge; and resurfacing, restoring, and rehabilitating routes on the Interstate Highway System

Surface Transportation

Block Grant Program

(STBGP)

A broad range of surface transportation capital needs, including roads; transit, sea, and airport access; and vanpool, bicycle, and pedestrian facilities

Transportation Alternatives

Program (TAP)

A set-aside from the STBGP that funds the construction of infrastructure-related projects (for example, sidewalk, crossing, and on-road bicycle facility improvements)

Source: Federal Highway Administration

Federal Transit Program

Federal aid for public transit authorities is allocated by formula to urbanized areas (UZAs). MassDOT is the recipient of this federal aid in the Boston MA-NH-RI UZA. In UZAs with populations greater than 200,000, such as the Boston MA-NH-RI UZA, the distribution formula factors in passenger-miles traveled, population density, and other factors associated with each transit provider. The three regional transit authorities (RTAs) in the Boston Region MPO area are the Massachusetts Bay Transportation Authority (MBTA), MetroWest Regional Transit Authority (MWRTA), and Cape Ann Transportation Authority (CATA). The MBTA, with its extensive transit program and infrastructure, is the recipient of the preponderance of federal transit funds in the region.

The Federal Transit Administration (FTA) distributes funding to transit agencies through several different programs. Table 2-2 shows FTA programs that come from the BIL and support transit investments in the FFYs 2023–27 TIP.

Table 2-2
Federal Transit Administration Programs Applicable to the FFYs 2023–27 Transportation Improvement Program

BIL Program

Eligible Uses

Urbanized Area Formula

Grants (Section 5307)

Transit capital and operating assistance in urbanized areas

Fixed Guideway/Bus (Section 5337)

Replacement, rehabilitation, and other state-of-good-repair capital projects

Bus and Bus Facilities

(Section 5339)

Capital projects to replace, rehabilitate, and purchase buses and related equipment, and to construct bus-related facilities

Enhanced Mobility of

Seniors and Individuals with Disabilities (Section 5310)

Capital expenses that support transportation to meet the special needs of older adults and persons with disabilities

Fixed-Guideway Capital

Investment Grants (Section 5309)

Grants for new and expanded rail, bus rapid transit, and ferry systems that reflect local priorities to improve transportation options in key corridors

Source: Federal Transit Administration

INVESTMENT FRAMEWORKS

MPO Investment Framework

As mentioned previously, each MPO in the state can decide how to prioritize the Regional Target funding it receives through the processes established by FHWA and MassDOT. The Boston Region MPO’s LRTP defines the investment framework that informs the specific investment decisions made in the TIP by establishing

MPO Goals and Objectives

The MPO’s goals and objectives provide the foundation for the evaluation criteria the MPO board uses when selecting transportation projects to be funded with Regional Target dollars. MPO staff compares candidate projects’ characteristics to these criteria to evaluate whether individual projects can help the MPO advance its various goals. The criteria used to select projects for this TIP are based on the MPO’s goals and objectives, adopted as part of Destination 2040, which is the LRTP the MPO endorsed in August 2019. These goals and objectives are listed in Chapter 1.

MPO Investment Programs

In Destination 2040, the MPO strengthened the link between its spending and improvements to transportation performance by revising its investment programs to include a broader range of prospective projects. These investment programs focus on specific types of projects that the MPO expects will help achieve its goals and objectives for the transportation system. The MPO created these programs to give municipalities the confidence that if they design these types of projects the MPO will be willing to fund them through the TIP:

Figure 2-1 provides details about the Destination 2040 investment programs and their relationship to the MPO’s goals. When developing the FFYs 2023–27 TIP, the MPO allocated its Regional Target dollars to these investment programs by assigning them to projects that meet the investment programs’ criteria.

Figure 2-1
Destination 2040 Investment Programs

Intersection Improvements (S, SP, CM, CA, TE, EV)

Funds projects to modernize intersection geometry and signalization to improve safety and mobility.
Improvements may include:

Complete Streets (S, SP, CM, CA, TE, EV)

Funds projects that modernize roadways to improve safety and mobility for all users.
Improvements may include:

Transit Modernization Program (S, SP, CM, CA, TE, EV)

Funds projects that modernize transit infrastructure and promote the enhanced ridership, accessibility or resiliency of transit services.
Improvements may include:

Community Connections Program (CM, CA, TE, EV)

Funds a variety of project types, including first- and last-mile solutions and other small, nontraditional transportation projects to enhance mobility and improve air quality.
Improvements may include:

Major Infrastructure Program (S, SP, CM, CA, TE, EV)

Funds projects that enhance major arterials for all users and modernize or expand transit systems to increase capacity. Projects in this program cost more than $50 million; are on major roadways including Interstate Highways, Principal Arterial Freeways and Expressways, or all sections of roadways classified as Principal Arterial “Other” that have fully or partially controlled access; or add new connections to or extend the rail or fixed guideway transit network or the bus rapid transit network. Improvements may include

Bicycle Network and Pedestrian Connections (S, SP, CM, CA, TE, EV)

Funds projects to expand bicycle and pedestrian networks to improve safe access to transit, schools, employment centers, and shopping destinations.
Improvements may include:

KEY: MPO GOALS

S: Safety

SP: System Preservation and Modernization

CM: Capacity Management

CA: Clean Air/Sustainable Communities

TE: Transportation Equity

EV: Economic Vitality

Newly created in Destination 2040, the Transit Modernization Program represents a significant shift in the MPO’s investment strategy, as funding will be allocated to transit projects on an annual basis beginning in FFY 2025. In prior years, the MPO only funded transit projects on a one-off basis when funding was requested for specific projects in the region. By creating the programming infrastructure to flex Regional Target highway funds to transit projects annually, the Boston Region MPO has established itself as a leader among MPOs nationally by crafting an investment strategy that is truly multimodal. The MPO has taken a clear stance that investing in transit is central to improving the region’s broader transportation system. The MPO’s five other investment programs were created during the development of prior LRTPs.2-1

During this TIP cycle, the MPO funded multiple Transit Modernization projects in FFYs 2023 and 2024 in order to make use of funding surpluses in these years. The MPO has also continued to reserve funding in each fiscal year beginning in FFY 2025 for future allocation. In the FFYs 2023–27 TIP, the MPO made the decision to increase the funding allocated to this program from $5.5 million to $6.5 million annually, as the MPO’s overall Regional Target funding increased with the passage of the BIL in November 2021.  In the coming years, the MPO will continue to work with municipalities and transit providers in the region to identify transit needs and determine the most effective use of this funding to address those needs.

Destination 2040 also reflects an updated set of priorities for the MPO's Complete Streets investment program, adding dedicated bus lanes and climate resiliency measures to the types of projects targeted for funding through this program. As with the Transit Modernization Program, the MPO will continue to work with municipalities in future TIP cycles to develop and fund projects in these new areas of emphasis.

Finally, while the MPO’s Community Connections investment program was created through the 2015 LRTP, Charting Progress to 2040, the FFYs 2021–25 TIP represented the first TIP cycle that allocated this funding to specific projects. In prior TIP cycles, the $2 million in annual funding for this program was reserved for future use but not allocated, as the development timeline for the first- and last-mile projects funded through this program is much shorter than for other TIP projects. In the FFYs 2023–27 TIP, the MPO built on the success of the first two rounds of the Community Connections Program, funding 11 additional projects on top of the 14 projects funded in the previous two TIP cycles.

Funding for the Community Connections Program continues to be reserved in FFYs 2024–27 for allocation in future TIP cycles. As with the Transit Modernization Program above, the MPO made the decision in the FFYs 2023–27 TIP to increase the funding allocated to the Community Connections Program from $2 million to $2.5 million annually beginning in FFY 2023, as the MPO’s overall Regional Target funding increased with the passage of the BIL in November 2021. More information on the projects selected for funding in each of the MPO’s investment programs can be found in Chapter 3.

Other Funding Guidelines

When creating investment program guidelines for Destination 2040, the MPO elected to decrease the amount of funding allocated to large-scale projects that would be included in its Major Infrastructure Program in order to focus a larger percentage of funding on lower cost, operations-and-maintenance projects. Such a funding mix will help the MPO address its goals and provide more opportunities for the MPO to distribute federal transportation dollars to projects throughout the region, as opposed to concentrating it on a few large-scale projects.

Early in the development of the FFYs 2022–26 TIP, the MPO reassessed its definition of Major Infrastructure projects, adopting a new definition through sequential votes on August 20, 2020, and October 1, 2020. This revised definition carried through to the development of the FFYs 2023–27 TIP. The MPO previously defined Major Infrastructure projects as those that cost more than $20 million or that add capacity to the transportation network. The MPO’s new definition classifies Major Infrastructure projects as those that meet any of the following criteria:

Under the MPO’s prior Major Infrastructure definition, the relatively low cost threshold caused several large-scale Complete Streets projects to be classified as Major Infrastructure projects although they were more local in nature. The changes outlined above are intended to focus the Major Infrastructure investment program on those projects that are of significant scale or that are truly important for the broader MPO region. This allows the MPO to better compare like projects when conducting project evaluations. Because the MPO considers the five-year distribution of TIP funds across its investment programs relative to the goals set forth in the LRTP (as shown in Figure 2-2), properly categorizing projects is a critical component of the MPO’s decision-making process.

Funding allocation goals like these are some of the LRTP-based guidelines the MPO employs to ensure limited Regional Target funding is programmed in ways that best achieve the MPO’s goals for transportation in the region. As the MPO continues the development of its next LRTP, Destination 2050, it will assess the efficacy of each of its six investment programs to ensure these programs are structured to best support progress on the MPO’s goals and objectives for the region.

Figure 2-2
Destination 2040 Funding Goals by MPO Investment Program

Figure 2-2 is a pie chart that shows the funding goals set for each of the MPO’s six investment programs as outlined in the MPO’s Long-Range Transportation Plan, Destination 2040.

In addition to evolving policies for specific investment programs, the MPO also made other policy changes prior to the development of the FFYs 2023–27 TIP to guide future funding decisions. Most notably, the MPO elected to codify its policy of requiring that project proponents submit 25 percent designs and obtain an updated cost estimate for their projects prior to being programmed in the TIP. This new standard was set by the MPO as part of a multi-pronged effort to reduce the prevalence of cost increases for projects that have already been selected for funding in the TIP.

This change is part of a larger suite of policy changes recommended by the TIP Project Cost Ad Hoc Committee, which was created in the wake of the FFYs 2022–26 TIP cycle and completed its work in November 2021. While this new policy was formally in effect for the FFYs 2023–27 TIP cycle, the MPO desired to keep this threshold flexible in its first year of implementation, given that the policy was not adopted until after the start of TIP development. More information on the work of this committee is available on the following pages of this chapter.

MassDOT and Transit Agency Investment Frameworks

MassDOT and the MBTA each update their rolling five-year Capital Investment Plans (CIP) on an annual basis. Historically, these agencies have produced a unified CIP, but for the FFYs 2023–27 capital planning cycle, MassDOT and the MBTA have opted to produce separate plans. Though separate, these plans take similar approaches. MassDOT’s CIP identifies priority roadway, bridge, and statewide infrastructure projects for the five MassDOT divisions and includes funding for specific transit projects such as the South Coast Rail and Green Line Extension projects. The MBTA’s CIP outlines the agency’s five-year investment strategy for transit projects in its service area.

Both CIP processes use a similar framework that prioritizes funding according to statewide strategic goals for the transportation system. Reliability is the top priority for MassDOT and the MBTA, followed by modernization and then expansion. Both agencies have created investment programs for their respective CIPs that relate to these strategic goals, and allocate funding to these programs in ways that emphasize their priority. These goals and investment programs are as follows:

DEVELOPING THE TIP

Project Selection Process

Overview

The MPO applies its investment framework when developing the TIP. The MPO board’s process for selecting projects to receive highway discretionary—or Regional Target—funding relies on evaluation criteria to help identify and prioritize projects that advance the MPO’s goals. The criteria are based on the MPO’s goals and objectives outlined in the LRTP. All projects are required to show consistency with the LRTP and other statewide and regional plans. Other considerations include the readiness of a project for construction and municipal support for the project. Background information about the TIP project evaluation process is presented in Appendix A.

In the wake of the adoption of Destination 2040 in August 2019, the MPO began the process of revising the TIP evaluation criteria to enhance alignment with the MPO’s updated goals, objectives, and investment programs. These new criteria were adopted by the MPO on October 1, 2020, and were employed during the project selection process for the FFYs 2022–26 and 2023–27 TIPs. The final criteria were the result of a 15-month process that engaged nearly 1,100 members of the public through surveys and focus groups. This process also prioritized the inclusion of significant direct input from MPO members, which was gathered from more than a dozen presentations, discussions, and focus groups. The outcomes of this process are discussed further in the Project Evaluation section on the following pages.

Because of the limitations on in-person gatherings caused by the COVID-19 pandemic, a vast majority of the surveys, focus groups, and presentations discussed above were conducted virtually, with participation options both online and over the telephone. These virtual engagement opportunities allowed MPO staff to pursue new ways of building relationships with members of the public and other key stakeholders in the region. Given the increase in access to the TIP criteria revision process afforded by these virtual events, MPO staff intend to develop a hybrid outreach model that would support both in-person and virtual engagement when it is safe to resume in-person meetings.

In addition to the process outlined above, which focused on developing new criteria for five of the MPO’s investment programs (Bicycle Network and Pedestrian Connections, Complete Streets, Intersection Improvements, Major Infrastructure, and Transit Modernization), the MPO also adjusted the project selection criteria used to evaluate and fund projects through the Community Connections Program in the FFYs 2022–26 and 2023–27 TIPs. These revisions were made based on the lessons learned by MPO staff through the pilot round of this program, which took place during the FFYs 2021–25 TIP cycle. More information on these criteria is available in the Project Evaluation section of this chapter, as well as in Appendix A.

Outreach and Data Collection (October–November)

The TIP development process begins early in the federal fiscal year when cities and towns in the region designate staff as TIP contacts and begin developing a list of priority projects to be considered for federal funding. Each fall, the MPO staff asks these TIP contacts to identify their city or town’s priority projects and then MPO staff elicits input from interested parties and members of the general public.

These discussions on municipalities’ priority projects mark the start of a robust dialogue between MPO staff and project proponents that continues through the duration of the TIP cycle. As noted above, the COVID-19 pandemic forced the transition of all of these conversations for the FFYs 2023–27 TIP cycle to take place virtually. During the fall of 2021, MPO staff held two virtual workshops for municipalities in the region to develop an understanding of the TIP process. MPO staff provided additional one-on-one virtual office hours throughout the fall for proponents to ask more detailed questions about advancing specific projects for funding, with several office hour sessions booked for this purpose during the early stages of developing the FFYs 2023–27 TIP.

Once project proponents have decided to pursue federal funding, they must begin the formal project initiation process. All new Bicycle Network and Pedestrian Connections, Complete Streets, Intersection Improvements, and Major Infrastructure projects must be initiated with the MassDOT Highway Division before they can be considered for programming in the TIP. MassDOT details this process on its project initiation webpage, mass.gov/info-details/massdot-highway-initiating-a-project . To be considered for programming, proponents of Community Connections projects must submit an application for funding directly to MPO staff, as these projects do not need to be initiated by MassDOT.

The MPO staff compiles project funding requests for projects into a Universe of Projects list, which consists of all identified projects being advanced for possible funding in the Bicycle Network and Pedestrian Connections, Complete Streets, Intersection Improvements, and Major Infrastructure investment programs. The Universe includes projects that are at advanced stages of project design, those that are undergoing preliminary engineering and design, and projects still in the conceptual planning stage. Those projects that are active municipal priorities and that are feasibly ready to be programmed in the current TIP cycle continue forward into the MPO’s project evaluation process. Projects that are not ready for programming remain in the Universe for consideration in future TIP cycles. A project Universe is not developed for Community Connections projects, as all eligible projects within this program will be considered for funding during the TIP cycle in which project proponents apply.

Project Evaluation (December-February)

The MPO staff uses its project evaluation criteria to logically and transparently evaluate and select projects for programming in the TIP that advance the MPO’s vision for transportation in the region. This process favors projects that support the following goals:

As noted previously, the MPO undertook a process of revising the TIP evaluation criteria prior to the launch of the FFYs 2022–26 TIP to enhance the alignment between the TIP project selection process and the MPO’s updated goals, objectives, and investment programs outlined in Destination 2040. In terms of the overall structure of the criteria, this process resulted in the following outcomes:

In addition to these broader structural changes, a number of updates were made to individual criteria to better accomplish the MPO’s goals in the LRTP:

Several other changes were made to the project evaluation criteria, which are detailed in Appendix A. The point distributions, categorized by MPO investment program and LRTP goal area, are also available in Figure 2-4. Projects scored using both sets of criteria are programmed in each of these four investment programs in the FFYs 2023–27 TIP, so both sets of criteria are referenced throughout this document.

Though many of the adjustments listed above were in development prior to the onset of the COVID-19 pandemic, the emerging lessons from this event reinforced the importance of making such changes. These changes include emphasizing criteria that award points to projects that invest in walking, bicycling, and transit infrastructure. Also, the need for new criteria that more directly address existing disparities in health and transportation access for minorities and low-income households has been put into stark relief throughout the pandemic. While the MPO did not elect to rescore any currently programmed projects with these new criteria, the revised criteria will be employed in coming TIP cycles to support the funding of transportation projects that act on the lessons learned from COVID-19.

Prior to the FFYs 2022–26 TIP cycle, the MPO also undertook a parallel process to update its evaluation criteria for the smaller-scale, first- and last-mile projects considered for funding through the Community Connections Program. These adjustments were based on the lessons learned from the pilot round of this program during the FFYs 2021–25 TIP cycle. In these revisions, MPO staff aimed to create a more focused set of criteria that better aligned with the types of projects pursuing funding through this program. Revisions to the Community Connections criteria also addressed the discrepancies between capital and operating projects, as the pilot criteria more heavily favored operating projects. These adjustments resulted in more balanced scores that better reflected the goals of the program when implemented for the FFYs 2022–26 TIP cycle. More information on the scoring areas for these criteria is available in Figure 2-3, and all the criteria are available in Appendix A. Projects scored using both sets of criteria are programmed in the Community Connections Program in the FFYs 2023–27 TIP, so both sets of criteria are referenced throughout this document.

Figure 2-3
TIP Project Evaluation Criteria: Point Distribution for Community Connections Projects

Figure 2-3 is a pie chart that shows the distribution of points across the six scoring areas considered when evaluating projects for funding through the MPO’s Community Connections Program. These criteria were used to score new projects considered in this investment program for the FFYs 2023–27 TIP.

Figure 2-4
TIP Project Evaluation Criteria: Point Distributions by Project Type (All Other Investment Programs)

Figure 2-4 is a bar chart that shows the distribution of points across the six scoring areas considered when evaluating projects for funding through the MPO’s Bicycle Network and Pedestrian Connections, Complete Streets, Intersection Improvements, Major Infrastructure, and Transit Modernization investment programs. Each bar reflects the varying points by goal area across project types, emphasizing that different types of projects are designed to accomplish different goals. These criteria were used to score new projects considered in these programs for the FFYs 2023–27 TIP.

In order for the MPO staff to conduct a complete project evaluation, each project proponent must provide enough information to meaningfully apply the criteria listed above. Bicycle Network and Pedestrian Connections, Complete Streets, Intersection Improvements, and Major Infrastructure projects must have a functional design report or be near the 25 percent design stage, or its plans must include the level of detail defined in a functional design report. (See MassDOT’s Project Development and Design Guide for information about the contents of a functional design report. This guide is available at mass.gov/lists/design-guides-and-manuals.) For Community Connections projects, proponents must submit a complete application to the MPO, including required supporting documentation.

After MPO staff have completed an initial round of project scoring, draft scores are distributed to project proponents for their review. The MPO’s goal is to fairly and accurately assess all projects, making this review a critical component of the TIP process. Proponents are encouraged to submit feedback to MPO staff on their scores if they feel any criteria have been applied inaccurately. Proponents are also encouraged to submit additional supporting documentation on their projects if doing so would help clarify or correct any elements of the draft scoring. MPO staff take all proponent feedback into consideration and make any warranted adjustments to project scores before considering the evaluation process final and preparing the scores for presentation to the MPO.

For more details about the criteria used to score projects and project evaluation results for projects considered for programming in this TIP, see Appendix A.

TIP Readiness Day (February)

On TIP Readiness Day, the MPO staff meets with members of the MassDOT Highway Division to review cost and schedule changes related to currently programmed projects, which are undergoing design review, permitting, and right-of-way acquisition. The MPO board then considers these updated project construction costs and changes to the expected dates for construction advertisement when making decisions about changes to TIP programming. These changes have an impact on the ability of the MPO to program its target funds for new projects in the five-year TIP.

Between the development of the FFYs 2021–25 TIP and the FFYs 2022–26 TIP, more than half of the projects programmed by the MPO experienced cost increases, many of which represented significant increases in percentage terms or in absolute cost. These changes placed severe limitations on the MPO’s ability to consider new projects for funding during the FFYs 2022–26 TIP cycle. As a partner to MassDOT’s Highway Division and Office of Transportation Planning, the MPO recognizes its role in supporting the on-time and on-budget delivery of projects by proponents. For this reason, the MPO board created a committee in the wake of the FFYs 2022–26 TIP cycle to further explore the causes of project cost increases and devise MPO policy changes to support more reliable project delivery by all parties.

The TIP Project Cost Ad Hoc Committee began its work in June 2021 and advanced a set of policy recommendations to the full MPO board in September 2021. These changes were formally adopted by the MPO on November 4, 2021, and were in effect for the development of the FFYs 2023–27 TIP. In addition to the requirement that project proponents submit 25 percent design plans and obtain an updated cost estimate for their project prior to obtaining funding in the TIP, as detailed previously, the committee’s work resulted in several other policy changes.

Most notably, the MPO board adopted a policy that proponents of any projects that experienced a cost increase of 25 percent or greater (for projects costing less than $10 million) or of greater than $2.5 million (for projects costing more than $10 million) would be required to present to the MPO board on the reasons for these cost increases. The MPO would then compare this project—at its new cost—to other projects based on a cost-effectiveness evaluation before making a decision on whether or not to fund the project at its higher cost. These cost changes are most often revealed through conversations between MassDOT staff and MPO staff during TIP Readiness Day, making this new policy especially relevant at this stage of TIP development.

Staff Recommendation and Project Selection (March-April)

Using the evaluation scores and information gathered about project readiness (when a project likely would be fully designed and ready for advertisement) and cost, staff prepares possible TIP project programming scenarios for the MPO’s consideration. When developing these scenarios, MPO staff also considers whether a project was programmed in the LRTP, LRTP-based guidelines for allocating funds to different programs or project types, the distribution of investments across the region, and availability of sufficient funding. The MPO staff gather feedback from board members, project proponents, and the public to inform a final staff recommendation, which is then presented to the MPO for approval before it is included in the draft TIP for public review.

Given the significant increase in Regional Target funding in the FFYs 2023–27 TIP resulting from the passage of the BIL, the MPO selected a significant number of new projects for funding during this TIP cycle, including

In total, the MPO allocated more than $236 million in this TIP cycle to projects not previously funded in the Regional Target program. More information on the projects funded in the FFYs 2023–27 TIP is available in Chapter 3.

Selection Process for Projects Prioritized by the State and Transit Agencies

As discussed above, the selection of transit, bridge, and statewide infrastructure projects for programming in the TIP draws primarily from the CIPs produced by MassDOT and the MBTA. These agencies evaluate projects for inclusion in CIP programs using criteria established by the independent Project Selection Advisory Council (PSAC). The following criteria from the PSAC process guide project evaluation:

Projects that receive the highest priority are those that meet each agency’s goals for maintaining and improving the overall condition and reliability of the system; modernizing the system to make it safer and more accessible and to accommodate growth; and expanding and diversifying transportation options for communities. These project-prioritization processes may also reflect other planning initiatives, such as Focus40, the MBTA’s 25-year investment plan, or MassDOT’s modal plans. More information on regulatory and planning guidance governing TIP project prioritization is available in Appendix E. Once project prioritization is complete, programming decisions are made based on these evaluations and information regarding project readiness, program sizing, and existing asset management plans.

As discussed above, the transit element of the TIP also includes the Federal-Aid Programs of the other two RTAs in the region, CATA and MWRTA. Once selection processes are complete for all four agencies, these agencies submit their lists of bridge and roadway projects, bicycle and pedestrian improvements, statewide infrastructure items, and transit capital projects to the MPO for review.

APPROVING THE TIP

Approval of the Draft TIP for Public Review

The MPO board considers the project evaluation results and staff recommendation when prioritizing projects for Regional Target funding. The board also considers public comments, the regional importance of projects, and other factors. In addition to prioritizing the Regional Target funding, the MPO board reviews MassDOT’s proposed statewide highway programming and the proposed capital programs for the MBTA, CATA, and MWRTA before voting to release a draft TIP for public review.

The MPO board votes to release the draft document for public review and invites members of the public, municipal and elected officials, and other stakeholders in the Boston region to review the proposed TIP. The MPO staff hosts outreach events during the public review period to elicit comments on the draft document. (See Appendix C for a full list of public comments submitted on the draft TIP.)

Approval of the Draft TIP

After the public review period ends, the MPO staff and board review all public comments, and the board may change the programming or the document as appropriate before endorsing the TIP. MassDOT staff incorporates the MPO-endorsed TIP into the State Transportation Improvement Program (STIP) and submits it to the FHWA and FTA for approval. The FHWA, FTA, and US Environmental Protection Agency review the STIP and certify it by September 30, the end of the federal fiscal year.

uPDATING THE TIP

The TIP is a dynamic program that may be amended and adjusted throughout the year. Administrative modifications and amendments are often introduced because of changes in project status (advertisement readiness), project cost, project design scope, or available revenue. An amendment is a revision that requires public review and a demonstration of fiscal constraint.

Consistent with federal guidelines, the Boston Region MPO must release an amendment if there is (1) a change in project cost of $500,000 or more for projects valued at $5 million or less, or (2) a change of 10 percent or more of the project cost for projects valued greater than $5 million. TIP amendments are also released if there is a proposal to add or remove a project from the TIP or if the programming year of a project is changed. Cost changes that are less than the above threshold amounts may be considered in the form of administrative modifications or adjustments, which must still undergo MPO board action for approval. Administrative modifications or adjustments are also undertaken in the event that a project’s funding source changes. Although a public review period is not required for administrative modifications or adjustments, one may be offered at the MPO board’s discretion.

Regardless of the nature of an amendment, all proposed TIP amendments are presented in a public setting at an MPO meeting, and details are posted on the MPO’s website, bostonmpo.org. Public notices are distributed through the MPO’s email contact list, which members of the public may join by signing up on the MPO’s website. Municipal staff who are TIP contacts at the affected municipalities and the public are notified of pending amendments at the start of an amendment’s public review period.

Public Notice

Notices of draft TIP amendments include a summary of the amendment’s contents, dates of the public review period, contact information for submitting a comment to the MPO, and the date, time, and location that the MPO will vote on that amendment. Municipal representatives and members of the public are invited to submit written or oral testimony at the MPO meetings at which amendments are discussed or voted upon.

The MPO typically holds a 21-day public review period before taking final action on an amendment. In extraordinary circumstances, the MPO may vote to shorten the public review period to a minimum of 15 days. (These circumstances are detailed in the MPO’s Public Engagement Plan.)

The MPO’s website is the best place to find current information about the TIP. All changes to the draft TIP and changes to the endorsed TIP, such as amendments and modifications that have been approved by the MPO, are available on the TIP webpage, bostonmpo.org/tip.

Comments or questions about the draft TIP materials may be submitted directly to the MPO staff via the website, email, or US mail, or voiced at MPO meetings and other public MPO events.

2-1 The Community Connections Program was formerly referred to as the Community Transportation/Parking/Clean Air and Mobility Program when it was originally created in the MPO’s 2015 LRTP, Charting Progress to 2040.

back to top

Chapter 3
Summary of Highway and Transit Programming

The Transportation Improvement Program (TIP) tables included in this chapter present a listing of all the projects and programs funded with federal highway and transit aid in the Boston region during federal fiscal years (FFYs) 2023–27. These funding tables are also included as part of the State Transportation Improvement Program (STIP).

Table 3-1 presents a summary of the Boston Region Metropolitan Planning Organization’s (MPO) share of Regional Target funds from the Federal-Aid Highway Program. The allocation of these funds is constrained by projections of available federal aid. As shown in Table 3-1, the MPO has programmed much of the available discretionary funds within the limits of projected funding for highway funding programs. As such, the FFYs 2023–27 TIP Regional Target Program complies with financial constraint requirements.

Table 3-1
Boston Region MPO Regional Target Program Funding Summary

  FFY 2023 FFY 2024 FFY 2025 FFY 2026 FFY 2027 Total

Regional Target Obligation Authority

$128,950,081

$130,647,095

$128,427,689

$125,285,688

$132,045,285

$645,355,838

Regional Target Funds Programmed

$125,515,245

$114,218,512

$124,612,902

$123,179,070

$128,586,581

$616,112,310

Regional Target Funds Unprogrammed

$3,434,836

$16,428,583

$3,814,787

$2,106,618

$3,458,704

$29,243,528

Source: Boston Region MPO.

As discussed in Chapter 2, the signing of the Bipartisan Infrastructure Law (BIL), on November 15, 2021, increased the amount of Regional Target funding available to the Boston Region MPO for the development of the FFYs 2023–27 TIP by approximately 20 percent from the funding levels in the FFYs 2022–26 TIP. These additional funds allowed the MPO to program a significantly greater number of new projects in this TIP cycle (22) than in the FFYs 2022–26 TIP cycle (10) or the FFYs 2021–25 TIP cycle (8).

In the development of the FFYs 2023–27 TIP, the cost-increase issues for projects already programmed in the TIP were not as pervasive as they were in the development of the prior two TIPs. This allowed the MPO to retain a vast majority of its new funding for the programming of additional projects. The projects selected by the MPO for funding for the first time in the FFYs 2023–27 TIP are listed in Table 3-2.

As in most years, the majority of the funding available for allocation by the MPO during the FFYs 2023–27 TIP cycle was in the fifth and final year of the TIP, FFY 2027. Unlike in most years, however, the addition of approximately $20 million in new BIL funding annually beginning in FFY 2023 created new funding surpluses in the early federal fiscal years of the TIP (FFYs 2023 and 2024). These surpluses were compounded by programming delays for two projects already funded by the MPO (project #606453—Improvements on Boylston Street and project #606226—Reconstruction of Rutherford Avenue, both in Boston). Together, these dynamics led to a funding surplus in excess of $90 million in FFYs 2023 and 2024.

The MPO did not have any currently funded Regional Target projects that could be accelerated to make use of these funds, so the MPO worked with MassDOT and the MBTA to identify projects that could be funded in these fiscal years. Jointly, MassDOT and the MBTA brought more than a dozen projects to the MPO for consideration, from which the MPO selected three projects for funding in FFYs 2023 and 2024:

These projects were not formally evaluated using the MPO’s project selection criteria prior to the MPO making draft funding decisions, as MPO staff did not have sufficient time to score the projects prior to the deadline for MPO decision-making. Despite not being scored, they generally align well with many of the MPO’s goals, including enhancing bicycle and pedestrian safety and access, and maintaining a state of good repair for the region’s transit system and critical roadways. Scoring information will be included for these projects when it is available.

Table 3-2
New Regional Target Projects Funded in the FFYs 2023–27 TIP

Project Name Municipality (Proponent) MPO Investment Program FFYs of Funding Regional Target Dollars Programmed in FFYs 2023–27

Lynn Station Improvements Phase II

Lynn (MBTA)

Transit Modernization

2023–24

$48,100,000

Rehabilitation of Washington Street

Brookline

Complete Streets

2027

$30,030,812

Bridge Rehabilitation, Commonwealth Avenue (Route 30) over the Charles River

Newton and Weston (MassDOT)

Complete Streets

2024

$22,725,820

Community Path, Belmont Component of the MCRT (Phase 1)

Belmont

Bicycle and Pedestrian

2026

$21,034,382

McGrath Boulevard Construction*

Somerville (MassDOT)

Major Infrastructure

2027

$20,000,000

Reconstruction on Route 30

Weston

Complete Streets

2026

$17,028,272

Reconstruction of Western Avenue*

Lynn

Complete Streets

2027

$15,000,000

Boston Street Improvements

Salem

Complete Streets

2026

$13,977,600

Park and Pearl Street Reconstruction

Chelsea

Complete Streets

2027

$12,123,769

Rail Trail Construction

Swampscott

Bicycle and Pedestrian

2027

$8,932,000

Forest Hills Station Improvement Project**

Boston (MBTA)

Transit Modernization

2024

$6,400,000

Intersection Improvements at Boston Post Road (Route 20) at Wellesley Street

Weston

Intersection Improvements

2026

$2,681,330

Montachusett RTA Microtransit Service

Bolton, Boxborough, Littleton, and Stow (MART)

Community Connections

2023–25

$1,316,061

Pleasant Street Shuttle Service Expansion

Watertown

Community Connections

2023–25

$1,002,198

NewMo Microtransit Service Expansion

Newton

Community Connections

2023–25

$890,574

CATA On Demand Microtransit Service Expansion

Gloucester and Rockport (CATA)

Community Connections

2023–25

$813,291

Stoneham Shuttle Service

Stoneham

Community Connections

2023–25

$796,817

CatchConnect Microtransit Service Expansion

Hudson and Marlborough (MWRTA)

Community Connections

2023–25

$450,163

Bluebikes Station Replacement and System Expansion

Cambridge

Community Connections

2023

$349,608

Bluebikes System Expansion

Malden and Medford

Community Connections

2023

$145,821

Bluebikes System Expansion

Salem

Community Connections

2023

$119,629

Bicycle Parking along the Bruce Freeman Rail Trail

Acton

Community Connections

2023

$8,017

Chenery Middle School Bicycle Parking

Belmont

Community Connections

2023

$4,376

Total N/A N/A N/A $223,930,540

Note: Funding amounts in this table include both federal and non-federal funds, including matching funds.

*          Funding in this table represents the first year of funding, with additional funding anticipated to be allocated to these projects by the Boston Region MPO in future fiscal years.

**        Funding in this table represents partial funding. Additional funding sources will be identified for the Forest Hills Station Improvement Project in future fiscal years. The total project cost is $68,000,000.

CATA = Cape Ann Transportation Authority. FFY = federal fiscal year. MART = Montachusett Area Regional Transit. MCRT = Mass Central Rail Trail. MWRTA = MetroWest Regional Transit Authority. N/A = not applicable. RTA = regional transit authority.

Source: Boston Region MPO.

In addition to the above, several other key decisions were made by the MPO in the drafting of the FFYs 2023–27 Regional Target Program, including:

Additional details of the specific projects programmed with Regional Target funding are shown in Section 1A of each annual element of the TIP tables (Table 3-7). The other sections in Table 3-7 (Sections 1B, 2A, 2B, 2C, and 3B) list the following:

Tables 3-8, 3-9, 3-10, and 3-11 list the federally funded transit projects and programs in the Boston region that the Massachusetts Bay Transportation Authority (MBTA), MetroWest Regional Transit Authority (MWRTA), and Cape Ann Transportation Authority (CATA) plan to undertake.

The second part of this chapter includes detailed descriptions of projects funded through both the Regional Target and statewide portions of the Highway Program, including evaluation scores (for MPO-funded projects), project proponents, and funding details. The pages are organized alphabetically by the municipality in which each project is located.

Investment Summary

This section summarizes the investments made by the Boston Region MPO, Massachusetts Department of Transportation (MassDOT), MBTA, CATA, and MWRTA in the FFYs 2023–27 TIP. Table 3-3 shows the Boston Region MPO’s investments of Regional Target funding—including both the number of projects and the dollar amount—by investment program. These investments are aimed at making progress towards the MPO’s goals for the region, including enhancing safety for all users, preserving and modernizing the transportation system, promoting mobility and reducing congestion, supporting clean air and sustainability, ensuring all have equitable access to the transportation system, and fostering economic vitality in the region through investments in transportation.

Due to the passage of the BIL, the MPO’s Regional Target Program increased in size by approximately $106 million between the FFYs 2022–26 TIP and the FFYs 2023–27 TIP to a total program size of more than $645 million.

Table 3-3
FFYs 2023–27 Boston Region MPO Regional Target Investment Summary

MPO Investment Program Number of Projects Regional Target Dollars Programmed

Bicycle Network and Pedestrian Connections

4

$40,222,704

Community Connections (allocated to projects)

13

$6,374,274

Community Connections (not yet allocated to projects)

N/A

$6,716,799

Complete Streets*

22

$306,251,630

Intersection Improvements

7

$47,175,058

Major Infrastructure—Roadway

3

$135,371,843

Transit Modernization (allocated to projects)

2

$54,500,000

Transit Modernization (not yet allocated to projects)

N/A

$19,500,000

Unprogrammed N/A $29,243,530
Total 51 $645,355,838

Note: Funding amounts in this table include both federal and non-federal funds, including matching funds.

*One MPO-funded Complete Streets project (608348—Bridge Street) is partially funded through MassDOT’s Earmark Discretionary Program.

N/A = not applicable.

Source: Boston Region MPO.

Table 3-4 shows MassDOT’s FFYs 2023–27 TIP investments—including both the number of projects or programs and the dollar amount—organized by MassDOT program. MassDOT’s investments are distributed across a variety of programs and will support bridge and pavement improvements, roadway improvements and reconstruction, new bicycle and pedestrian infrastructure, and safety improvements. More details on these investments are available on the project summary pages that comprise the second section of this chapter.

As detailed above for the MPO’s Regional Target Program, the BIL significantly increased the funding available to MassDOT for programming projects in the statewide Highway Program. Most notably, the BIL’s new Bridge Formula Program allowed MassDOT to more than triple the amount of funding allocated to federal-aid bridge projects in the region. Furthermore, FFY 2026 represents the conclusion of grant anticipation notes (GANS) payments for MassDOT’s Accelerated Bridge Program (ABP). The winding down of this program, combined with the passage of the 2021 Massachusetts Transportation Bond Bill and the new federal funding available through the BIL, allowed for the creation of MassDOT’s Next Generation Bridge Program (NGBP).

Like the ABP, the NGBP will leverage state bonding capacity to accelerate the rehabilitation and replacement of critical or structurally deficient bridges across Massachusetts. In the FFYs 2023–27 TIP, 28 bridge projects are funded by MassDOT through the NGBP using state bond bill funds. These projects are shown in the TIP because the debt payments on these bonds will be paid using future federal formula funding.

In addition to higher levels of investment in bridges, the new funding available through the BIL has also supported increased investment across MassDOT’s other programs in the FFYs 2023–27 TIP, including the Bicycle and Pedestrian Program, the Intersection Improvements Program, the Interstate and Non-Interstate Pavement Programs, the Roadway Reconstruction Program, and the Safety Improvements Program. The passage of the BIL and the addition of new state bonding capacity have collectively supported an increase in MassDOT’s Highway Program of more than $1.1 billion between the FFYs 2022–26 TIP and the FFYs 2023–27 TIP to a total program size of more than $1.8 billion.

Table 3-4
FFYs 2023–27 MassDOT Highway Program Investment Summary

MassDOT Program Number of Projects MassDOT Dollars Programmed

Bicycle and Pedestrian

9

$46,668,222

Federal-Aid Bridge Program

27

$544,133,685

Next Generation Bridge Program

28

$553,337,190

Earmarks or Discretionary Grants*

6

$94,623,709

Intersection Improvements

7

$33,530,370

Interstate Pavement

5

$98,117,990

Non-Interstate Pavement

8

$98,281,156

Roadway Reconstruction

18

$233,829,517

Safety Improvements

8

$49,121,035

Non-Federal Aid (NFA)

1

$106,720,000

Total 111 $1,858,362,874

Note: Funding amounts in this table include both federal and non-federal funds, including matching funds.

*          Four projects receiving earmark funding are also receiving funding through other sources: 606476—Sumner Tunnel Improvements is funded through MassDOT’s Roadway Reconstruction Program; 608348—Bridge Street is funded through the MPO’s Complete Streets Program; 608562—Mystic Avenue and McGrath Highway is funded through MassDOT’s Intersection Improvements Program; and 607977—Interstates 90/495 Interchange Reconstruction is funded through MassDOT’s Roadway Reconstruction and NFA Programs. Each project is counted in the tally for each funding category but is only counted once in the total number of projects funded.

†          Two projects are funded through this program while also receiving funding through MassDOT’s Safety Improvements Program (607748—Intersection and Signal Improvements on Massachusetts Avenue at Piper Road and Taylor Road in Acton and 611969—Intersection Improvements on Route 16 in Everett). These projects are both counted in the tally for the Intersection Improvements and Safety Improvements categories but are each only counted once in the total number of projects funded.

Sources: MassDOT and the Boston Region MPO.

Table 3-5 shows the MBTA’s programs and associated FFYs 2023–27 TIP funding amounts, with additional details on the MBTA’s programs and projects in Tables 3-8 and 3-9 on the following pages. The passage of the BIL has helped support an increase in the MBTA’s federal capital program of nearly $400 million between the FFYs 2022–26 TIP and the FFYs 2023–27 TIP to a total program size of more than $3.9 billion. Investments made through these programs allow the MBTA to continue to maintain and modernize its infrastructure in support of the agency’s role as the largest transit provider in the Commonwealth of Massachusetts.

The MBTA caters to a wide range of needs, serving the Boston region with commuter rail, light rail, subway, fixed-route bus, and paratransit services. The MBTA prioritizes projects that keep the existing transit system in a state of good repair, including the purchase of new rolling stock, accessibility and resiliency improvements to stations, the rehabilitation of bridges and tunnels, and the replacement of tracks and signals to support system-wide reliability. Limited system expansion projects are also undertaken through the MBTA’s federal capital program. Further information on how the MBTA’s investments support system safety and condition is available in Chapter 4.

Table 3-5
 FFYs 2023–27 MBTA Transit Program Investment Summary

Federal Transit Administration Program MBTA Program MBTA Dollars Programmed

Section 5307: Urbanized Area Formula Grants

Bridge and Tunnel Program

$50,000,000

Section 5307: Urbanized Area Formula Grants

Revenue Vehicle Program

$677,862,747

Section 5307: Urbanized Area Formula Grants

Signals/Systems Upgrade Program

$255,488,653

Section 5307: Urbanized Area Formula Grants

Stations and Facilities Program

$254,651,320

Section 5337: Fixed Guideway/Bus Funds

Bridge and Tunnel Program

$478,403,439

Section 5337: Fixed Guideway/Bus Funds

Revenue Vehicle Program

$240,364,516

Section 5337: Fixed Guideway/Bus Funds

Signals/Systems Upgrade Program

$215,250,862

Section 5337: Fixed Guideway/Bus Funds

Stations and Facilities Program

$558,530,687

Section 5339: Bus and Bus Facilities Funds

Bus Program

$40,418,259

Other Federal Funds

Positive Train Control*

$469,150,000

Other Federal Funds

RRIF/TIFIA Financing Program

$692,500,000

Total N/A $3,932,620,483

Note: Federal Transit Administration formula funds (Sections 5307, 5337 and 5339) are based on estimated apportionments for FFYs 2023-27. These apportionments include additional funding to be made available through the Bipartisan Infrastructure Law, based on current estimates. TIP programs and projects are based on a preliminary draft CIP as of April 2022. Adjustments will be made to federal projects and budgets as the CIP process is finalized. Funding amounts in this table include both federal and non-federal funds, including matching funds.

* Positive Train Control investments are funded with RRIF funds.

† RRIF/TIFIA financing program funding is an initial estimate and will be refined as projects are identified and loans are finalized with the Build America Bureau.

CIP = Capital Investment Plan. FFY = federal fiscal year. N/A = not applicable. RRIF = Railroad Rehabilitation and Improvement Financing. TIFIA = Transportation Infrastructure Finance and Innovation Act. TIP = Transportation Improvement Program.

Sources: MBTA and the Boston Region MPO.

Table 3-6 summarizes CATA and MWRTA investments included in the FFYs 2023–27 TIP, and more information is available on each agency’s investments in Tables 3-10 and 3-11. Though the MBTA provides commuter rail service to the Cape Ann communities of Rockport and Gloucester, CATA provides additional paratransit and fixed-route bus services to these communities and to Danvers, Peabody, Ipswich, Essex, and Beverly. CATA’s federal capital program supports its role in providing critical transportation alternatives to residents and visitors of the area, including through the replacement of buses, the modernization of facilities, and the maintenance of assets.

MWRTA similarly complements MBTA commuter rail service, operating fixed-route bus, on-demand microtransit, and commuter shuttle services to a number of communities in the MetroWest subregion. MWRTA’s federal capital program supports this mission by funding vehicle replacements, station and facility maintenance and improvements, and operating assistance for paratransit services, among other efforts. Other projects funded in MWRTA’s 2023–27 TIP include the electrification of the agency’s paratransit fleet and investments in technology to support travel training and customer service efforts.

Overall program sizes for CATA and MWRTA are substantially similar in the FFYs 2023–27 TIP to those in the FFYs 2022–26 TIP. These agencies collectively received an approximately $3.2 million increase in funding levels in this TIP for a total program size of more than $55.6 million.

Table 3-6
FFYs 2023–27 CATA and MWRTA Transit Program Investment Summary

Regional Transit Authority Federal Transit Administration Program  RTA Dollars Programmed

CATA

Section 5307: Urbanized Area Formula Funding

$4,155,000

CATA

State Transportation Bond Capital Assistance

$3,065,000

CATA

Municipal and Local Assessments

$356,250

MWRTA

Section 5307: Urbanized Area Formula Funding

$12,339,700

MWRTA

Section 5339: Bus and Bus Facilities

$3,022,063

MWRTA

State Transportation Bond Capital Assistance

$3,417,258

MWRTA

Other Federal

$27,302,259

MWRTA

Other Non-Federal

$2,000,000

Total N/A $55,657,530

Note: Funding amounts in this table include both federal and non-federal funds, including matching funds.

CATA = Cape Ann Transportation Authority. FFY = federal fiscal year. MWRTA = Metro West Regional Transit Authority. N/A = not applicable. RTA = regional transit administration
Sources: CATA, MWRTA, and the Boston Region MPO.

Tables 3-7 through 3-11 build on the summary tables listed above by detailing investments made through both the Highway and Transit Programs by project, program, and funding year.

Table 3-7
FFYs 2023-27 TIP Highway Programming

Year MassDOT Project ID MPO Municipality MassDOT Project Description District Funding Source Adjusted TFPC Total Programmed Funds Federal Funds Non-Federal Funds Other Information
Federal Fiscal Year 2023 $393,036,161 $301,597,787 $91,438,374
Section 1A / Regionally Prioritized Projects $125,515,245 $101,066,332 $24,448,913
Intersection Improvements $16,878,342 $13,806,809 $3,071,533
2023 606130 Boston Region Norwood NORWOOD- INTERSECTION IMPROVEMENTS @ ROUTE 1A & UPLAND ROAD/WASHINGTON STREET & PROSPECT STREET/FULTON STREET 5 CMAQ $7,952,280 $3,000,000 $2,400,000 $600,000 Construction; CMAQ+STBG Total Cost = $7,952,280; MPO Evaluation Score = 53.
2023 606130 Boston Region Norwood NORWOOD- INTERSECTION IMPROVEMENTS @ ROUTE 1A & UPLAND ROAD/WASHINGTON STREET & PROSPECT STREET/FULTON STREET 5 STBG $7,952,280 $4,952,280 $3,961,824 $990,456 Construction; CMAQ+STBG Total Cost = $7,952,280; MPO Evaluation Score = 53.
2023 608889 Boston Region Framingham FRAMINGHAM- TRAFFIC SIGNAL INSTALLATION AT EDGELL ROAD AT CENTRAL STREET 3 CMAQ $2,484,704 $2,484,704 $1,987,763 $496,941 Construction; CMAQ Total Cost = $2,484,704; MPO Evaluation Score = 41.
2023 609253 Boston Region Wilmington WILMINGTON- INTERSECTION IMPROVEMENTS AT LOWELL STREET (ROUTE 129) AND WOBURN STREET 4 CMAQ $6,441,358 $3,400,000 $2,720,000 $680,000 Construction; CMAQ+HSIPTotal Cost = $6,441,358; MPO Evaluation Score = 53.
2023 609253 Boston Region Wilmington WILMINGTON- INTERSECTION IMPROVEMENTS AT LOWELL STREET (ROUTE 129) AND WOBURN STREET 4 HSIP $6,441,358 $3,041,358 $2,737,222 $304,136 Construction; CMAQ+HSIPTotal Cost = $6,441,358; MPO Evaluation Score = 53.
Roadway Reconstruction $71,045,830 $57,186,664 $13,859,166
2023 607244 Boston Region Winthrop WINTHROP- RECONSTRUCTION & RELATED WORK ALONG WINTHROP STREET & REVERE STREET CORRIDOR 6 CMAQ $6,617,959 $4,000,000 $3,200,000 $800,000 Construction; CMAQ+STBG+TAP Total Cost
= $6,617,959; MPO Evaluation Score = 54;
TAP Proponent = Winthrop.
2023 607244 Boston Region Winthrop WINTHROP- RECONSTRUCTION & RELATED WORK ALONG WINTHROP STREET & REVERE STREET CORRIDOR 6 STBG $6,617,959 $2,057,959 $1,646,367 $411,592 Construction; CMAQ+STBG+TAP Total Cost
= $6,617,959; MPO Evaluation Score = 54;
TAP Proponent = Winthrop.
2023 607244 Boston Region Winthrop WINTHROP- RECONSTRUCTION & RELATED WORK ALONG WINTHROP STREET & REVERE STREET CORRIDOR 6 TAP $6,617,959 $560,000 $448,000 $112,000 Construction; CMAQ+STBG+TAP Total Cost
= $6,617,959; MPO Evaluation Score = 54;
TAP Proponent = Winthrop.
2023 607777 Boston Region Watertown WATERTOWN- REHABILITATION OF MOUNT AUBURN STREET (ROUTE 16) 6 CMAQ $27,250,087 $12,000,000 $9,600,000 $2,400,000 Construction; HSIP+CMAQ+STBG Total Cost = $27,250,087; MPO Evaluation Score = 75
2023 607777 Boston Region Watertown WATERTOWN- REHABILITATION OF MOUNT AUBURN STREET (ROUTE 16) 6 HSIP $27,250,087 $2,000,000 $1,800,000 $200,000 Construction; HSIP+CMAQ+STBG Total Cost = $27,250,087; MPO Evaluation Score = 75
2023 607777 Boston Region Watertown WATERTOWN- REHABILITATION OF MOUNT AUBURN STREET (ROUTE 16) 6 STBG $27,250,087 $13,250,087 $10,600,070 $2,650,017 Construction; HSIP+CMAQ+STBG Total Cost = $27,250,087; MPO Evaluation Score = 75
2023 607899 Boston Region Dedham DEDHAM- PEDESTRIAN IMPROVEMENTS ALONG BUSSEY STREET, INCLUDING SUPERSTRUCTURE REPLACEMENT, D-05-010, BUSSEY STREET OVER MOTHER BROOK 6 STBG $6,314,855 $5,787,659 $4,630,127 $1,157,532 Construction; STBG+TAP Total Cost = $6,314,855; MPO Evaluation Score = 35; TAP Proponent = Dedham.
2023 607899 Boston Region Dedham DEDHAM- PEDESTRIAN IMPROVEMENTS ALONG BUSSEY STREET, INCLUDING SUPERSTRUCTURE REPLACEMENT, D-05-010, BUSSEY STREET OVER MOTHER BROOK 6 TAP $6,314,855 $527,196 $421,757 $105,439 Construction; STBG+TAP Total Cost = $6,314,855; MPO Evaluation Score = 35; TAP Proponent = Dedham.
2023 608348 Boston Region Beverly BEVERLY- RECONSTRUCTION OF BRIDGE STREET 4 CMAQ $12,594,932 $6,000,000 $4,800,000 $1,200,000 Construction; CMAQ+STBG+Earmark Total Cost = $12,594,932; MPO Evaluation Score = 66.
2023 608348 Boston Region Beverly BEVERLY- RECONSTRUCTION OF BRIDGE STREET 4 STBG $12,594,932 $3,590,507 $2,872,406 $718,101 Construction; CMAQ+STBG+Earmark Total Cost = $12,594,932; MPO Evaluation Score = 66.
2023 608707 Boston Region Quincy QUINCY- RECONSTRUCTION OF SEA STREET  6 STBG $6,052,562 $5,826,308 $4,661,046 $1,165,262 Construction; STBG+TAP Total Cost = $6,052,562; MPO Evaluation Score = 40; TAP Project Proponent = Quincy.
2023 608707 Boston Region Quincy QUINCY- RECONSTRUCTION OF SEA STREET  6 TAP $6,052,562 $226,254 $181,003 $45,251 Construction; STBG+TAP Total Cost = $6,052,562; MPO Evaluation Score = 40; TAP Project Proponent = Quincy.
2023 608933 Boston Region Peabody PEABODY- REHABILITATION OF CENTRAL STREET 4 CMAQ $15,219,860 $6,000,000 $4,800,000 $1,200,000 Construction; CMAQ+HSIP+STBG Total Cost
= $15,219,860; MPO Evaluation Score = 61.
2023 608933 Boston Region Peabody PEABODY- REHABILITATION OF CENTRAL STREET 4 HSIP $15,219,860 $1,500,000 $1,350,000 $150,000 Construction; CMAQ+HSIP+STBG Total Cost
= $15,219,860; MPO Evaluation Score = 61.
2023 608933 Boston Region Peabody PEABODY- REHABILITATION OF CENTRAL STREET 4 STBG $15,219,860 $7,719,860 $6,175,888 $1,543,972 Construction; CMAQ+HSIP+STBG Total Cost
= $15,219,860; MPO Evaluation Score = 61.
Transit Grant Program $2,137,307 $1,709,846 $427,461
2023 S12114 Boston Region Canton ROYALL STREET SHUTTLE   CMAQ $534,820 $177,177 $141,742 $35,435 Operations; CMAQ Total Cost = $534,820; MPO Evaluation Score = 51; Project funded through MPO's Community Connections Program.
2023 S12125 Boston Region Newton NEWTON MICROTRANSIT SERVICE 6 CMAQ $427,000 $152,000 $121,600 $30,400 Operations; CMAQ Total Cost = $727,000; MPO Evaluation Score = 53; Project funded over three fiscal years (2021-2023) through MPO's Community Connections Program.
2023 S12694 Boston Region Newton NEWMO MICROTRANSIT SERVICE EXPANSION 6 CMAQ $890,574 $412,665 $330,132 $82,533 Operations; CMAQ Total Cost = $890,574; MPO Evaluation Score = 87; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program.
2023 S12695 Boston Region Cambridge BLUEBIKES STATION REPLACEMENT AND SYSTEM EXPANSION 6 CMAQ $349,608 $349,608 $279,686 $69,922 Construction; CMAQ Total Cost = $349,608; MPO Evaluation Score = 78; Project funded through MPO's Community Connections Program.
2023 S12696 Boston Region Multiple BLUEBIKES SYSTEM EXPANSION 4 CMAQ $145,821 $145,821 $116,657 $29,164 Construction; CMAQ Total Cost = $145,821; MPO Evaluation Score = 78; Project funded through MPO's Community Connections Program.
2023 S12697 Boston Region Watertown PLEASANT STREET SHUTTLE SERVICE EXPANSION 6 CMAQ $1,002,198 $437,825 $350,260 $87,565 Operations; CMAQ Total Cost = $1,002,198; MPO Evaluation Score = 78; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program.
2023 S12698 Boston Region Salem BLUEBIKES SYSTEM EXPANSION 4 CMAQ $119,629 $119,629 $95,703 $23,926 Construction; CMAQ Total Cost = $119,629; MPO Evaluation Score = 77; Project funded through MPO's Community Connections Program.
2023 S12699 Boston Region Stoneham STONEHAM SHUTTLE SERVICE 4 CMAQ $796,817 $330,189 $264,151 $66,038 Operations; CMAQ Total Cost = $796,817; MPO Evaluation Score = 72; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program.
2023 S12702 Boston Region Acton BICYCLE PARKING ALONG THE BRUCE FREEMAN RAIL TRAIL 3 CMAQ $8,017 $8,017 $6,414 $1,603 Construction; CMAQ Total Cost = $8,017; MPO Evaluation Score = 58; Project funded through MPO's Community Connections Program.
2023 S12704 Boston Region Belmont CHENERY MIDDLE SCHOOL BICYCLE PARKING 4 CMAQ $4,376 $4,376 $3,501 $875 Construction; CMAQ Total Cost = $4,376; MPO Evaluation Score = 49.75; Project funded through MPO's Community Connections Program.
Flex to FTA $35,453,766 $28,363,013 $7,090,753
2023 S12700 Boston Region Multiple CATA ON DEMAND MICROTRANSIT SERVICE EXPANSION 4 CMAQ $813,291 $333,450 $266,760 $66,690 Operations; CMAQ Total Cost = $813,291; MPO Evaluation Score = 61.75; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program. Flex to CATA.
2023 S12701 Boston Region Multiple MWRTA CATCHCONNECT MICROTRANSIT SERVICE EXPANSION 3 CMAQ $450,163 $141,250 $113,000 $28,250 Operations; CMAQ Total Cost = $450,163; MPO Evaluation Score = 59; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program. Flex to MWRTA.
2023 S12703 Boston Region Multiple MONTACHUSETT RTA MICROTRANSIT SERVICE 3 CMAQ $1,316,061 $479,066 $383,253 $95,813 Operations; CMAQ Total Cost = $1,316,061; MPO Evaluation Score = 57; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program. Flex to MART.
2023 S12705 Boston Region Lynn LYNN STATION IMPROVEMENTS PHASE II 4 STBG $48,100,000 $34,500,000 $27,600,000 $6,900,000 Construction; CMAQ Total Cost = $48,100,000; Project not scored by MPO; Project funded over two fiscal years (2023-2024) through MPO's Transit Modernization Program. Flex to MBTA.
Section 1B / Earmark or Discretionary Grant Funded Projects $103,745,784 $82,996,627 $20,749,157
Bridge On-System NHS NB $27,356,262 $21,885,010 $5,471,252
2023 603722 Boston Region Lexington LEXINGTON- BRIDGE REPLACEMENT, L-10-010, ROUTE 2A (MARRETT ROAD) OVER I-95/ROUTE 128  4 HIP-BR $20,456,262 $20,456,262 $16,365,010 $4,091,252
2023 608208 Boston Region Multiple QUINCY- MILTON- BOSTON- INTERSTATE MAINTENANCE & RELATED WORK ON I-93 6 HIP-BR $38,671,350 $6,900,000 $5,520,000 $1,380,000
Earmark Discretionary $14,612,233 $11,689,786 $2,922,447
2023 606476 Boston Region Boston BOSTON- ROADWAY, CEILING, ARCH & WALL RECONSTRUCTION AND OTHER CONTROL SYSTEMS IN SUMNER TUNNEL 6 NHPP-E $136,722,750 $11,607,808 $9,286,246 $2,321,562 Construction; NHPP+HSIP+Other Federal Aid Total Cost = $136,722,750; Total MPO Contribution = $22,115,687; AC schedule over 3 years (2021-2023). MPO funding has 2-year AC schedule (2021-22).
2023 608348 Boston Region Beverly BEVERLY- RECONSTRUCTION OF BRIDGE STREET 4 HPP $12,594,932 $3,004,425 $2,403,540 $600,885 Construction; CMAQ+STBG+Earmark Total Cost = $12,594,932; MPO Evaluation Score = 66.
Bridge On-system Non-NHS NB $52,384,032 $41,907,226 $10,476,806
2023 608009 Boston Region Boxborough BOXBOROUGH- BRIDGE REPLACEMENT, B-18-002, ROUTE 111 OVER I-495 3 HIP-BR $12,763,392 $12,763,392 $10,210,714 $2,552,678
2023 608929 Boston Region Wilmington WILMINGTON- BRIDGE REPLACEMENT, W-38-003, BUTTERS ROW OVER MBTA  4 HIP-BR $10,225,199 $10,225,199 $8,180,159 $2,045,040
2023 612624 Boston Region Boston BOSTON- DECK REPLACEMENT, B-16-056, CAMBRIDGE STREET OVER I-90, INCLUDES PRESERVATION OF B-16-057, LINCOLN STREET PED OVERPASS OVER I-90 6 HIP-BR $30,045,441 $29,395,441 $23,516,353 $5,879,088
Bridge Systematic Maintenance NB $9,393,257 $7,514,606 $1,878,651
2023 608609 Boston Region Multiple BOSTON- WESTWOOD- STEEL SUPERSTRUCTURE CLEANING (FULL REMOVAL) AND PAINTING OF 2 BRIDGES: B-16-118 & W-31-006 6 HIP-BR $2,142,857 $2,142,857 $1,714,286 $428,571
2023 612662 Boston Region Boston BOSTON- BRIDGE PRESERVATION, B-16-235 (39T & 3A0), ROUTE 1A OVER CHELSEA STREET/BREMEN STREET & RAILROAD 6 HIP-BR $3,000,000 $3,000,000 $2,400,000 $600,000
2023 612663 Boston Region Boston BOSTON- BRIDGE PRESERVATION, B-16-053 (4T3), BROOKLINE AVENUE OVER I-90 & RAILROAD 6 HIP-BR $750,000 $750,000 $600,000 $150,000
2023 612664 Boston Region Boston BOSTON- BRIDGE PRESERVATION, B-16-179, AUSTIN STREET OVER I-93 AND B-16-281, I-93 UPPER/LOWER DECK 6 HIP-BR $3,500,400 $3,500,400 $2,800,320 $700,080
Section 2A / State Prioritized Reliability Projects $98,077,409 $84,536,088 $13,541,321
Bridge On-system NHS $19,011,177 $15,208,942 $3,802,235
2023 606902 Boston Region Boston BOSTON- BRIDGE RECONSTRUCTION/REHAB, B-16-181, WEST ROXBURY PARKWAY OVER MBTA 6 NHPP $6,388,740 $6,388,740 $5,110,992 $1,277,748
2023 607327 Boston Region Wilmington WILMINGTON- BRIDGE REPLACEMENT, W-38-002, ROUTE 38 (MAIN STREET) OVER THE B&M RAILROAD 4 NHPP $12,622,437 $12,622,437 $10,097,950 $2,524,487
Safety Improvements $10,863,619 $9,397,170 $1,466,449
2023 607342 Boston Region Milton MILTON- INTERSECTION & SIGNAL IMPROVEMENTS @ ROUTE 28 (RANDOLPH AVENUE) & CHICKATAWBUT ROAD 6 HSIP $7,062,751 $7,062,751 $6,356,476 $706,275
2023 609053 Boston Region Multiple CANTON- DEDHAM- NORWOOD- HIGHWAY LIGHTING IMPROVEMENTS AT I-93 & I-95/128 6 NHPP $3,800,868 $3,800,868 $3,040,694 $760,174
Interstate Pavement $53,678,861 $48,310,975 $5,367,886
2023 608208 Boston Region Multiple QUINCY- MILTON- BOSTON- INTERSTATE MAINTENANCE & RELATED WORK ON I-93 6 NHPP-I $38,671,350 $31,771,350 $28,594,215 $3,177,135
2023 610726 Boston Region Multiple MEDFORD- WINCHESTER- STONEHAM- INTERSTATE PAVEMENT PRESERVATION ON I-93 4 NHPP-I $21,907,511 $21,907,511 $19,716,760 $2,190,751
Bridge Off-system $3,454,408 $2,763,526 $690,882
2023 608255 Boston Region Stow STOW- BRIDGE REPLACEMENT, S-29-011, BOX MILL ROAD OVER ELIZABETH BROOK 3 STBG-BR-Off $3,454,408 $3,454,408 $2,763,526 $690,882
Non-Interstate Pavement $11,069,344 $8,855,475 $2,213,869
2023 608480 Boston Region Foxborough FOXBOROUGH- RESURFACING AND RELATED WORK ON ROUTE 1 5 NHPP $9,442,596 $6,894,080 $5,515,264 $1,378,816
2023 608818 Boston Region Multiple DANVERS- MIDDLETON- RESURFACING AND RELATED WORK ON ROUTE 114 4 NHPP $4,175,264 $4,175,264 $3,340,211 $835,053
Section 2B / State Prioritized Modernization Projects $23,107,606 $20,270,646 $2,836,960
Roadway Reconstruction $17,694,205 $15,398,585 $2,295,620
2023 606476 Boston Region Boston BOSTON- ROADWAY, CEILING, ARCH & WALL RECONSTRUCTION AND OTHER CONTROL SYSTEMS IN SUMNER TUNNEL 6 NHPP $136,722,750 $5,261,993 $4,209,594 $1,052,399 Construction; NHPP+HSIP+Other Federal Aid Total Cost = $136,722,750; Total MPO Contribution = $22,115,687; AC schedule over 3 years (2021-2023). MPO funding has 2-year AC schedule (2021-22).
2023 607977 Boston Region Multiple HOPKINTON- WESTBOROUGH- RECONSTRUCTION OF I-90/I-495 INTERCHANGE 3 NFP-I $300,942,837 $12,432,212 $11,188,991 $1,243,221 Other FA - SW HIP: $6,784,226 (FY 2022); HIP  Boston: $5,176,619 (FY 2022); BUILD Grant: $26,250,000 (FY 2022); HIP BR: $40,000,000 (FY 2023); $111,166,667 WT Funding
Intersection Improvements $5,413,401 $4,872,061 $541,340
2023 609254 Boston Region Lynn LYNN- INTERSECTION IMPROVEMENTS AT TWO INTERSECTIONS ON BROADWAY 4 HSIP $5,413,401 $5,413,401 $4,872,061 $541,340
Section 2C / State Prioritized Expansion Projects $15,910,117 $12,728,094 $3,182,023
Bicycle and Pedestrian $15,910,117 $12,728,094 $3,182,023
2023 610674 Boston Region Newton NEWTON- RECONSTRUCTION OF COMMONWEALTH AVENUE (ROUTE 30), FROM EAST OF AUBURN STREET TO ASH STREET 6 CMAQ $6,546,367 $6,546,367 $5,237,094 $1,309,273
2023 610919 Boston Region Multiple LYNN- NAHANT- NORTHERN STRAND EXTENSION 4 CMAQ $9,363,750 $9,363,750 $7,491,000 $1,872,750
Section 3B / Non-Federal Aid Funded $26,680,000 $0 $26,680,000
NFA $26,680,000 $0 $26,680,000
2023 607977 Boston Region Multiple HOPKINTON- WESTBOROUGH- RECONSTRUCTION OF I-90/I-495 INTERCHANGE 3 NFA $300,942,837 $26,680,000 $0 $26,680,000 Other FA - SW HIP: $6,784,226 (FY 2022); HIP  Boston: $5,176,619 (FY 2022); BUILD Grant: $26,250,000 (FY 2022); HIP BR: $40,000,000 (FY 2023); $111,166,667 WT Funding

Year MassDOT Project ID MPO Municipality MassDOT Project Description District Funding Source Adjusted TFPC Total Programmed Funds Federal Funds Non-Federal Funds Other Information
Federal Fiscal Year 2024 $362,978,298 $226,750,768 $136,227,530
Section 1A / Regionally Prioritized Projects $114,218,512 $92,174,810 $22,043,702
Bridge On-system NHS $22,725,820 $18,180,656 $4,545,164
2024 110980 Boston Region Multiple NEWTON- WESTON- BRIDGE REHABILITATION, N-12-010=W-29-005, COMMONWEALTH AVENUE (ROUTE 30) OVER THE CHARLES RIVER 6 NHPP $22,725,820 $22,725,820 $18,180,656 $4,545,164 Construction; NHPP Total Cost = $22,725,820; Project not scored by MPO.
Roadway Reconstruction $63,848,255 $51,878,604 $11,969,651
2024 603739 Boston Region Wrentham WRENTHAM- CONSTRUCTION OF ROUTE I-495/ROUTE 1A RAMPS 5 HSIP $15,587,884 $2,500,000 $2,250,000 $250,000 Construction; HSIP+STBG+TAP Total Cost =
$15,587,884; MPO Evaluation Score = 55; TAP
Proponent = MassDOT.
2024 603739 Boston Region Wrentham WRENTHAM- CONSTRUCTION OF ROUTE I-495/ROUTE 1A RAMPS 5 STBG $15,587,884 $12,587,884 $10,070,307 $2,517,577 Construction; HSIP+STBG+TAP Total Cost =
$15,587,884; MPO Evaluation Score = 55; TAP
Proponent = MassDOT.
2024 603739 Boston Region Wrentham WRENTHAM- CONSTRUCTION OF ROUTE I-495/ROUTE 1A RAMPS 5 TAP $15,587,884 $500,000 $400,000 $100,000 Construction; HSIP+STBG+TAP Total Cost =
$15,587,884; MPO Evaluation Score = 55; TAP
Proponent = MassDOT.
2024 605743 Boston Region Ipswich IPSWICH- RESURFACING & RELATED WORK ON CENTRAL & SOUTH MAIN STREETS 4 STBG $5,490,888 $4,971,338 $3,977,070 $994,268 Construction; STBG+TAP Total Cost = $5,490,888; MPO Evaluation Score = 47; TAP Proponent = Ipswich
2024 605743 Boston Region Ipswich IPSWICH- RESURFACING & RELATED WORK ON CENTRAL & SOUTH MAIN STREETS 4 TAP $5,490,888 $519,550 $415,640 $103,910 Construction; STBG+TAP Total Cost = $5,490,888; MPO Evaluation Score = 47; TAP Proponent = Ipswich
2024 606453 Boston Region Boston BOSTON- IMPROVEMENTS ON BOYLSTON STREET, FROM INTERSECTION OF BROOKLINE AVENUE & PARK DRIVE TO IPSWICH STREET 6 CMAQ $8,665,052 $5,000,000 $4,000,000 $1,000,000 Construction; CMAQ+TAP+STBG Total Cost = $8,665,052; MPO Evaluation Score = 58; TAP Proponent = Boston.
2024 606453 Boston Region Boston BOSTON- IMPROVEMENTS ON BOYLSTON STREET, FROM INTERSECTION OF BROOKLINE AVENUE & PARK DRIVE TO IPSWICH STREET 6 STBG $8,665,052 $2,852,620 $2,282,096 $570,524 Construction; CMAQ+TAP+STBG Total Cost = $8,665,052; MPO Evaluation Score = 58; TAP Proponent = Boston.
2024 606453 Boston Region Boston BOSTON- IMPROVEMENTS ON BOYLSTON STREET, FROM INTERSECTION OF BROOKLINE AVENUE & PARK DRIVE TO IPSWICH STREET 6 TAP $8,665,052 $812,432 $649,946 $162,486 Construction; CMAQ+TAP+STBG Total Cost = $8,665,052; MPO Evaluation Score = 58; TAP Proponent = Boston.
2024 608007 Boston Region Multiple COHASSET- SCITUATE- CORRIDOR IMPROVEMENTS AND RELATED WORK ON JUSTICE CUSHING HIGHWAY (ROUTE 3A), FROM BEECHWOOD STREET TO HENRY TURNER BAILEY ROAD 5 HSIP $12,509,786 $1,500,000 $1,350,000 $150,000 Construction; HSIP+STBG+TAP Total Cost =
$12,509,786; MPO Evaluation Score = 37; TAP
Proponent = MassDOT.
2024 608007 Boston Region Multiple COHASSET- SCITUATE- CORRIDOR IMPROVEMENTS AND RELATED WORK ON JUSTICE CUSHING HIGHWAY (ROUTE 3A), FROM BEECHWOOD STREET TO HENRY TURNER BAILEY ROAD 5 STBG $12,509,786 $10,869,554 $8,695,643 $2,173,911 Construction; HSIP+STBG+TAP Total Cost =
$12,509,786; MPO Evaluation Score = 37; TAP
Proponent = MassDOT.
2024 608007 Boston Region Multiple COHASSET- SCITUATE- CORRIDOR IMPROVEMENTS AND RELATED WORK ON JUSTICE CUSHING HIGHWAY (ROUTE 3A), FROM BEECHWOOD STREET TO HENRY TURNER BAILEY ROAD 5 TAP $12,509,786 $140,232 $112,186 $28,046 Construction; HSIP+STBG+TAP Total Cost =
$12,509,786; MPO Evaluation Score = 37; TAP
Proponent = MassDOT.
2024 609054 Boston Region Littleton LITTLETON- RECONSTRUCTION OF FOSTER STREET 3 CMAQ $3,992,645 $1,000,000 $800,000 $200,000 Construction; CMAQ+TAP+STBG Total Cost = $3,992,645; MPO Evaluation Score = 38; TAP
Proponent = Littleton.
2024 609054 Boston Region Littleton LITTLETON- RECONSTRUCTION OF FOSTER STREET 3 STBG $3,992,645 $2,492,645 $1,994,116 $498,529 Construction; CMAQ+TAP+STBG Total Cost = $3,992,645; MPO Evaluation Score = 38; TAP
Proponent = Littleton.
2024 609054 Boston Region Littleton LITTLETON- RECONSTRUCTION OF FOSTER STREET 3 TAP $3,992,645 $500,000 $400,000 $100,000 Construction; CMAQ+TAP+STBG Total Cost = $3,992,645; MPO Evaluation Score = 38; TAP
Proponent = Littleton.
2024 609252 Boston Region Lynn LYNN- REHABILITATION OF ESSEX STREET 4 CMAQ $17,602,000 $9,000,000 $7,200,000 $1,800,000 Construction; CMAQ+HSIP+STBG Total Cost = $17,602,000; MPO Evaluation Score = 66.
2024 609252 Boston Region Lynn LYNN- REHABILITATION OF ESSEX STREET 4 HSIP $17,602,000 $4,000,000 $3,600,000 $400,000 Construction; CMAQ+HSIP+STBG Total Cost = $17,602,000; MPO Evaluation Score = 66.
2024 609252 Boston Region Lynn LYNN- REHABILITATION OF ESSEX STREET 4 STBG $17,602,000 $4,602,000 $3,681,600 $920,400 Construction; CMAQ+HSIP+STBG Total Cost = $17,602,000; MPO Evaluation Score = 66.
Intersection Improvements $1,222,315 $977,852 $244,463
2024 608436 Boston Region   ASHLAND- REHABILITATION AND RAIL CROSSING IMPROVEMENTS ON CHERRY STREET 3 STBG $1,222,315 $1,222,315 $977,852 $244,463 Construction; STBG Total Cost = $1,222,315; MPO
Evaluation Score = 38.
Bicycle and Pedestrian $3,922,122 $3,137,698 $784,424
2024 609211 Boston Region Peabody PEABODY- INDEPENDENCE GREENWAY EXTENSION 4 CMAQ $3,922,122 $2,000,000 $1,600,000 $400,000 Construction; CMAQ+TAP Total Cost = $3,922,122;
MPO Evaluation Score = 34; TAP Proponent = Peabody.
2024 609211 Boston Region Peabody PEABODY- INDEPENDENCE GREENWAY EXTENSION 4 TAP $3,922,122 $1,922,122 $1,537,698 $384,424 Construction; CMAQ+TAP Total Cost = $3,922,122;
MPO Evaluation Score = 34; TAP Proponent = Peabody.
Transit Grant Program $1,655,156 $1,324,125 $331,031
2024 S12114 Boston Region Canton ROYALL STREET SHUTTLE   CMAQ $534,820 $148,542 $118,834 $29,708 Operations; CMAQ Total Cost = $534,820; MPO Evaluation Score = 51; Project funded through MPO's Community Connections Program.
2024 S12124 Boston Region Multiple COMMUNITY CONNECTIONS PROGRAM   CMAQ $6,716,799 $641,495 $513,196 $128,299 Planning, Design, or Construction; Set Aside for LRTP Community Connections Program.
2024 S12694 Boston Region Newton NEWMO MICROTRANSIT SERVICE EXPANSION 6 CMAQ $890,574 $268,246 $214,597 $53,649 Operations; CMAQ Total Cost = $890,574; MPO Evaluation Score = 87; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program.
2024 S12697 Boston Region Watertown PLEASANT STREET SHUTTLE SERVICE EXPANSION 6 CMAQ $1,002,198 $335,434 $268,347 $67,087 Operations; CMAQ Total Cost = $1,002,198; MPO Evaluation Score = 78; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program.
2024 S12699 Boston Region Stoneham STONEHAM SHUTTLE SERVICE 4 CMAQ $796,817 $261,439 $209,151 $52,288 Operations; CMAQ Total Cost = $796,817; MPO Evaluation Score = 72; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program.
Flex to FTA $20,844,844 $16,675,875 $4,168,969
2024 S12700 Boston Region Multiple CATA ON DEMAND MICROTRANSIT SERVICE EXPANSION 4 CMAQ $813,291 $265,065 $212,052 $53,013 Operations; CMAQ Total Cost = $813,291; MPO Evaluation Score = 61.75; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program. Flex to CATA.
2024 S12701 Boston Region Multiple MWRTA CATCHCONNECT MICROTRANSIT SERVICE EXPANSION 3 CMAQ $450,163 $149,425 $119,540 $29,885 Operations; CMAQ Total Cost = $450,163; MPO Evaluation Score = 59; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program. Flex to MWRTA.
2024 S12703 Boston Region Multiple MONTACHUSETT RTA MICROTRANSIT SERVICE 3 CMAQ $1,316,061 $430,354 $344,283 $86,071 Operations; CMAQ Total Cost = $1,316,061; MPO Evaluation Score = 57; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program. Flex to MART.
2024 S12705 Boston Region Lynn LYNN STATION IMPROVEMENTS PHASE II 4 STBG $48,100,000 $13,600,000 $10,880,000 $2,720,000 Construction; CMAQ Total Cost = $48,100,000; Project not scored by MPO; Project funded over two fiscal years (2023-2024) through MPO's Transit Modernization Program. Flex to MBTA.
2024 S12706 Boston Region Boston FOREST HILLS IMPROVEMENT PROJECT 6 STBG $6,400,000 $6,400,000 $5,120,000 $1,280,000 Construction; CMAQ Total Cost = $6,400,000; Project not scored by the MPO; Funded through the MPO's Transit Modernization Program. Flex to MBTA.
Section 1B / Earmark or Discretionary Grant Funded Projects $58,297,800 $56,499,219 $1,798,581
Earmark Discretionary $50,011,476 $49,870,160 $141,316
2024 605313 Boston Region Natick NATICK- BRIDGE REPLACEMENT, N-03-020, ROUTE 27 (NORTH MAIN STREET) OVER ROUTE 9 (WORCESTER STREET) AND INTERCHANGE IMPROVEMENTS 3 CRRSAA $46,901,244 $46,901,244 $46,901,244 $0
2024 608562 Boston Region Somerville SOMERVILLE- SIGNAL AND INTERSECTION IMPROVEMENT ON I-93 AT MYSTIC AVENUE AND MCGRATH HIGHWAY (TOP 200 CRASH LOCATION) 4 HPP $6,122,559 $706,581 $565,265 $141,316
2024 608955 Boston Region Milton MILTON- INTERSECTION IMPROVEMENTS SQUANTUM STREET @ ADAMS STREET 6 CRRSAA $2,403,651 $2,403,651 $2,403,651 $0
Bridge On-system Non-NHS NB $8,286,324 $6,629,059 $1,657,265
2024 608197 Boston Region Boston BOSTON- BRIDGE REHABILITATION, B-16-107, CANTERBURY STREET OVER AMTRAK RAILROAD 6 HIP-BR $4,504,926 $4,504,926 $3,603,941 $900,985
2024 608522 Boston Region Middleton MIDDLETON- BRIDGE REPLACEMENT, M-20-003, ROUTE 62 (MAPLE STREET) OVER IPSWICH RIVER 4 HIP-BR $3,781,398 $3,781,398 $3,025,118 $756,280
Section 2A / State Prioritized Reliability Projects $60,864,298 $42,558,710 $18,305,588
Bridge On-system NHS $5,279,051 $4,223,241 $1,055,810
2024 610782 Boston Region Multiple DANVERS-MIDDLETON - BRIDGE REPLACEMENT, D-03-009=M-20-005, ANDOVER STREET (SR 114) OVER IPSWICH RIVER 4 NHPP $5,279,051 $5,279,051 $4,223,241 $1,055,810
Bridge On-system Non-NHS $11,732,339 $0 $11,732,339
2024 606901 Boston Region Boston BOSTON- BRIDGE REPLACEMENT, B-16-109, RIVER STREET BRIDGE OVER MBTA/AMTRAK 6 NGBP $11,732,339 $11,732,339 $0 $11,732,339
Interstate Pavement $29,031,429 $26,128,286 $2,903,143
2024 612034 Boston Region Multiple BURLINGTON- WOBURN- INTERSTATE MAINTENANCE AND RELATED WORK ON I-95 4 NHPP-I $12,947,687 $12,948,687 $11,653,818 $1,294,869
2024 612048 Boston Region Waltham WALTHAM- INTERSTATE MAINTENANCE AND RELATED WORK ON I-95 4 NHPP-I $16,680,742 $16,082,742 $14,474,468 $1,608,274
Non-Interstate Pavement $6,000,522 $4,800,418 $1,200,104
2024 608498 Boston Region Multiple QUINCY- WEYMOUTH- BRAINTREE- RESURFACING AND RELATED WORK ON ROUTE 53 6 NHPP $6,000,522 $6,000,522 $4,800,418 $1,200,104
Bridge Off-system $5,320,957 $4,256,766 $1,064,191
2024 609438 Boston Region Canton CANTON- BRIDGE REPLACEMENT, C-02-042, REVERE COURT OVER WEST BRANCH OF  THE NEPONSET RIVER 6 STBG-BR-Off $2,185,168 $2,185,168 $1,748,134 $437,034
2024 609467 Boston Region Multiple HAMILTON- IPSWICH- SUPERSTRUCTURE REPLACEMENT, H-03-002=I-01-006, WINTHROP STREET OVER IPSWICH RIVER 4 STBG-BR-Off $3,135,789 $3,135,789 $2,508,631 $627,158
Safety Improvements $3,500,000 $3,150,000 $350,000
2024 S12640 Boston Region   FRAMINGHAM-HIGH RISK AT-GRADE RAILROAD CROSSING COUNTERMEASURES ON ROUTE 126   HSIP $3,500,000 $3,500,000 $3,150,000 $350,000
Section 2B / State Prioritized Modernization Projects $37,059,238 $31,777,141 $5,282,097
Roadway Reconstruction $28,563,030 $24,130,554 $4,432,477
2024 607977 Boston Region Multiple HOPKINTON- WESTBOROUGH- RECONSTRUCTION OF I-90/I-495 INTERCHANGE 3 NFP-I $300,942,837 $12,801,295 $11,521,166 $1,280,130 Other FA - SW HIP: $6,784,226 (FY 2022); HIP  Boston: $5,176,619 (FY 2022); BUILD Grant: $26,250,000 (FY 2022); HIP BR: $40,000,000 (FY 2023); $111,166,667 WT Funding
2024 609516 Boston Region Burlington BURLINGTON- IMPROVEMENTS AT I-95 (ROUTE 128)/ROUTE 3 INTERCHANGE 4 NHPP $3,121,560 $3,121,560 $2,497,248 $624,312
2024 609530 Boston Region Medway MEDWAY- HOLLISTON STREET AND CASSIDY LANE IMPROVEMENTS (SRTS) 3 TAP $2,807,468 $2,807,468 $2,245,974 $561,494
2024 609531 Boston Region Arlington ARLINGTON- STRATTON SCHOOL IMPROVEMENTS (SRTS) 4 TAP $1,302,209 $1,302,209 $1,041,767 $260,442
2024 610537 Boston Region Boston BOSTON- ELLIS ELEMENTARY TRAFFIC CALMING (SRTS) 6 TAP $2,361,218 $2,361,218 $1,888,974 $472,244
2024 610541 Boston Region Canton CANTON- INTERIM INTERCHANGE IMPROVEMENTS AT I-95/ROUTE 128/I-93  6 NHPP $6,169,280 $6,169,280 $4,935,424 $1,233,856
Intersection Improvements $8,496,208 $7,646,587 $849,621
2024 608562 Boston Region Somerville SOMERVILLE- SIGNAL AND INTERSECTION IMPROVEMENT ON I-93 AT MYSTIC AVENUE AND MCGRATH HIGHWAY (TOP 200 CRASH LOCATION) 4 HSIP $6,122,559 $5,415,978 $4,874,380 $541,598
2024 608564 Boston Region Watertown WATERTOWN- INTERSECTION IMPROVEMENTS AT ROUTE 16 AND GALEN STREET 6 HSIP $3,080,230 $3,080,230 $2,772,207 $308,023
Section 2C / State Prioritized Expansion Projects $4,676,111 $3,740,889 $935,222
Bicycle and Pedestrian $4,676,111 $3,740,889 $935,222
2024 611982 Boston Region Medford MEDFORD- SHARED USE PATH CONNECTION AT THE ROUTE 28/WELLINGTON UNDERPASS 4 CMAQ $4,676,111 $4,676,111 $3,740,889 $935,222
Section 3B / Non-Federal Aid Funded $87,862,339 $0 $87,862,339
Bridge On-system NHS $49,450,000 $0 $49,450,000
2024 606496 Boston Region Boston BOSTON- BRIDGE REHABILITATION, B-16-052, BOWKER OVERPASS OVER MASS PIKE, MBTA/CSX, & IPSWICH STREET AND RAMPS (BINS 4FD, 4FG, 4FE, 4FF & 4FJ) 6 NGBP $51,428,000 $49,450,000 $0 $49,450,000
Bridge On-system Non-NHS $11,732,339 $0 $11,732,339
2024 606901 Boston Region Boston BOSTON- BRIDGE REPLACEMENT, B-16-109, RIVER STREET BRIDGE OVER MBTA/AMTRAK 6 NGBP $11,732,339 $11,732,339 $0 $11,732,339
NFA $26,680,000 $0 $26,680,000
2024 607977 Boston Region Multiple HOPKINTON- WESTBOROUGH- RECONSTRUCTION OF I-90/I-495 INTERCHANGE 3 NFA $300,942,837 $26,680,000 $0 $26,680,000 Other FA - SW HIP: $6,784,226 (FY 2022); HIP  Boston: $5,176,619 (FY 2022); BUILD Grant: $26,250,000 (FY 2022); HIP BR: $40,000,000 (FY 2023); $111,166,667 WT Funding

Year MassDOT Project ID MPO Municipality MassDOT Project Description District Funding Source Adjusted TFPC Total Programmed Funds Federal Funds Non-Federal Funds Other Information
Federal Fiscal Year 2025 $469,296,950 $213,649,526 $255,647,424
Section 1A / Regionally Prioritized Projects $124,612,902 $100,253,494 $24,359,408
Roadway Reconstruction $98,723,502 $79,478,802 $19,244,700
2025 605168 Boston Region Hingham HINGHAM- IMPROVEMENTS ON ROUTE 3A FROM OTIS STREET/COLE ROAD  INCLUDING SUMMER STREET AND ROTARY; ROCKLAND STREET TO GEORGE WASHINGTON BOULEVARD.   5 STBG $15,596,550 $14,096,550 $11,277,240 $2,819,310 Construction; TAP+STBG Total Cost = $15,596,549; MPO Evaluation Score = 55; TAP Proponent = Hingham
2025 605168 Boston Region Hingham HINGHAM- IMPROVEMENTS ON ROUTE 3A FROM OTIS STREET/COLE ROAD  INCLUDING SUMMER STREET AND ROTARY; ROCKLAND STREET TO GEORGE WASHINGTON BOULEVARD.   5 TAP $15,596,550 $1,500,000 $1,200,000 $300,000 Construction; TAP+STBG Total Cost = $15,596,549; MPO Evaluation Score = 55; TAP Proponent = Hingham
2025 606226 Boston Region Boston BOSTON- RECONSTRUCTION OF RUTHERFORD AVENUE, FROM CITY SQUARE TO SULLIVAN SQUARE 6 NHPP $190,696,612 $12,000,000 $9,600,000 $2,400,000 Construction; NHPP+STBG+TAP Total Cost = $190,696,612; AC schedule over 5 years (2025-2029); Total funding in this TIP = $99,783,959; $25,000,000 in anticipated funding provided by City of Boston; MPO Evaluation Score = 59; TAP Proponent = Boston.
2025 606226 Boston Region Boston BOSTON- RECONSTRUCTION OF RUTHERFORD AVENUE, FROM CITY SQUARE TO SULLIVAN SQUARE 6 STBG $190,696,612 $18,783,959 $15,027,167 $3,756,792 Construction; NHPP+STBG+TAP Total Cost = $190,696,612; AC schedule over 5 years (2025-2029); Total funding in this TIP = $99,783,959; $25,000,000 in anticipated funding provided by City of Boston; MPO Evaluation Score = 59; TAP Proponent = Boston.
2025 606226 Boston Region Boston BOSTON- RECONSTRUCTION OF RUTHERFORD AVENUE, FROM CITY SQUARE TO SULLIVAN SQUARE 6 TAP $190,696,612 $2,000,000 $1,600,000 $400,000 Construction; NHPP+STBG+TAP Total Cost = $190,696,612; AC schedule over 5 years (2025-2029); Total funding in this TIP = $99,783,959; $25,000,000 in anticipated funding provided by City of Boston; MPO Evaluation Score = 59; TAP Proponent = Boston.
2025 608051 Boston Region Wilmington WILMINGTON- RECONSTRUCTION ON ROUTE 38 (MAIN STREET), FROM ROUTE 62 TO THE WOBURN C.L. 4 CMAQ $24,644,177 $2,000,000 $1,600,000 $400,000 Construction; CMAQ+HSIP+STBG Total Cost = $24,644,177; MPO Evaluation Score = 59
2025 608051 Boston Region Wilmington WILMINGTON- RECONSTRUCTION ON ROUTE 38 (MAIN STREET), FROM ROUTE 62 TO THE WOBURN C.L. 4 HSIP $24,644,177 $1,000,000 $900,000 $100,000 Construction; CMAQ+HSIP+STBG Total Cost = $24,644,177; MPO Evaluation Score = 59
2025 608051 Boston Region Wilmington WILMINGTON- RECONSTRUCTION ON ROUTE 38 (MAIN STREET), FROM ROUTE 62 TO THE WOBURN C.L. 4 STBG $24,644,177 $21,644,177 $17,315,342 $4,328,835 Construction; CMAQ+HSIP+STBG Total Cost = $24,644,177; MPO Evaluation Score = 59
2025 609257 Boston Region Everett EVERETT- RECONSTRUCTION OF BEACHAM STREET 4 HSIP $10,168,416 $1,000,000 $900,000 $100,000 Construction; HSIP+TAP+STBG Total Cost =
$10,168,416; MPO Evaluation Score = 54; TAP
Proponent = Everett.
2025 609257 Boston Region Everett EVERETT- RECONSTRUCTION OF BEACHAM STREET 4 STBG $10,168,416 $7,668,416 $6,134,733 $1,533,683 Construction; HSIP+TAP+STBG Total Cost =
$10,168,416; MPO Evaluation Score = 54; TAP
Proponent = Everett.
2025 609257 Boston Region Everett EVERETT- RECONSTRUCTION OF BEACHAM STREET 4 TAP $10,168,416 $1,500,000 $1,200,000 $300,000 Construction; HSIP+TAP+STBG Total Cost =
$10,168,416; MPO Evaluation Score = 54; TAP
Proponent = Everett.
2025 610662 Boston Region Woburn WOBURN- ROADWAY AND INTERSECTION IMPROVEMENTS AT WOBURN COMMON, ROUTE 38 (MAIN STREET), WINN STREET, PLEASANT STREET AND MONTVALE AVENUE 4 HSIP $15,530,400 $3,000,000 $2,700,000 $300,000 Construction; HSIP+STBG Total Cost = $15,530,400; MPO Evaluation Score = 75.
2025 610662 Boston Region Woburn WOBURN- ROADWAY AND INTERSECTION IMPROVEMENTS AT WOBURN COMMON, ROUTE 38 (MAIN STREET), WINN STREET, PLEASANT STREET AND MONTVALE AVENUE 4 STBG $15,530,400 $12,530,400 $10,024,320 $2,506,080 Construction; HSIP+STBG Total Cost = $15,530,400; MPO Evaluation Score = 75.
Intersection Improvements $10,555,200 $8,507,332 $2,047,868
2025 605857 Boston Region Norwood NORWOOD- INTERSECTION IMPROVEMENTS @ ROUTE 1 & UNIVERSITY AVENUE/EVERETT STREET  5 CMAQ $24,837,870 $3,000,000 $2,400,000 $600,000 Construction; HSIP+CMAQ+STBG+NHPP Total Cost = $24,837,870; 2-year AC schedule (2025-26); MPO Evaluation Score = 55.
2025 605857 Boston Region Norwood NORWOOD- INTERSECTION IMPROVEMENTS @ ROUTE 1 & UNIVERSITY AVENUE/EVERETT STREET  5 HSIP $24,837,870 $631,724 $568,552 $63,172 Construction; HSIP+CMAQ+STBG+NHPP Total Cost = $24,837,870; 2-year AC schedule (2025-26); MPO Evaluation Score = 55.
2025 605857 Boston Region Norwood NORWOOD- INTERSECTION IMPROVEMENTS @ ROUTE 1 & UNIVERSITY AVENUE/EVERETT STREET  5 NHPP $24,837,870 $2,873,029 $2,298,423 $574,606 Construction; HSIP+CMAQ+STBG+NHPP Total Cost = $24,837,870; 2-year AC schedule (2025-26); MPO Evaluation Score = 55.
2025 605857 Boston Region Norwood NORWOOD- INTERSECTION IMPROVEMENTS @ ROUTE 1 & UNIVERSITY AVENUE/EVERETT STREET  5 STBG $24,837,870 $2,495,247 $1,996,198 $499,049 Construction; HSIP+CMAQ+STBG+NHPP Total Cost = $24,837,870; 2-year AC schedule (2025-26); MPO Evaluation Score = 55.
2025 608067 Boston Region Woburn WOBURN- INTERSECTION RECONSTRUCTION AT ROUTE 3 (CAMBRIDGE ROAD) & BEDFORD ROAD AND SOUTH BEDFORD STREET 4 CMAQ $1,555,200 $1,555,200 $1,244,160 $311,040 Construction; CMAQ Total Cost = $1,555,200;
MPO Evaluation Score = 52.
Bicycle and Pedestrian $6,334,200 $5,067,360 $1,266,840
2025 610544 Boston Region Peabody PEABODY- MULTI-USE PATH CONSTRUCTION OF INDEPENDENCE GREENWAY AT I-95 AND ROUTE 1 4 CMAQ $6,334,200 $4,000,000 $3,200,000 $800,000 Construction; CMAQ+TAP Total Cost = $6,334,200;
MPO Evaluation Score = 53; TAP Proponent = Peabody.
2025 610544 Boston Region Peabody PEABODY- MULTI-USE PATH CONSTRUCTION OF INDEPENDENCE GREENWAY AT I-95 AND ROUTE 1 4 TAP $6,334,200 $2,334,200 $1,867,360 $466,840 Construction; CMAQ+TAP Total Cost = $6,334,200;
MPO Evaluation Score = 53; TAP Proponent = Peabody.
Flex to FTA $7,280,905 $5,824,724 $1,456,181
2025 S12113 Boston Region Multiple TRANSIT MODERNIZATION PROGRAM   CMAQ $19,500,000 $6,500,000 $5,200,000 $1,300,000 Construction; Flex to FTA; Set aside for LRTP Transit Modernization Program.
2025 S12700 Boston Region Multiple CATA ON DEMAND MICROTRANSIT SERVICE EXPANSION 4 CMAQ $813,291 $214,776 $171,821 $42,955 Operations; CMAQ Total Cost = $813,291; MPO Evaluation Score = 61.75; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program. Flex to CATA.
2025 S12701 Boston Region Multiple MWRTA CATCHCONNECT MICROTRANSIT SERVICE EXPANSION 3 CMAQ $450,163 $159,488 $127,590 $31,898 Operations; CMAQ Total Cost = $450,163; MPO Evaluation Score = 59; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program. Flex to MWRTA.
2025 S12703 Boston Region Multiple MONTACHUSETT RTA MICROTRANSIT SERVICE 3 CMAQ $1,316,061 $406,641 $325,313 $81,328 Operations; CMAQ Total Cost = $1,316,061; MPO Evaluation Score = 57; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program. Flex to MART.
Transit Grant Program $1,719,095 $1,375,276 $343,819
2025 S12124 Boston Region Multiple COMMUNITY CONNECTIONS PROGRAM   CMAQ $6,716,799 $1,075,304 $860,243 $215,061 Planning, Design, or Construction; Set Aside for LRTP Community Connections Program.
2025 S12694 Boston Region Newton NEWMO MICROTRANSIT SERVICE EXPANSION 6 CMAQ $890,574 $209,663 $167,730 $41,933 Operations; CMAQ Total Cost = $890,574; MPO Evaluation Score = 87; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program.
2025 S12697 Boston Region Watertown PLEASANT STREET SHUTTLE SERVICE EXPANSION 6 CMAQ $1,002,198 $228,939 $183,151 $45,788 Operations; CMAQ Total Cost = $1,002,198; MPO Evaluation Score = 78; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program.
2025 S12699 Boston Region Stoneham STONEHAM SHUTTLE SERVICE 4 CMAQ $796,817 $205,189 $164,151 $41,038 Operations; CMAQ Total Cost = $796,817; MPO Evaluation Score = 72; Project funded over three fiscal years (2023-2025) through MPO's Community Connections Program.
Section 1B / Earmark or Discretionary Grant Funded Projects $30,000,000 $24,000,000 $6,000,000
Earmark Discretionary $30,000,000 $24,000,000 $6,000,000
2025 607977 Boston Region Multiple HOPKINTON- WESTBOROUGH- RECONSTRUCTION OF I-90/I-495 INTERCHANGE 3 HIP-BR $300,942,837 $30,000,000 $24,000,000 $6,000,000 Other FA - SW HIP: $6,784,226 (FY 2022); HIP  Boston: $5,176,619 (FY 2022); BUILD Grant: $26,250,000 (FY 2022); HIP BR: $40,000,000 (FY 2023); $111,166,667 WT Funding
Section 2A / State Prioritized Reliability Projects $141,723,502 $40,998,765 $100,724,737
Bridge On-system NHS $77,249,316 $23,500,972 $53,748,344
2025 604564 Boston Region Maynard MAYNARD- BRIDGE REPLACEMENT, M-10-004, ROUTE 62 (MAIN STREET) OVER THE ASSABET RIVER 3 NGBP $1,848,258 $1,520,953 $0 $1,520,953
2025 607684 Boston Region Braintree BRAINTREE- BRIDGE REPLACEMENT, B-21-017, WASHINGTON STREET (ST 37) OVER MBTA/CSX RAILROAD 6 NGBP $7,681,489 $7,681,489 $0 $7,681,489
2025 608703 Boston Region Wilmington WILMINGTON- BRIDGE REPLACEMENT, W-38-029 (2KV), ST 129 LOWELL STREET OVER I 93 4 NHPP $15,951,816 $15,951,816 $12,761,453 $3,190,363
2025 610776 Boston Region Cambridge CAMBRIDGE- SUPERSTRUCTURE REPLACEMENT, C-01-031, US ROUTE 3/ROUTE 16/ROUTE 2 OVER MBTA REDLINE 6 NHPP $13,424,399 $13,424,399 $10,739,519 $2,684,880
2025 612028 Boston Region Stoneham STONEHAM- DECK REPLACEMENT & SUPERSTRUCTURE REPAIRS, S-27-006 (2L2), (ST 28) FELLSWAY WEST OVER I-93 4 NGBP $3,240,000 $3,240,000 $0 $3,240,000
2025 612182 Boston Region Newton NEWTON- BRIDGE REPLACEMENT, N-12-040, BOYLSTON STREET OVER GREEN LINE D 6 NGBP $15,186,854 $15,186,854 $0 $15,186,854
2025 612184 Boston Region Revere REVERE- BRIDGE REPLACEMENT, R-05-015, REVERE BEACH PARKWAY OVER BROADWAY 4 NGBP $20,243,805 $20,243,805 $0 $20,243,805
Bridge On-system Non-NHS $43,421,682 $0 $43,421,682
2025 608952 Boston Region Chelsea CHELSEA- BRIDGE SUPERSTRUCTURE REPLACMENT C-09-013, WASHINGTON AVENUE, CARTER STREET & COUNTY ROAD/ROUTE 1 6 NGBP $10,584,000 $10,584,000 $0 $10,584,000
2025 612173 Boston Region Bellingham BELLINGHAM- BRIDGE REPLACEMENT, B-06-022, MAPLE STREET OVER I-495 3 NGBP $14,249,535 $14,249,535 $0 $14,249,535
2025 612178 Boston Region Natick NATICK- BRIDGE REPLACEMENT, N-03-010, SPEEN STREET OVER RR MBTA/CSX 3 NGBP $6,711,629 $6,711,629 $0 $6,711,629
2025 612196 Boston Region Braintree BRAINTREE- BRIDGE REPLACEMENT, B-21-067, JW MAHER HIGHWAY OVER MONATIQUOT RIVER 6 NGBP $11,876,518 $11,876,518 $0 $11,876,518
Non-Interstate Pavement $14,494,606 $11,595,685 $2,898,921
2025 609399 Boston Region Randolph RANDOLPH- RESURFACING AND RELATED WORK ON ROUTE 28 6 NHPP $6,930,814 $6,930,814 $5,544,651 $1,386,163
2025 610722 Boston Region Multiple ACTON- BOXBOROUGH- LITTLETON- PAVEMENT PRESERVATION ROUTE 2 3 NHPP $7,563,792 $7,563,792 $6,051,034 $1,512,758
Safety Improvements $6,557,898 $5,902,108 $655,790
2025 609532 Boston Region Chelsea CHELSEA- TARGETED SAFETY IMPROVEMENTS AND RELATED WORK ON BROADWAY, FROM WILLIAMS STREET TO CITY HALL AVENUE 6 HSIP $6,557,898 $6,557,898 $5,902,108 $655,790
Section 2B / State Prioritized Modernization Projects $46,307,763 $41,454,867 $4,852,896
Roadway Reconstruction $46,307,763 $41,454,867 $4,852,896
2025 607977 Boston Region Multiple HOPKINTON- WESTBOROUGH- RECONSTRUCTION OF I-90/I-495 INTERCHANGE 3 NHPP-I $300,942,837 $15,000,000 $13,500,000 $1,500,000 Other FA - SW HIP: $6,784,226 (FY 2022); HIP  Boston: $5,176,619 (FY 2022); BUILD Grant: $26,250,000 (FY 2022); HIP BR: $40,000,000 (FY 2023); $111,166,667 WT Funding
2025 607977 Boston Region Multiple HOPKINTON- WESTBOROUGH- RECONSTRUCTION OF I-90/I-495 INTERCHANGE 3 NFP-I $300,942,837 $29,086,566 $26,177,909 $2,908,657 Other FA - SW HIP: $6,784,226 (FY 2022); HIP  Boston: $5,176,619 (FY 2022); BUILD Grant: $26,250,000 (FY 2022); HIP BR: $40,000,000 (FY 2023); $111,166,667 WT Funding
2025 611997 Boston Region Newton NEWTON- HORACE MANN ELEMENTARY SCHOOL IMPROVEMENTS (SRTS) 6 TAP $861,962 $861,962 $689,570 $172,392
2025 612001 Boston Region Medford MEDFORD- MILTON FULLER ROBERTS ELEMENTARY SCHOOL (SRTS) 4 TAP $1,020,854 $1,020,854 $816,683 $204,171
2025 612100 Boston Region Revere REVERE- IMPROVEMENTS AT BEACHMONT VETERANS ELEMENTARY (SRTS) 4 TAP $338,381 $338,381 $270,705 $67,676
Section 2C / State Prioritized Expansion Projects $8,678,000 $6,942,400 $1,735,600
Bicycle and Pedestrian $8,678,000 $6,942,400 $1,735,600
2025 610680 Boston Region Natick NATICK- LAKE COCHITUATE PATH 3 CMAQ $3,582,995 $3,582,995 $2,866,396 $716,599
2025 612523 Boston Region Revere REVERE- STATE ROAD BEACHMONT CONNECTOR 4 CMAQ $5,095,005 $5,095,005 $4,076,004 $1,019,001
Section 3B / Non-Federal Aid Funded $117,974,783 $0 $117,974,783
Bridge On-system NHS $47,873,101 $0 $47,873,101
2025 604564 Boston Region Maynard MAYNARD- BRIDGE REPLACEMENT, M-10-004, ROUTE 62 (MAIN STREET) OVER THE ASSABET RIVER 3 NGBP $1,848,258 $1,520,953 $0 $1,520,953
2025 607684 Boston Region Braintree BRAINTREE- BRIDGE REPLACEMENT, B-21-017, WASHINGTON STREET (ST 37) OVER MBTA/CSX RAILROAD 6 NGBP $7,681,489 $7,681,489 $0 $7,681,489
2025 612028 Boston Region Stoneham STONEHAM- DECK REPLACEMENT & SUPERSTRUCTURE REPAIRS, S-27-006 (2L2), (ST 28) FELLSWAY WEST OVER I-93 4 NGBP $3,240,000 $3,240,000 $0 $3,240,000
2025 612182 Boston Region Newton NEWTON- BRIDGE REPLACEMENT, N-12-040, BOYLSTON STREET OVER GREEN LINE D 6 NGBP $15,186,854 $15,186,854 $0 $15,186,854
2025 612184 Boston Region Revere REVERE- BRIDGE REPLACEMENT, R-05-015, REVERE BEACH PARKWAY OVER BROADWAY 4 NGBP $20,243,805 $20,243,805 $0 $20,243,805
NFA $26,680,000 $0 $26,680,000
2025 607977 Boston Region Multiple HOPKINTON- WESTBOROUGH- RECONSTRUCTION OF I-90/I-495 INTERCHANGE 3 NFA $300,942,837 $26,680,000 $0 $26,680,000 Other FA - SW HIP: $6,784,226 (FY 2022); HIP  Boston: $5,176,619 (FY 2022); BUILD Grant: $26,250,000 (FY 2022); HIP BR: $40,000,000 (FY 2023); $111,166,667 WT Funding
Bridge On-system Non-NHS $43,421,682 $0 $43,421,682
2025 608952 Boston Region Chelsea CHELSEA- BRIDGE SUPERSTRUCTURE REPLACMENT C-09-013, WASHINGTON AVENUE, CARTER STREET & COUNTY ROAD/ROUTE 1 6 NGBP $10,584,000 $10,584,000 $0 $10,584,000
2025 612173 Boston Region Bellingham BELLINGHAM- BRIDGE REPLACEMENT, B-06-022, MAPLE STREET OVER I-495 3 NGBP $14,249,535 $14,249,535 $0 $14,249,535
2025 612178 Boston Region Natick NATICK- BRIDGE REPLACEMENT, N-03-010, SPEEN STREET OVER RR MBTA/CSX 3 NGBP $6,711,629 $6,711,629 $0 $6,711,629
2025 612196 Boston Region Braintree BRAINTREE- BRIDGE REPLACEMENT, B-21-067, JW MAHER HIGHWAY OVER MONATIQUOT RIVER 6 NGBP $11,876,518 $11,876,518 $0 $11,876,518

Year MassDOT Project ID MPO Municipality MassDOT Project Description District Funding Source Adjusted TFPC Total Programmed Funds Federal Funds Non-Federal Funds Other Information
Federal Fiscal Year 2026 $500,400,443 $386,100,866 $114,299,577
Section 1A / Regionally Prioritized Projects $123,179,070 $98,911,389 $24,267,681
Intersection Improvements $18,519,200 $15,083,493 $3,435,707
2026 605857 Boston Region Norwood NORWOOD- INTERSECTION IMPROVEMENTS @ ROUTE 1 & UNIVERSITY AVENUE/EVERETT STREET  5 STBG $24,837,870 $15,837,870 $12,670,296 $3,167,574 Construction; HSIP+CMAQ+STBG+NHPP Total Cost = $24,837,870; 2-year AC schedule (2025-26); MPO Evaluation Score = 55.
2026 608940 Boston Region Weston WESTON- INTERSECTION IMPROVEMENTS BOSTON POST ROAD (ROUTE 20) @ WELLESLEY STREET  6 HSIP $2,681,330 $2,681,330 $2,413,197 $268,133 Construction; HSIP Total Cost = $2,681,330; MPO Evaluation Score = 50.6.
Roadway Reconstruction $74,625,488 $59,800,390 $14,825,098
2026 606226 Boston Region Boston BOSTON- RECONSTRUCTION OF RUTHERFORD AVENUE, FROM CITY SQUARE TO SULLIVAN SQUARE 6 NHPP $190,696,612 $12,000,000 $9,600,000 $2,400,000 Construction; NHPP+STBG+TAP Total Cost = $190,696,612; AC schedule over 5 years (2025-2029); Total funding in this TIP = $99,783,959; $25,000,000 in anticipated funding provided by City of Boston; MPO Evaluation Score = 59; TAP Proponent = Boston.
2026 606226 Boston Region Boston BOSTON- RECONSTRUCTION OF RUTHERFORD AVENUE, FROM CITY SQUARE TO SULLIVAN SQUARE 6 STBG $190,696,612 $19,500,000 $15,600,000 $3,900,000 Construction; NHPP+STBG+TAP Total Cost = $190,696,612; AC schedule over 5 years (2025-2029); Total funding in this TIP = $99,783,959; $25,000,000 in anticipated funding provided by City of Boston; MPO Evaluation Score = 59; TAP Proponent = Boston.
2026 606226 Boston Region Boston BOSTON- RECONSTRUCTION OF RUTHERFORD AVENUE, FROM CITY SQUARE TO SULLIVAN SQUARE 6 TAP $190,696,612 $2,000,000 $1,600,000 $400,000 Construction; NHPP+STBG+TAP Total Cost = $190,696,612; AC schedule over 5 years (2025-2029); Total funding in this TIP = $99,783,959; $25,000,000 in anticipated funding provided by City of Boston; MPO Evaluation Score = 59; TAP Proponent = Boston.
2026 608045 Boston Region Milford MILFORD- REHABILITATION ON ROUTE 16, FROM ROUTE 109 TO BEAVER STREET 3 HSIP $10,119,616 $1,000,000 $900,000 $100,000 Construction; HSIP+STBG Total Cost = $10,119,616;
MPO Evaluation Score = 43.
2026 608045 Boston Region Milford MILFORD- REHABILITATION ON ROUTE 16, FROM ROUTE 109 TO BEAVER STREET 3 STBG $10,119,616 $9,119,616 $7,295,693 $1,823,923 Construction; HSIP+STBG Total Cost = $10,119,616;
MPO Evaluation Score = 43.
2026 608954 Boston Region Weston WESTON- RECONSTRUCTION ON ROUTE 30 6 STBG $17,028,272 $13,028,272 $10,422,618 $2,605,654 Construction; STBG+TAP Total Cost = $17,028,272;
MPO Evaluation Score = 49.2. TAP Proponent = Weston.
2026 608954 Boston Region Weston WESTON- RECONSTRUCTION ON ROUTE 30 6 TAP $17,028,272 $4,000,000 $3,200,000 $800,000 Construction; STBG+TAP Total Cost = $17,028,272;
MPO Evaluation Score = 49.2. TAP Proponent = Weston.
2026 609437 Boston Region Multiple SALEM- PEABODY- BOSTON STREET IMPROVEMENTS 4 STBG $13,977,600 $13,977,600 $11,182,080 $2,795,520 Construction; STBG Total Cost = $13,977,600; MPO Evaluation Score = 67.8.
Bicycle and Pedestrian $21,034,382 $16,827,506 $4,206,876
2026 609204 Boston Region Belmont BELMONT- COMMUNITY PATH, BELMONT COMPONENT OF THE MCRT (PHASE I) 4 CMAQ $21,034,382 $7,000,000 $5,600,000 $1,400,000 Construction; TAP+CMAQ+STBG Total Cost = $21,034,382; MPO Evaluation Score = 64.6; TAP Proponent = Belmont.
2026 609204 Boston Region Belmont BELMONT- COMMUNITY PATH, BELMONT COMPONENT OF THE MCRT (PHASE I) 4 STBG $21,034,382 $9,034,382 $7,227,506 $1,806,876 Construction; TAP+CMAQ+STBG Total Cost = $21,034,382; MPO Evaluation Score = 64.6; TAP Proponent = Belmont.
2026 609204 Boston Region Belmont BELMONT- COMMUNITY PATH, BELMONT COMPONENT OF THE MCRT (PHASE I) 4 TAP $21,034,382 $5,000,000 $4,000,000 $1,000,000 Construction; TAP+CMAQ+STBG Total Cost = $21,034,382; MPO Evaluation Score = 64.6; TAP Proponent = Belmont.
Flex to FTA $6,500,000 $5,200,000 $1,300,000
2026 S12113 Boston Region Multiple TRANSIT MODERNIZATION PROGRAM   CMAQ $19,500,000 $6,500,000 $5,200,000 $1,300,000 Construction; Flex to FTA; Set aside for LRTP Transit Modernization Program.
Transit Grant Program $2,500,000 $2,000,000 $500,000
2026 S12124 Boston Region Multiple COMMUNITY CONNECTIONS PROGRAM   CMAQ $6,716,799 $2,500,000 $2,000,000 $500,000 Planning, Design, or Construction; Set Aside for LRTP Community Connections Program.
Section 1B / Earmark or Discretionary Grant Funded Projects $210,463,772 $168,371,018 $42,092,754
Bridge On-system Non-NHS NB $7,204,512 $5,763,610 $1,440,902
2026 612075 Boston Region Salem SALEM- BRIDGE REPLACEMENT, S-01-024, JEFFERSON AVENUE OVER PARALLEL STREET 4 HIP-BR $3,239,040 $3,239,040 $2,591,232 $647,808
2026 612099 Boston Region   ASHLAND- BRIDGE REPLACEMENT, A-14-006, CORDAVILLE ROAD OVER SUDBURY RIVER 3 HIP-BR $3,965,472 $3,965,472 $3,172,378 $793,094
Bridge On-System NHS NB $203,259,260 $162,607,408 $40,651,852
2026 612496 Boston Region Somerville SOMERVILLE- BRIDGE PRESERVATION, S-17-031, I-93 (NB & SB) FROM ROUTE 28 TO TEMPLE STREET (PHASE 2) 4 HIP-BR $203,259,260 $203,259,260 $162,607,408 $40,651,852
Section 2A / State Prioritized Reliability Projects $45,807,583 $37,247,438 $8,560,145
Bridge On-system NHS $18,484,426 $14,787,541 $3,696,885
2026 605321 Boston Region Norwood NORWOOD- BRIDGE PRESERVATION, N-25-026, PROVIDENCE HIGHWAY (STATE ROUTE 1) OVER THE NEPONSET RIVER 5 NHPP $3,588,426 $3,588,426 $2,870,741 $717,685
2026 606449 Boston Region Cambridge CAMBRIDGE- BRIDGE REPLACEMENT, C-01-008, FIRST STREET BRIDGE & C-01-040, LAND BOULEVARD/BROAD CANAL BRIDGE 6 NHPP $14,896,000 $14,896,000 $11,916,800 $2,979,200
Safety Improvements $6,013,718 $5,412,346 $601,372
2026 607748 Boston Region Acton ACTON- INTERSECTION & SIGNAL IMPROVEMENTS ON SR 2 & SR 111 (MASSACHUSETTS AVENUE) AT PIPER ROAD & TAYLOR ROAD 3 HSIP $4,231,214 $3,500,214 $3,150,193 $350,021
2026 611954 Boston Region Boston BOSTON- GUIDE AND TRAFFIC SIGN REPLACEMENT ON I-90/I-93 WITHIN CENTRAL ARTERY/TUNNEL SYSTEM 6 HSIP $2,513,504 $2,513,504 $2,262,154 $251,350
Non-Interstate Pavement $18,051,320 $14,441,056 $3,610,264
2026 612049 Boston Region Randolph RANDOLPH- RESURFACING AND RELATED WORK ON ROUTE 24 6 NHPP $9,466,800 $9,466,800 $7,573,440 $1,893,360
2026 612050 Boston Region Multiple BRAINTREE- WEYMOUTH- RESURFACING AND RELATED WORK ON ROUTE 3 6 NHPP $8,584,520 $8,584,520 $6,867,616 $1,716,904
Bridge Off-system $3,258,119 $2,606,495 $651,624
2026 612076 Boston Region Topsfield TOPSFIELD- BRIDGE REPLACEMENT, T-06-013, PERKINS ROW OVER MILE BROOK 4 STBG-BR-Off $3,258,119 $3,258,119 $2,606,495 $651,624
Section 2B / State Prioritized Modernization Projects $70,717,002 $62,728,608 $7,988,394
Intersection Improvements $15,120,761 $13,608,685 $1,512,076
2026 607748 Boston Region Acton ACTON- INTERSECTION & SIGNAL IMPROVEMENTS ON SR 2 & SR 111 (MASSACHUSETTS AVENUE) AT PIPER ROAD & TAYLOR ROAD 3 HSIP $4,231,214 $731,000 $657,900 $73,100
2026 610665 Boston Region Stoneham STONEHAM- INTERSECTION IMPROVEMENTS AT ROUTE 28 (MAIN STREET), NORTH BORDER ROAD AND SOUTH STREET 4 HSIP $4,872,001 $4,872,001 $4,384,801 $487,200
2026 611974 Boston Region Medford MEDFORD- INTERSECTION IMPROVEMENTS AT MAIN STREET AND SOUTH STREET 4 HSIP $9,517,760 $9,517,760 $8,565,984 $951,776
Roadway Reconstruction $55,596,241 $49,119,923 $6,476,318
2026 607977 Boston Region Multiple HOPKINTON- WESTBOROUGH- RECONSTRUCTION OF I-90/I-495 INTERCHANGE 3 NFP-I $300,942,837 $46,429,306 $41,786,375 $4,642,931 Other FA - SW HIP: $6,784,226 (FY 2022); HIP  Boston: $5,176,619 (FY 2022); BUILD Grant: $26,250,000 (FY 2022); HIP BR: $40,000,000 (FY 2023); $111,166,667 WT Funding
2026 S12205 Boston Region Framingham FRAMINGHAM - IMPROVEMENTS AT HARMONY GROVE ELEMENTARY SCHOOL (SRTS) 3 TAP $1,467,987 $1,644,145 $1,315,316 $328,829 SRTS infrastructure project awarded in 2022. To be updated with project ID once approved by PRC. 12% inflation applied for FFY 2026.
2026 S12209 Boston Region Sharon SHARON - IMPROVEMENTS AT COTTAGE STREET ELEMENTARY SCHOOL (SRTS) 5 TAP $1,282,960 $1,436,915 $1,149,532 $287,383 SRTS infrastructure project awarded in 2022. To be updated with project ID once approved by PRC. 12% inflation applied for FFY 2026.
2026 S12210 Boston Region Brookline BROOKLINE - IMPROVEMENTS AT WILLIAM H. LINCOLN SCHOOL (SRTS) 6 TAP $1,165,913 $1,305,823 $1,044,658 $261,165 SRTS infrastructure project awarded in 2022. To be updated with project ID once approved by PRC. 12% inflation applied for FFY 2026.
2026 S12211 Boston Region Chelsea CHELSEA - IMPROVEMENTS AT MARY C ELEMENTARY ELEMENTARY (SRTS) 6 TAP $2,592,188 $2,903,250 $2,322,600 $580,650 SRTS infrastructure project awarded in 2022. To be updated with project ID once approved by PRC. 12% inflation applied for FFY 2026.
2026 S12212 Boston Region Dedham DEDHAM - IMPROVEMENTS AT AVERY ELEMENTARY SCHOOL (SRTS) 6 TAP $1,675,716 $1,876,802 $1,501,442 $375,360 SRTS infrastructure project awarded in 2022. To be updated with project ID once approved by PRC. 12% inflation applied for FFY 2026.
Section 2C / State Prioritized Expansion Projects $23,553,016 $18,842,413 $4,710,603
Bicycle and Pedestrian $23,553,016 $18,842,413 $4,710,603
2026 607329 Boston Region Multiple WAKEFIELD- LYNNFIELD- RAIL TRAIL EXTENSION, FROM THE GALVIN MIDDLE SCHOOL TO LYNNFIELD/PEABODY T.L. 4 CMAQ $12,360,675 $12,360,675 $9,888,540 $2,472,135
2026 612499 Boston Region Medford MEDFORD- SOUTH MEDFORD CONNECTOR BIKE PATH 4 CMAQ $7,903,743 $7,903,741 $6,322,993 $1,580,748
2026 612607 Boston Region Danvers DANVERS- RAIL TRAIL WEST EXTENSION (PHASE 3) 4 CMAQ $3,288,600 $3,288,600 $2,630,880 $657,720
Section 3B / Non-Federal Aid Funded $26,680,000 $0 $26,680,000
NFA $26,680,000 $0 $26,680,000
2026 607977 Boston Region Multiple HOPKINTON- WESTBOROUGH- RECONSTRUCTION OF I-90/I-495 INTERCHANGE 3 NFA $300,942,837 $26,680,000 $0 $26,680,000 Other FA - SW HIP: $6,784,226 (FY 2022); HIP  Boston: $5,176,619 (FY 2022); BUILD Grant: $26,250,000 (FY 2022); HIP BR: $40,000,000 (FY 2023); $111,166,667 WT Funding

Year MassDOT Project ID MPO Municipality MassDOT Project Description District Funding Source Adjusted TFPC Total Programmed Funds Federal Funds Non-Federal Funds Other Information
Federal Fiscal Year 2027 $759,436,355 $377,704,991 $381,731,364
Section 1A / Regionally Prioritized Projects $128,586,581 $103,769,265 $24,817,316
Roadway Reconstruction $110,654,581 $89,423,665 $21,230,916
2027 606226 Boston Region Boston BOSTON- RECONSTRUCTION OF RUTHERFORD AVENUE, FROM CITY SQUARE TO SULLIVAN SQUARE 6 NHPP $190,696,612 $12,000,000 $9,600,000 $2,400,000 Construction; NHPP+STBG+TAP Total Cost = $190,696,612; AC schedule over 5 years (2025-2029); Total funding in this TIP = $99,783,959; $25,000,000 in anticipated funding provided by City of Boston; MPO Evaluation Score = 59; TAP Proponent = Boston.
2027 606226 Boston Region Boston BOSTON- RECONSTRUCTION OF RUTHERFORD AVENUE, FROM CITY SQUARE TO SULLIVAN SQUARE 6 STBG $190,696,612 $19,500,000 $15,600,000 $3,900,000 Construction; NHPP+STBG+TAP Total Cost = $190,696,612; AC schedule over 5 years (2025-2029); Total funding in this TIP = $99,783,959; $25,000,000 in anticipated funding provided by City of Boston; MPO Evaluation Score = 59; TAP Proponent = Boston.
2027 606226 Boston Region Boston BOSTON- RECONSTRUCTION OF RUTHERFORD AVENUE, FROM CITY SQUARE TO SULLIVAN SQUARE 6 TAP $190,696,612 $2,000,000 $1,600,000 $400,000 Construction; NHPP+STBG+TAP Total Cost = $190,696,612; AC schedule over 5 years (2025-2029); Total funding in this TIP = $99,783,959; $25,000,000 in anticipated funding provided by City of Boston; MPO Evaluation Score = 59; TAP Proponent = Boston.
2027 607981 Boston Region Somerville SOMERVILLE- MCGRATH BOULEVARD CONSTRUCTION 4 STBG $102,370,000 $20,000,000 $16,000,000 $4,000,000 Construction; STBG Total Cost = $102,370,000; AC schedule anticipated over 4 years (2027-2030); Total funding in this TIP = $20,000,000; MPO Evaluation Score = 72.2.
2027 609246 Boston Region Lynn LYNN- REHABILITATION OF WESTERN AVENUE (ROUTE 107) 4 HSIP $47,536,800 $3,000,000 $2,700,000 $300,000 Construction; STBG+HSIP Total Cost = $47,536,800; AC schedule anticipated over 3 years (2027-2029); Total funding in this TIP = $15,000,000; MPO Evaluation Score = 74.9.
2027 609246 Boston Region Lynn LYNN- REHABILITATION OF WESTERN AVENUE (ROUTE 107) 4 STBG $47,536,800 $12,000,000 $9,600,000 $2,400,000 Construction; STBG+HSIP Total Cost = $47,536,800; AC schedule anticipated over 3 years (2027-2029); Total funding in this TIP = $15,000,000; MPO Evaluation Score = 74.9.
2027 610932 Boston Region Brookline BROOKLINE- REHABILITATION OF WASHINGTON STREET 6 HSIP $30,030,812 $5,000,000 $4,500,000 $500,000 Construction; HSIP+STBG Total Cost = $30,030,812;
MPO Evaluation Score = 62.4.
2027 610932 Boston Region Brookline BROOKLINE- REHABILITATION OF WASHINGTON STREET 6 STBG $30,030,812 $25,030,812 $20,024,650 $5,006,162 Construction; HSIP+STBG Total Cost = $30,030,812;
MPO Evaluation Score = 62.4.
2027 611983 Boston Region Chelsea CHELSEA- PARK STREET & PEARL STREET RECONSTRUCTION 6 HSIP $12,123,769 $1,000,000 $900,000 $100,000 Construction; STBG+HSIP Total Cost = $12,123,769;
MPO Evaluation Score = 69.9.
2027 611983 Boston Region Chelsea CHELSEA- PARK STREET & PEARL STREET RECONSTRUCTION 6 STBG $12,123,769 $11,123,769 $8,899,015 $2,224,754 Construction; STBG+HSIP Total Cost = $12,123,769;
MPO Evaluation Score = 69.9.
Bicycle and Pedestrian $8,932,000 $7,145,600 $1,786,400
2027 610666 Boston Region Swampscott SWAMPSCOTT- RAIL TRAIL CONSTRUCTION 4 CMAQ $8,932,000 $8,932,000 $7,145,600 $1,786,400 Construction; CMAQ Total Cost = $8,932,000; MPO Evalution Score = 66.4.
Flex to FTA $6,500,000 $5,200,000 $1,300,000
2027 S12113 Boston Region Multiple TRANSIT MODERNIZATION PROGRAM   CMAQ $19,500,000 $6,500,000 $5,200,000 $1,300,000 Construction; Flex to FTA; Set aside for LRTP Transit Modernization Program.
Transit Grant Program $2,500,000 $2,000,000 $500,000
2027 S12124 Boston Region Multiple COMMUNITY CONNECTIONS PROGRAM   CMAQ $6,716,799 $2,500,000 $2,000,000 $500,000 Planning, Design, or Construction; Set Aside for LRTP Community Connections Program.
Section 1B / Earmark or Discretionary Grant Funded Projects $152,065,685 $121,652,548 $30,413,137
Bridge On-System NHS NB $152,065,685 $121,652,548 $30,413,137
2027 606728 Boston Region Boston BOSTON- BRIDGE REPLACEMENT B-16-365, STORROW DRIVE OVER BOWKER RAMPS 6 HIP-BR $116,058,000 $116,058,000 $92,846,400 $23,211,600
2027 612519 Boston Region Boston BOSTON- BRIDGE REPLACEMENT, B-16-165, BLUE HILL AVENUE OVER RAILROAD 6 HIP-BR $36,007,685 $36,007,685 $28,806,148 $7,201,537
Section 2A / State Prioritized Reliability Projects $187,483,619 $72,372,661 $115,110,958
Bridge On-system Non-NHS $48,290,800 $0 $48,290,800
2027 607420 Boston Region Natick NATICK- SUPERSTRUCTURE REPLACEMENT, N-03-012, BODEN LANE OVER CSX/MBTA 3 NGBP $8,270,800 $8,270,800 $0 $8,270,800
2027 608514 Boston Region Beverly BEVERLY- BRIDGE REPLACEMENT, B-11-001, BRIDGE STREET OVER BASS RIVER (HALL-WHITAKER DRAWBRIDGE) 4 NGBP $40,020,000 $40,020,000 $0 $40,020,000
Non-Interstate Pavement $48,665,364 $38,932,291 $9,733,073
2027 609402 Boston Region Multiple FRAMINGHAM- NATICK- RESURFACING AND RELATED WORK ON ROUTE 9 3 NHPP $48,665,364 $48,665,364 $38,932,291 $9,733,073
Safety Improvements $22,185,800 $19,573,440 $2,612,360
2027 611969 Boston Region Everett EVERETT- INTERSECTION IMPROVEMENTS ON ROUTE 16 4 HSIP $17,748,000 $13,248,000 $11,923,200 $1,324,800
2027 612599 Boston Region Lynn LYNN- TARGETED SAFETY AND MULTIMODAL IMPROVEMENTS (PLAYBOOK PRIORITY CORRIDORS) 4 HSIP $8,937,800 $5,000,000 $4,500,000 $500,000
2027 612599 Boston Region Lynn LYNN- TARGETED SAFETY AND MULTIMODAL IMPROVEMENTS (PLAYBOOK PRIORITY CORRIDORS) 4 STBG $8,937,800 $3,937,800 $3,150,240 $787,560
Bridge On-system NHS $52,933,955 $0 $52,933,955
2027 611987 Boston Region Cambridge CAMBRIDGE- BRIDGE REPLACEMENT, C-01-026, MEMORIAL DRIVE OVER BROOKLINE STREET 6 NGBP $52,933,955 $52,933,955 $0 $52,933,955
Interstate Pavement $15,407,700 $13,866,930 $1,540,770
2027 612051 Boston Region Multiple CANTON- MILTON- RANDOLPH- INTERSTATE MAINTENANCE AND RELATED WORK ON I-93 6 NHPP-I $15,407,700 $15,407,700 $13,866,930 $1,540,770
Section 2B / State Prioritized Modernization Projects $90,168,278 $76,291,316 $13,876,962
Roadway Reconstruction $85,668,278 $72,691,316 $12,976,962
2027 607977 Boston Region Multiple HOPKINTON- WESTBOROUGH- RECONSTRUCTION OF I-90/I-495 INTERCHANGE 3 NHPP-I $300,942,837 $41,566,934 $37,410,241 $4,156,693 Other FA - SW HIP: $6,784,226 (FY 2022); HIP  Boston: $5,176,619 (FY 2022); BUILD Grant: $26,250,000 (FY 2022); HIP BR: $40,000,000 (FY 2023); $111,166,667 WT Funding
2027 609527 Boston Region Reading READING- IMPROVEMENTS ON I-95 4 NHPP $17,376,800 $17,376,800 $13,901,440 $3,475,360
2027 610543 Boston Region Multiple REVERE- MALDEN- IMPROVEMENTS AT ROUTE 1 (NB) 4 NHPP $8,363,600 $8,363,600 $6,690,880 $1,672,720
2027 612615 Boston Region Multiple CANTON- MILTON- ROADWAY RECONSTRUCTION ON ROUTE 138, FROM ROYALL STREET TO DOLLAR LANE 6 NHPP $18,360,944 $18,360,944 $14,688,755 $3,672,189
Intersection Improvements $4,500,000 $3,600,000 $900,000
2027 611969 Boston Region Everett EVERETT- INTERSECTION IMPROVEMENTS ON ROUTE 16 4 NHPP $17,748,000 $4,500,000 $3,600,000 $900,000
Section 2C / State Prioritized Expansion Projects $4,524,001 $3,619,201 $904,800
Bicycle and Pedestrian $4,524,001 $3,619,201 $904,800
2027 610660 Boston Region Multiple SUDBURY- WAYLAND- MASS CENTRAL RAIL TRAIL (MCRT) 3 CMAQ $4,524,001 $4,524,001 $3,619,201 $904,800
Section 3B / Non-Federal Aid Funded $196,608,191 $0 $196,608,191
Bridge On-system Non-NHS NB $95,383,436 $0 $95,383,436
2027 605276 Boston Region Multiple BEVERLY- SALEM- DRAWBRIDGE REPLACEMENT/REHABILITATION OF B-11-005=S-01-013, KERNWOOD AVENUE OVER DANVERS RIVER 4 NGBP $95,383,436 $95,383,436 $0 $95,383,436
Bridge On-system Non-NHS $48,290,800 $0 $48,290,800
2027 607420 Boston Region Natick NATICK- SUPERSTRUCTURE REPLACEMENT, N-03-012, BODEN LANE OVER CSX/MBTA 3 NGBP $8,270,800 $8,270,800 $0 $8,270,800
2027 608514 Boston Region Beverly BEVERLY- BRIDGE REPLACEMENT, B-11-001, BRIDGE STREET OVER BASS RIVER (HALL-WHITAKER DRAWBRIDGE) 4 NGBP $40,020,000 $40,020,000 $0 $40,020,000
Bridge On-system NHS $52,933,955 $0 $52,933,955
2027 611987 Boston Region Cambridge CAMBRIDGE- BRIDGE REPLACEMENT, C-01-026, MEMORIAL DRIVE OVER BROOKLINE STREET 6 NGBP $52,933,955 $52,933,955 $0 $52,933,955

Table 3-8
FFYs 2023–27 TIP Transit Table (MBTA Federal Capital Program)

Federal Funding Program ALI 2023 2024 2025 2026 2027 FFY23-27 Total (Federal) FFY23-27 Total (Incl. Match)

5307   $188,718,272 $193,663,464 $197,677,960 $202,720,389 $207,622,091 $990,402,177 $1,238,002,721
Bridge & Tunnel Program   12.24.05 $0 $10,000,000 $10,000,000 $10,000,000 $10,000,000 $40,000,000 $50,000,000
Revenue Vehicle Program  12.12.00 $88,612,555 $106,661,899 $110,676,395 $115,718,824 $120,620,526 $542,290,198 $677,862,747
Signals/Systems Upgrade Program  12.63.01 $6,070,405 $49,580,129 $49,580,129 $49,580,129 $49,580,129 $204,390,923 $255,488,653
Stations and Facilities Program  12.34.00 $94,035,312 $27,421,436 $27,421,436 $27,421,436 $27,421,436 $203,721,056 $254,651,320

5337   $229,289,490 $234,344,881 $238,400,903 $243,546,639 $248,457,689 $1,194,039,602 $1,492,549,503
Bridge & Tunnel Program   12.24.05 $17,263,690 $84,522,118 $88,578,140 $93,723,876 $98,634,926 $382,722,751 $478,403,439
Revenue Vehicle Program  12.12.00 $103,904,747 $21,876,517 $21,876,517 $21,876,517 $22,757,316 $192,291,613 $240,364,516
Signals/Systems Upgrade Program  12.63.01 $27,746,281 $36,113,602 $36,113,602 $36,113,602 $36,113,602 $172,200,689 $215,250,862
Stations and Facilities Program  12.34.00 $80,374,771 $91,832,644 $91,832,644 $91,832,644 $90,951,845 $446,824,549 $558,530,687

5339   $6,016,454 $6,253,263 $6,445,503 $6,686,969 $6,932,418 $32,334,607 $40,418,259
Bus Program  11.14.00 $6,016,454 $6,253,263 $6,445,503 $6,686,969 $6,932,418 $32,334,607 $40,418,259

FFY23-27 FTA Formula Funding   $424,024,215 $434,261,608 $442,524,367 $452,953,997 $463,012,199 $2,216,776,386 $2,770,970,483

Other Federal   $147,500,000 $147,500,000 $516,564,667 $225,085,333 $125,000,000 $1,161,650,000 $1,161,650,000
RRIF Financing - PTC/ATC/Fiber 12.63.01 $0 $0 $369,064,667 $100,085,333 $0 $469,150,000 $469,150,000
RRIF/TIFIA Financing Program 12.24.05 $147,500,000 $147,500,000 $147,500,000 $125,000,000 $125,000,000 $692,500,000 $692,500,000

FFY23-27 Total Federal Funding   $571,524,215 $581,761,608 $959,089,034 $678,039,330 $588,012,199 $3,378,426,386 $3,932,620,483

Notes:
FTA formula funds (5307, 5337 and 5339) are based on estimated apportionments for FFY23-27. This includes additional funding to be made available through the Bipartisan Infrastructure Law (BIL), based on current estimates.
TIP programs and projects are based on the draft FY23-27 CIP and planned federal obligations as of Apr-22. Adjustments will be made to federal projects and budgets as the FY23-27 CIP is finalized.
The Activity Line Item (ALI) codes are preliminary only and generally reflect the bulk of the TIP program. Within a program there may be several different ALI codes used.
RRIF loan funding for the PTC/ATC/Fiber Resiliency project is based on the currently planned drawdown schedule and is subject to change.
RRIF/TIFIA financing program funding is an initial estimate and will be refined as projects are identified and loans are finalized with the Build America Bureau.

Table 3-9
FFYs 2023–27 TIP Transit Table (MBTA Federal Capital Program – Project List and Descriptions [80% Federal Share])

FTA Formula Funds (5307, 5337, 5339)
5307 - Bridge and Tunnel
5307 Bridge and Tunnel P0912 Systemwide Tunnel Flood Mitigation Program $0 $40,000,000 $40,000,000 Planning, training, and infrastructure improvements to make the tunnel network more resilient to flooding exposures due to storm surge, precipitation, and sea level rise.
$0 $40,000,000 $40,000,000
5307 - Revenue Vehicles
5307 Revenue Vehicles P0369 Green Line Type 10 Light Rail Fleet Replacement $0 $264,584,510 $264,584,510 Procurement of 102 new fully-accessible light rail vehicles (LRV) fleet to replace the existing Type 7 and Type 8 fleets and increase system capacity.
5307 Revenue Vehicles P0618 Procurement of 40ft Enhanced Electric Hybrid Buses $154,316,086 $127,577,551 $281,893,637 Procurement of 460 40ft Enhanced Electric Hybrid (EEH) buses to replace 310 40ft diesel buses purchased in 2006-2008 and support more reliable, efficient, and sustainable operations. Includes vehicle testing, warranty, and inspection.
5307 Revenue Vehicles P0633 MBTA Catamaran Overhauls $0 $5,773,824 $5,773,824 Overhaul of two 149-passenger subchapter "T" ferries. Includes end products as well as capital spare parts, manuals, diagnostic test equipment, tools, training, training aids, warranty, and associated materials, equipment, and services.
5307 Revenue Vehicles P0649 Option Order Procurement of New Flyer Hybrid 40ft Buses $0 $7,135,142 $7,135,142 Procurement of 194 40ft buses with hybrid propulsion to replace an aging fleet and improve fuel economy.
5307 Revenue Vehicles P0652 Procurement of 100 Bi-Level Commuter Rail Coaches $0 $35,076,265 $35,076,265 Procurement of 100 Bi-Level Commuter Rail coaches to replace aging single-level coaches, expand capacity from 120 to 180 passengers per coach, reduce number of coaches required, and mitigate operational bottlenecks.
5307 Revenue Vehicles P0653 Procurement of 40ft Battery Electric Buses and Related Infrastructure $0 $37,454,168 $37,454,168 Purchase of 80 40ft battery electric buses (BEBs) to replace fleets currently running diesel bus service out of Quincy and trolleybus service out of North Cambridge.
5307 Revenue Vehicles P0860 Hybrid Bus Overhaul (New Flyer XDE40 - SR 1881) $0 $10,400,000 $10,400,000 Midlife overhaul of major systems and components (engine, drive unit, cooling systems, axles, brakes, among others) of 60 40ft BAE Hybrid buses to ensure reliable and safe operations and to meet FTA service life requirements.
5307 Revenue Vehicles P0911 Hybrid and CNG Bus Overhaul $0 $20,800,000 $20,800,000 Midlife overhaul of major systems and components of 156 40ft hybrid buses, 175 40ft CNG buses, and 45 60ft hybrid buses to ensure reliable and safe operations that meet FTA requirements.
5307 Revenue Vehicles P1016 Mattapan Trolley Select System Upgrade $0 $2,768,739 $2,768,739 Overhaul of the 75+ year old PCC cars operating on the Mattapan Line to improve reliability of the fleet.  Includes work on the propulsion system, trucks, auxiliary electrical power system, wiring, lighting, doors, car body, and paint.
5307 Revenue Vehicles P1151 Blue Line Vehicle Mid-Life Overhaul $0 $800,000 $800,000 Planning for the midlife overhaul of 94 Blue Line heavy rail vehicles built by Siemens. The project will address systems at or nearing the end of their intended service lives, obsolete components and functional improvements.
5307 Revenue Vehicles P1154 CNG Bus Overhaul (New Flyer XN40 - SR 1982) $0 $800,000 $800,000 Planning for the midlife overhaul of 175 forty-foot New Flyer CNG buses delivered in 2016-2017. These buses require overhaul of major systems and components to ensure continued reliable and safe operations and to meet FTA service life requirements.
5307 Revenue Vehicles P1155 Hybrid Bus Overhaul (New Flyer XDE40 - SR 2011) $0 $800,000 $800,000 Planning for the midlife overhaul of 44 sixty-foot New Flyer hybrid buses delivered in 2016-2017. These buses require overhaul of major systems and components to ensure continued reliable and safe operations and to meet FTA service life requirements.
5307 Revenue Vehicles P1162 Reliability Centered Maintenance - Blue, Orange and Red Line $0 $28,320,000 $28,320,000 Improvements to trucks, brakes, motors, current collectors, propulsion and auxiliary fuses on the Blue Line and improvements to propulsion, brakes, HVAC, and doors on the Red and Orange Lines.
$154,316,086 $542,290,198 $696,606,284
5307 - Signals and Systems
5307 Signals and Systems P0285 Signal Program - Red/Orange Line $0 $112,762,427 $112,762,427 Replacement and upgrade of signal equipment on the Red and Orange Lines. Includes renewal of track circuit modules using latest digital audio frequency technology and replacement of wayside equipment on the Orange Line south of Haymarket.
5307 Signals and Systems P0857 Mattapan HSL Transformation $0 $91,628,495 $91,628,495 State of good repair and accessibility improvements, power upgrades, and other infrastructure investments on the Mattapan Line.
$0 $204,390,923 $204,390,923
5307 - Stations and Facilities
5307 Stations and Facilities P0075 Elevator Program Multiple Location Design $0 $43,778,268 $43,778,268 Design and some construction work for the replacement of elevators and/or addition of new, redundant elevators and related wayfinding amenities at transit stations.
5307 Stations and Facilities P0078 Hingham Ferry Dock Modification $0 $6,239,134 $6,239,134 Replacement of existing floating dock, access gangway, canopy, and walkways; extension of canopy structure to the Hingham Intermodal Center; and upgraded lighting, safety, and security systems.
5307 Stations and Facilities P0631 Blue Line Infrastructure Improvements $0 $21,790,908 $21,790,908 Includes rebuilding of the Long Wharf Emergency Egress; track and tunnel infrastructure improvements between Aquarium and Maverick; communication rooms improvements; and Suffolk Downs station reconstruction.
5307 Stations and Facilities P0671a Quincy Bus Facility Modernization $29,515,360 $48,437,287 $77,952,647 Relocation and replacement of the Quincy bus maintenance facility. The new, modernized facility will expand capacity and include the infrastructure necessary to support the MBTA’s first battery-electric bus fleet (BEBs).
5307 Stations and Facilities P0671b Arborway Bus Facility - Design Funding $0 $28,800,000 $28,800,000 Design funding to support the construction of a new Arborway bus facility to accommodate battery electric bus (BEB) infrastructure.
5307 Stations and Facilities P0671c North Cambridge Bus Facility Modernization $0 $20,000,000 $20,000,000 Renovation of North Cambridge facility to support conversion to battery electric bus (BEB) fleets.
5307 Stations and Facilities P0679 Codman Yard Expansion and Improvements $45,762,897 $25,555,459 $71,318,356 Improvements to Codman Yard including in-kind replacement of existing infrastructure and expansion of storage capacity to support the new Red Line fleet.
5307 Stations and Facilities P1113 Bus Priority Project Construction $0 $9,120,000 $9,120,000 Funding to support construction of bus priority infrastructure. This may include side or center-running bus lanes, transit signal priority, pavement markings, and stop upgrades.
$75,278,257 $203,721,056 $278,999,313
5337 - Bridge and Tunnel
5337 Bridge and Tunnel P0006 Gloucester Drawbridge Replacement $12,402,981 $0 $12,402,981 Replacement of Gloucester Drawbridge on the Rockport Line. The new bridge will consist of a moveable bascule span with two independent barrels, two spans of precast concrete box beams, a new steel superstructure, and a new micro-pile abutment.
5337 Bridge and Tunnel P0008 Emergency Bridge Design / Inspection & Rating $222,194 $1,975,145 $2,197,339 Funding to support emergency design, inspection, and rating of bridges as needed.
5337 Bridge and Tunnel P0009 Bridges - Design $0 $8,293,339 $8,293,339 Design funding to support the repair, rehabilitation, and replacement of bridges across the system.
5337 Bridge and Tunnel P0018 North Station Draw 1 Bridge Replacement $0 $141,131,308 $141,131,308 Replacement of North Station Draw 1 bridge structure and control tower. Includes expansion of bridge capacity from 4 to 6 tracks, expansion of station platform capacity from 10 to 12 tracks, and a pedestrian path across the Charles River.
5337 Bridge and Tunnel P0037 Emergency Bridge Repair $5,014,180 $0 $5,014,180 Funding to support emergency bridge repairs on an on-call basis.
5337 Bridge and Tunnel P0182 Tunnel Rehabilitation $268,383 $0 $268,383 Construction and professional services relating to tunnel repair and inspection.
5337 Bridge and Tunnel P0495 Bridge Bundling Contract $47,357,564 $0 $47,357,564 Replacement of six commuter rail bridges at Intervale Rd. in Weston; Bacon St. in Wellesley; High Line Bridge in Somerville; Lynn Fells Parkway in Melrose; Parker St. in Lawrence; and Commercial St. in Lynn.
5337 Bridge and Tunnel P0551 Longfellow Approach $0 $151,681,341 $151,681,341 Rehabilitation of Longfellow Approach viaduct, Span 1 of the Longfellow Bridge, and station platforms at Charles/MGH Station. Includes new track, power, communication and signal systems, and additional emergency egress and redundant elevators.
5337 Bridge and Tunnel P0552 Dorchester Avenue Bridge $29,700,062 $0 $29,700,062 Replacement of Dorchester Avenue Bridge and installation of a new tunnel roof beneath the bridge.
5337 Bridge and Tunnel P0627 Systemwide Bridge Inspection and Rating $15,987,600 $31,092,600 $47,080,200 Program to support in-depth inspection and load rating of MBTA-owned bridges at regular intervals. Load ratings are used to establish a systemwide priority list of bridge repairs, rehabilitation, and replacement.
5337 Bridge and Tunnel P0892 Saugus Drawbridge Replacement $8,000,000 $0 $8,000,000 Design of Saugus Drawbridge replacement on the Newburyport/Rockport Line. The new bridge would include a widened approach embankment, a new control house, signal upgrades, and relocation of submerged utilities.
5337 Bridge and Tunnel P0907 East Street Bridge Replacement (Dedham) $0 $14,400,000 $14,400,000 Replacement of East Street bridge carrying the Franklin Line in Dedham. The new bridge will feature improved vertical and horizontal clearance, improved roadway features, and improved pedestrian and vehicle access to East Street.
5337 Bridge and Tunnel P1107 Bridge Program Pipeline - Rehabilitation, Repair and Replacement $0 $16,000,000 $16,000,000 This program uses information provided through the bridge inspection and load rating program to design and construct prioritized bridge rehabilitation, repair, or replacement projects.
5337 Bridge and Tunnel P1115 South Elm Street Bridge Replacement $12,154,290 $0 $12,154,290 Replacement of South Elm Street bridge on the Haverhill Line serving Commuter Rail, Downeaster, and Pan Am freight trains.
5337 Bridge and Tunnel P1116 Systemwide Culvert Inspection and Load Rating $0 $8,400,000 $8,400,000 Inventory, inspection, and load rating of the MBTA's approximately 1,300 culverts supporting in-service structures systemwide. The scope of work includes an initial inspection to establish baseline condition, followed by inspection every five years.
5337 Bridge and Tunnel R0074 Tunnel Inspection Systemwide $7,130,983 $9,749,018 $16,880,000 Ongoing inspection and rating of Red Line, Orange Line, Green Line, and Blue Line tunnels.
$138,238,238 $382,722,751 $520,960,989
5337 - Revenue Vehicles
5337 Revenue Vehicles P0239 F40 Commuter Rail Locomotive Overhaul $33,670,671 $0 $33,670,671 Overhaul of 37 F40 Commuter Rail locomotives to improve reliability and reduce risk of unplanned maintenance.
5337 Revenue Vehicles P0370 Green Line Train Protection $80,100,555 $13,035,090 $93,135,645 Procurement and installation of on-board and wayside equipment for a train protection and information system on the Green Line to mitigate red signal violations, train-to-train collisions, derailments, and intrusions into work zones.
5337 Revenue Vehicles P0918 Future Rolling Stock Fleet $0 $40,000,000 $40,000,000 Planning funds to support future procurement of 25 electrified or multi-mode Commuter Rail rolling stock to replace the oldest vehicles in the fleet.
5337 Revenue Vehicles P0927 Rolling Stock - Locomotive and Coach State of Good Repair and Resiliency $0 $139,256,523 $139,256,523 Upgrades to improve system reliability, correct deficiencies, standardize procedures, and increase equipment availability for Commuter Rail rolling stock. Includes vehicle procurement, testing support, service life enhancement, and overhauls.
$113,771,226 $192,291,613 $306,062,839
5337 - Signals and Systems
5337 Signals and Systems P0146 SCADA Upgrades $1,600,000 $0 $1,600,000 Upgrades to the Power Supervisory Control and Data Acquisition (SCADA) communication network from leased lines to the Security Wide Area Network (SWAN) to provide high-speed ethernet connection at traction power substations and unit substations.
5337 Signals and Systems P0212 North Station Terminal Signal $4,000,000 $0 $4,000,000 Upgrade of signal system at North Station including new microprocessor technology, nine new signal houses, two new crossovers, and the relocation of critical signal equipment above the 500-year floodplain.
5337 Signals and Systems P0261 Worcester Line Track and Station Accessibility Improvements $0 $25,885,743 $25,885,743 New third track and realignment of existing tracks on the Framingham and Worcester Commuter Rail lines between Weston and Framingham. Includes upgrades to Wellesley Farms, Wellesley Hills, Wellesley Square, and West Natick Stations.
5337 Signals and Systems P0283 Green Line Central Tunnel Signal - 25 Cycle $0 $4,000,000 $4,000,000 Replacement of 25Hz track circuits with 100Hz track circuits in the Green Line central tunnel. Includes replacement of track circuit cable, trough, messenger, cases, relays, rectifiers, and signal power equipment.
5337 Signals and Systems P0301 Systemwide Radio $60,333,511 $0 $60,333,511 Upgrade of the MBTA’s existing two-way radio system used by MBTA Transit Police and operations personnel. This project includes mobile radios for heavy rail, light rail, and bus vehicles.
5337 Signals and Systems P0591 Green Line Central Tunnel Track and Signal Replacement $10,270,834 $85,729,166 $96,000,000 Rehabilitation and upgrades to signal and track infrastructure within the Green Line Central Tunnel. Includes central instrumentation houses and signal, track, and power systems at Copley, Park Street, and Government Center.
5337 Signals and Systems P0675 Orange Line Southwest Corridor Track Replacement $0 $12,500,806 $12,500,806 Reconstruction of track and support systems on the Southwest Corridor of the Orange Line between Chinatown and Forest Hills Stations.
5337 Signals and Systems P0705 Power Systems Resiliency Program $2,689,311 $8,727,333 $11,416,644 Replacement of damaged power cable duct banks that energize areas of the Red, Orange, Blue, and Green Line. Includes excavation, demolition, conduit replacement, manhole replacement, surface restoration, and power cable installation.
5337 Signals and Systems P0904 Systemwide Asset Management Program Phase 3 $9,107,291 $0 $9,107,291 Implementation of the Asset Management Program in accordance with FTA requirements. Includes professional services, audit, inventory, condition assessments, updates to the National Transit Database (NTD), and Transit Asset Management Plan (TAMP).
5337 Signals and Systems P1104 Traction Power Substation Upgrades $0 $5,760,000 $5,760,000 Complete replacement of electrical systems and strucural, mechanical, and plumbing improvements at nine aging traction power substations (TPSS). This scope also includes a TPSS Design Guide to standardize future improvements.
5337 Signals and Systems P1114 South Boston to Forest Hills Duct Bank Replacement $0 $12,946,281 $12,946,281 Replacement of duct banks and cables which carry AC power from the South Boston power complex to Forest Hills.
5337 Signals and Systems P1132 Ashmont Branch Track Replacement $0 $4,000,000 $4,000,000 Design and construction for partial reconstruction of track and track support systems on the Ashmont Branch of the Red Line.This is part of a series of Red Line track replacement projects.
5337 Signals and Systems P1133 Braintree Line Track Replacement $0 $1,200,000 $1,200,000 Design and construction for partial reconstruction of track and track support systems on the Braintree Branch of the Red Line. This is part of a series of Red Line track replacement projects.
5337 Signals and Systems P1139 Systemwide Asset Management Program Phase 4 $0 $9,600,000 $9,600,000 Implementation of the Asset Management Program in accordance with FTA requirements. Includes professional services; audit, inventory, condition assessments, updates to the National Transit Database (NTD), and Transit Asset Management Plan (TAMP).
5337 Signals and Systems P1149 Unit Substation Replacement Project $0 $1,851,360 $1,851,360 Development of unit substation (USS) Design Guide and replacement of existing power and electrical equipment at unit substation locations (USS), including AC feeder disconnect switches.
$88,000,946 $172,200,689 $260,201,636
5337 - Stations and Facilities
5337 Stations and Facilities P0066 Elevator Program $0 $641,008 $641,008 This program funds design and construction for elevator improvements on the rapid transit system. Individual elevator projects are separated into child projects once they reach the construction stage.
5337 Stations and Facilities P0074 Downtown Crossing Vertical Transportation Improvements Phase 2 $0 $62,208,880 $62,208,880 Design and construction of 3 new elevators to provide vertical transfers from the Red Line northbound to the Orange Line southbound platform, and from the Orange Line northbound to the Red Line southbound platform at Downtown Crossing.
5337 Stations and Facilities P0076 Oak Grove Station Vertical Transportation Improvements $800,000 $0 $800,000 Accessibility upgrades at Oak Grove station including 3 new elevators, replacement of one existing elevator, sidewalk repairs, and wayfinding and station brightening improvements.
5337 Stations and Facilities P0078 Hingham Ferry Dock Modification $400,000 $0 $400,000 Replacement of existing floating dock, access gangway, canopy, and walkways; extension of canopy structure to the Hingham Intermodal Center; and upgraded lighting, safety, and security systems.
5337 Stations and Facilities P0087 Braintree and Quincy Adams Garage Rehabilitation $3,396,000 $0 $3,396,000 Repairs to existing Braintree and Quincy Adams station garages. Includes upgrades to mechanical, electrical, plumbing, life safety systems, wayfinding, traffic circulation and parking layout. Also includes two new elevators at the Braintree garage.
5337 Stations and Facilities P0129 Newton Highlands Green Line Station Accessibility Project $0 $25,642,762 $25,642,762 Accessibility improvements at Newton Highlands on the Green Line D Branch. Includes 3 ramps with canopies, 2 staggered 4-car 300' raised platforms, 2 at-grade pedestrian crossings, site lighting, heated platform shelters, and covered bike racks.
5337 Stations and Facilities P0163 Forest Hills Improvement Project $0 $26,089,763 $26,089,763 Accessibility and state of good repair improvements at Forest Hills Station. Includes elevator replacement, new elevator/stair tower to connect upper and lower busway, accessibility upgrades, station brightening, wayfinding, and platform repairs.
5337 Stations and Facilities P0168 Symphony Station Improvements $35,665,778 $0 $35,665,778 Upgrade Symphony Station to a modern and fully accessible passenger facility. Includes construction of four new elevators, raised platforms, accessible restrooms, installation of egress stairs, and upgraded fire alarm systems.
5337 Stations and Facilities P0169 Wollaston Station / Quincy Center Garage Demolition $473,433 $0 $473,433 Complete modernization of Wollaston Station, demolition of the top 3 levels of the Quincy Center parking garage, replacement of one elevator at Quincy Center, and construction of an accessible walkway to Quincy Center.
5337 Stations and Facilities P0179 Winchester Center Station $5,145,827 $0 $5,145,827 Renovation of Winchester Station on the Lowell Line to provide code compliant new level-boarding height, fiber resin platforms, lighting system, accessibility ramps, elevators, walkways, variable message signs, public address system and CCTV.
5337 Stations and Facilities P0395 Worcester Union Station Accessibility and Infrastructure Improvements $2,841,410 $0 $2,841,410 Includes high-level center platform with elevators, ramps, and stairs, replacement and realignment of station tracks, and construction of a new rail crossover to improve accessibility, operations, and service capacity at Worcester Union Station.
5337 Stations and Facilities P0496 Silver Line Gateway - Phase 2 $4,654,573 $0 $4,654,573 Construction of new Chelsea Commuter Rail station with a direct connection to the Silver Line. Includes new platforms, canopies, foundation systems, signage, track infrastructure, train signals, power cable duct banks, and BRT grade crossings.
5337 Stations and Facilities P0856 Ruggles Station Improvements Phase 2 $0 $66,059,036 $66,059,036 Continuation of improvements under P0175 focused on travel paths, alternate egress of Orange Line subway and Commuter Rail platforms, accessible restrooms, public address systems, electrical and fire protection upgrades, and roof replacement.
5337 Stations and Facilities P0923 E Branch Accessibility & Capacity Improvements $0 $66,050,285 $66,050,285 Improvements to surface track and stations on the E-Branch of the Green Line, extending from the Northeastern Station portal to Heath Street Station.
5337 Stations and Facilities P0924 B Branch Accessibility & Capacity Improvements $0 $46,269,972 $46,269,972 Track realignments, accessibility improvements, potential consolidation, and station and traction power upgrades along the Green Line B Branch, between Blandford St and Warren St stations.
5337 Stations and Facilities P1010 Riverside Vehicle Maintenance Facility Modifications & Upgrades $0 $39,480,004 $39,480,004 Upgrades to existing hoists, pits, and mezzanines at the Riverside Vehicle Maintenance Facility to accommodate the future Type 10 fleet.
5337 Stations and Facilities P1011 Green Line Extension Vehicle Maintenance Facility Modifications & Upgrades $0 $9,943,730 $9,943,730 Design and installation of a new hoist at the Green Line Extension (GLX) Vehicle Maintenance Facility to accommodate the future Type 10 fleet.
5337 Stations and Facilities P1101 Lake Street Complex Demolition and Reconfiguration $0 $5,242,850 $5,242,850 Demolition of the Lake Street facility and reconfiguration into an expanded yard. The site will be designed to maximize train storage, streamline yard operations, and eliminate a sharp curve in anticipation of the larger Type 10 light rail fleet.
5337 Stations and Facilities P1103 Reservoir Yard and Non-Revenue Track Optimization and Reconfiguration $0 $23,005,694 $23,005,694 Reconfiguration of various track elements at Reservoir including: the lower west yard, East/West Wye, Chestnut Hill Avenue connection, B-Branch connection, and non-revenue track around Cleveland Circle.
5337 Stations and Facilities P1144 Commuter Rail Facilities State of Good Repair $0 $62,960,000 $62,960,000 Funding to support Commuter Rail facilities improvements including design support contracts, roof and roof equipment replacement, WiFi and IT infrastructure, fluid systems, and maintenance of way facilities.
5337 Stations and Facilities R0071 Lynn Station Improvements Phase II $0 $13,230,566 $13,230,566 Design funding for new elevators, stairs, platform, canopy, and architectural improvements to the station and the intent to acquire and demolish structures under station's viaduct. Existing parking garage will also be replaced by surface parking.
$53,377,021 $446,824,549 $500,201,570
5339 - Bus and Bus Facility
5339 Bus and Bus Facilities P0653 Procurement of 40ft Battery Electric Buses and Related Infrastructure $11,155,225 $32,334,607 $43,489,832 Purchase of 80 40ft battery electric buses (BEBs) to replace fleets currently running diesel bus service out of Quincy and trolleybus service out of North Cambridge.
$11,155,225 $32,334,607 $43,489,832

Note: Project descriptions and dollar amounts are preliminary only and are provided for informational purposes. In many cases, the scopes of work and project budgets will become more fully developed as the design process proceeds and is completed. The MBTA may also opt to fund a project from a different FTA funding source based on the timing of projects and the availability of FTA funds.

RRIF/TIFIA Financing Program
Projects Potentially Funded by Federal RRIF/TIFIA Loans
RRIF/TIFIA Financing P0671a Bus Facility Modernization Program - Quincy Bus Facility
RRIF/TIFIA Financing P0952 Future Regional Rail Layover Planning
RRIF/TIFIA Financing P0018 North Station Draw 1 Bridge Replacement
RRIF/TIFIA Financing P0170 Newton Commuter Rail Stations
RRIF/TIFIA Financing P0178 South Attleboro Station Improvements
RRIF/TIFIA Financing P0863 South-Side CR Maintenance Facility

Note: The MBTA is exploring the use of federal loans through the Build America Bureau to finance certain capital projects at a lower interest rate than traditional tax-exempt bonds. This includes loans under the Railroad Rehabilitation & Improvement Financing (RRIF) and Transportation Infrastructure Finance and Innovation Act (TIFIA) programs. The projects listed above are being considered for this program, subject to the approval of funding through the CIP process. Additional project and funding information will be provided through a future TIP/Amendment if federal grant funds or loans are utilized.

Table 3-10
FFYs 2023–27 TIP Transit Table (MWRTA)

Project Number RTA Program Project Name Notes Federal Fiscal Year  Total Cost  Bond Cap | State | 100% State Bond Cap | Match | Federal Transit Discretionary Grant Federal | FTA | Section 5307 Federal | FTA | Section 5339 Statewide Federal | FTA | Federal Transit Discretionary Grant Operating | Additional State Assistance | State Contract Assistance Federal | FHWA | Transportation Development Credits
FFY 2023
RTD0011099 MWRTA Operating Operating Assistance Non-Fixed Route ADA Paratransit Service Operating assistance for non-fixed route ADA paratransit service 2023 $2,000,000 $0 $0 $1,600,000 $0 $0 $400,000 $0
RTD0011100 MWRTA Transit | RTA Facility and Vehicle Maintenance Acquisition of Bus Support Equipment/Facilities Acquire after-market vehicle accessories (i.e., passenger counters, DVR - vehicle recorders, annunciators) 2023 $150,000 $30,000 $0 $120,000 $0 $0 $0 $0
RTD0011101 MWRTA Transit | RTA Facility and System Modernization Technology Support/Capital Outreach Mobility management; IT; Call center; Travel training enhancements/improvements; MWRTA applies for competitive funding for this line item and will reduce the RTACAP request upon award of additional federal funds. 2023 $200,000 $40,000 $0 $160,000 $0 $0 $0 $0
RTD0011102 MWRTA Transit | RTA Facility and Vehicle Maintenance Terminal, Intermodal (Transit) - Blandin MWRTA will utilize these funds to maintain a state-of-good-repair value of at least 3.5 for the operations and administration facility along with all amenities and support equipment located at 15 Blandin Ave, Framingham, MA. 2023 $425,000 $85,000 $0 $340,000 $0 $0 $0 $0
RTD0011108 MWRTA Transit | RTA Facility and Vehicle Maintenance Terminal, Intermodal (Transit) - Framingham Commuter Rail Station (FCRS) Intermodal at the Framingham Commuter Rail Station (FCRS) enhancements/improvements; MWRTA applies for competitive funding for this line item and will reduce the RTACAP request upon award of additional federal funds. 2023 $5,000 $1,000 $0 $4,000 $0 $0 $0 $0
RTD0011113 MWRTA Transit | RTA Vehicle Replacement 5339 Competitive Revenue Vehicle Replacement - Discretionary Buy replacement vehicles; 6 D(b)CNGs + 6 E2s Gas 2023 $731,500 $146,300 $0 $0 $0 $585,200 $0 $0
RTD0011127 MWRTA Transit | RTA Facility and Vehicle Maintenance Back Entrance Project - Discretionary Enlarge the operations center of dispatch, administration offices, and driver training rooms of revenue service contractor. Installation of HVAC ERU (energy recovery unit). 2023 $2,000,000 $0 $400,000 $0 $0 $1,600,000 $0 $0
RTD0011128 MWRTA Transit | RTA Facility and System Modernization Electronic Sign Board Install electronic sign boards at high demand locations and enhance accessibility of digital rider tools. 2023 $200,000 $40,000 $0 $160,000 $0 $0 $0 $0
RTD0011129 MWRTA Transit | RTA Facility and System Modernization CRT North Framingham Bike/Pedestrian Connectivity - Cochituate Rail Trail North Framingham Feasibility Study - Discretionary Cochituate Rail Trail North Framingham Feasibility Study - Expand bike/pedestrian connectivity and emerging technologies to support last-mile connections. 2023 $95,000 $0 $19,000 $0 $0 $76,000 $0 $0
RTD0011122 MWRTA Transit | RTA Fleet Upgrades 2023 Electric Vehicle Migration Modernization fleet electrification - Vehicle migration - Purchase of 5 paratransit (Type A) electric vehicles. MWRTA is seeking an 8-year migration to fully electric vehicles. This request is supported in MWRTA's TAM to maintain useful life benchmarks of the agency's paratransit fleet and is in support of Gov. Baker's 2020 Transportation Climate Initiative (TCI). 2023 $100,000 $20,000 $0 $80,000 $0 $0 $0 $0
RTD0011135 MWRTA Transit | RTA Vehicle Replacement Vehicle Replacement - Cutaways (12) #2 of 2 FY23 #1 of 2 5339 $330k + RTACAP $165k;  FY23 #2 of 2 5307 $330k + RTACAP $165k for 6 D(b) w/CNG + 6 E2s Gasoline. 2023 $495,000 $165,000 $0 $0 $330,000 $0 $0 $0
FFY 2024
RTD0011103 MWRTA Operating Operating Assistance Non-Fixed Route ADA Paratransit Service Operating assistance for non-fixed route ADA paratransit service 2024 $2,000,000 $0 $0 $1,600,000 $0 $0 $400,000 $0
RTD0011104 MWRTA Transit | RTA Facility and Vehicle Maintenance Acquisition of Bus Support Equipment/Facilities Acquire after-market vehicle accessories (i.e., passenger counters, DVR - vehicle recorders, annunciators) 2024 $150,000 $30,000
